The Story of Project
Construction Process
Infrastructure Strategy & Projections
May 2026

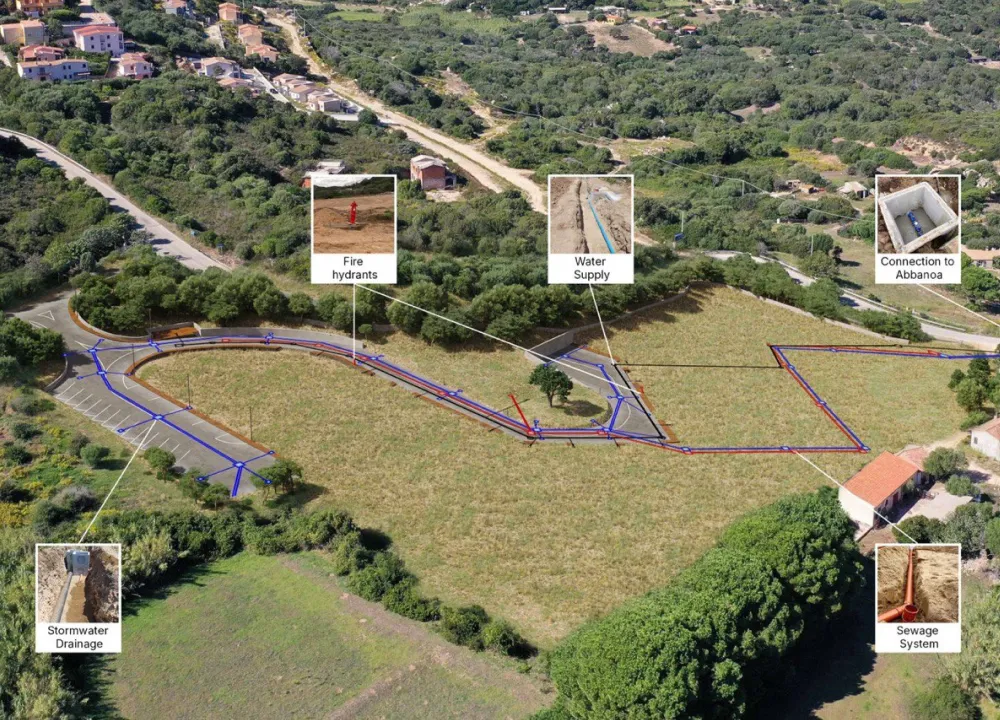

1. Water Supply

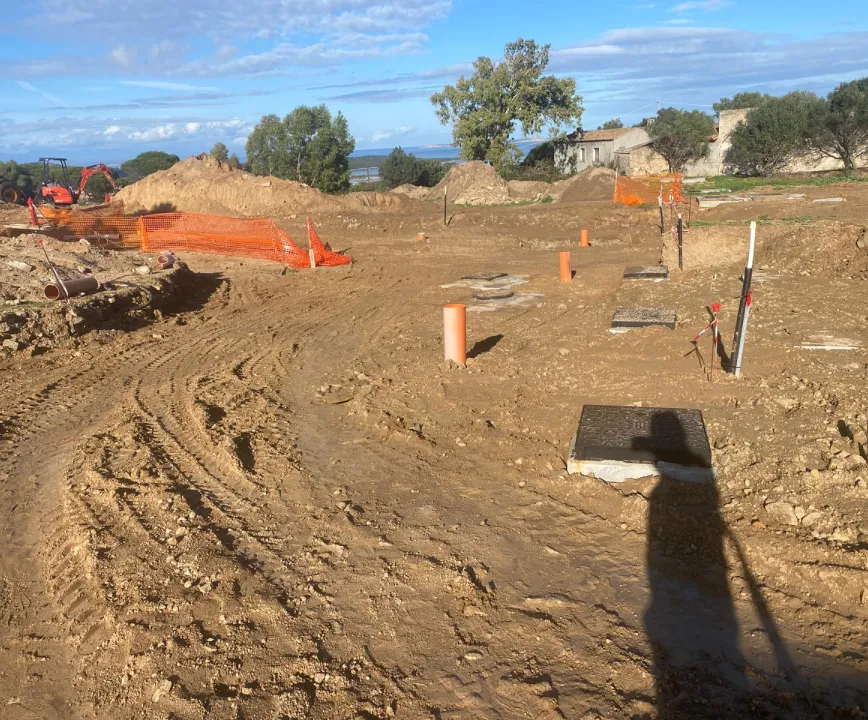

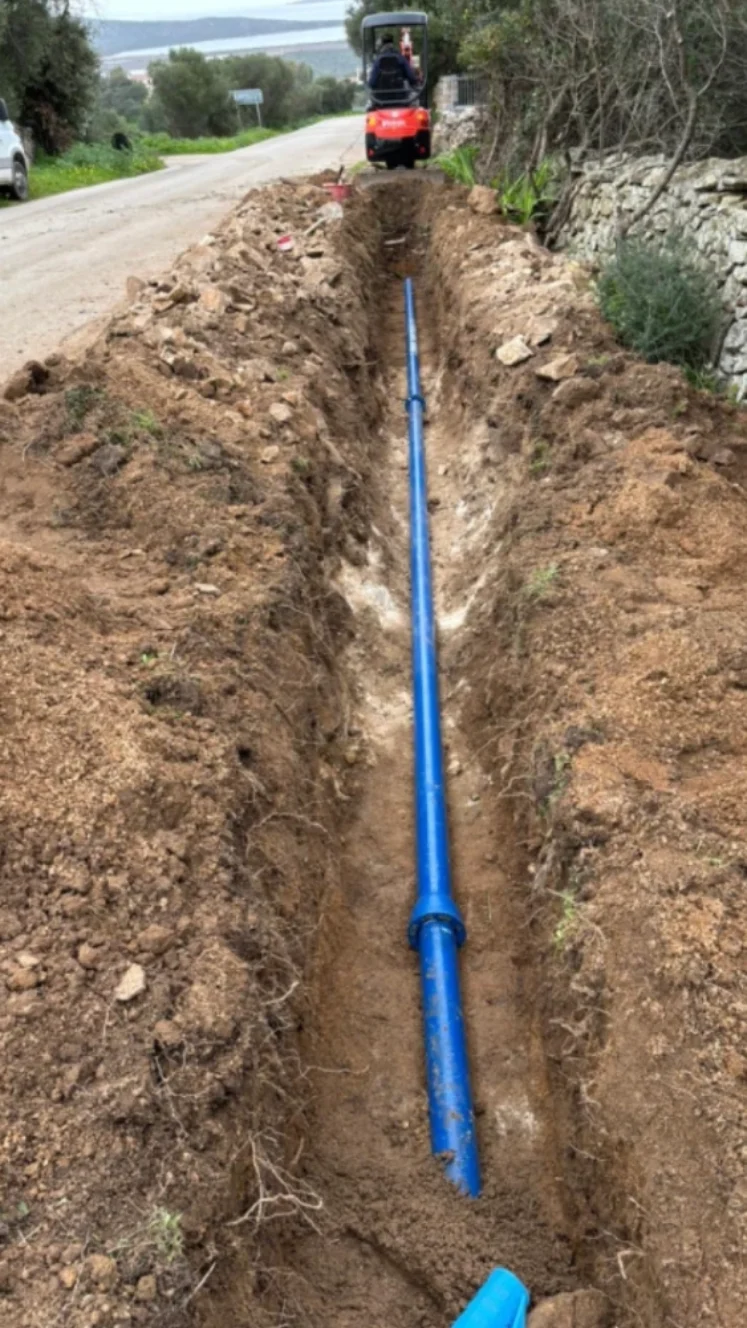

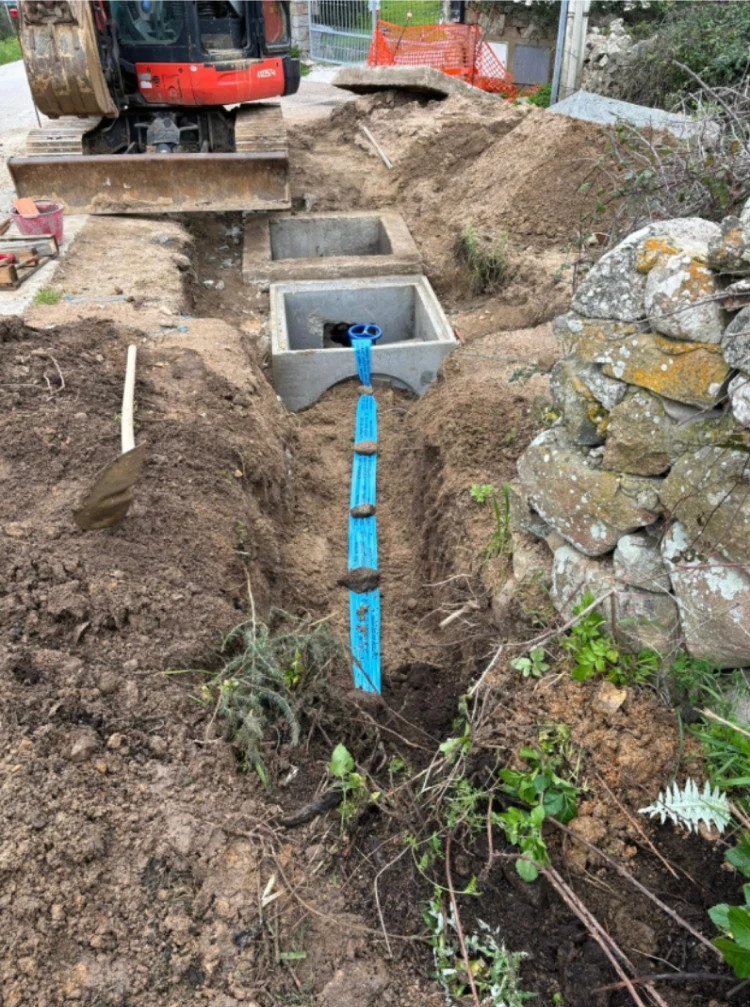

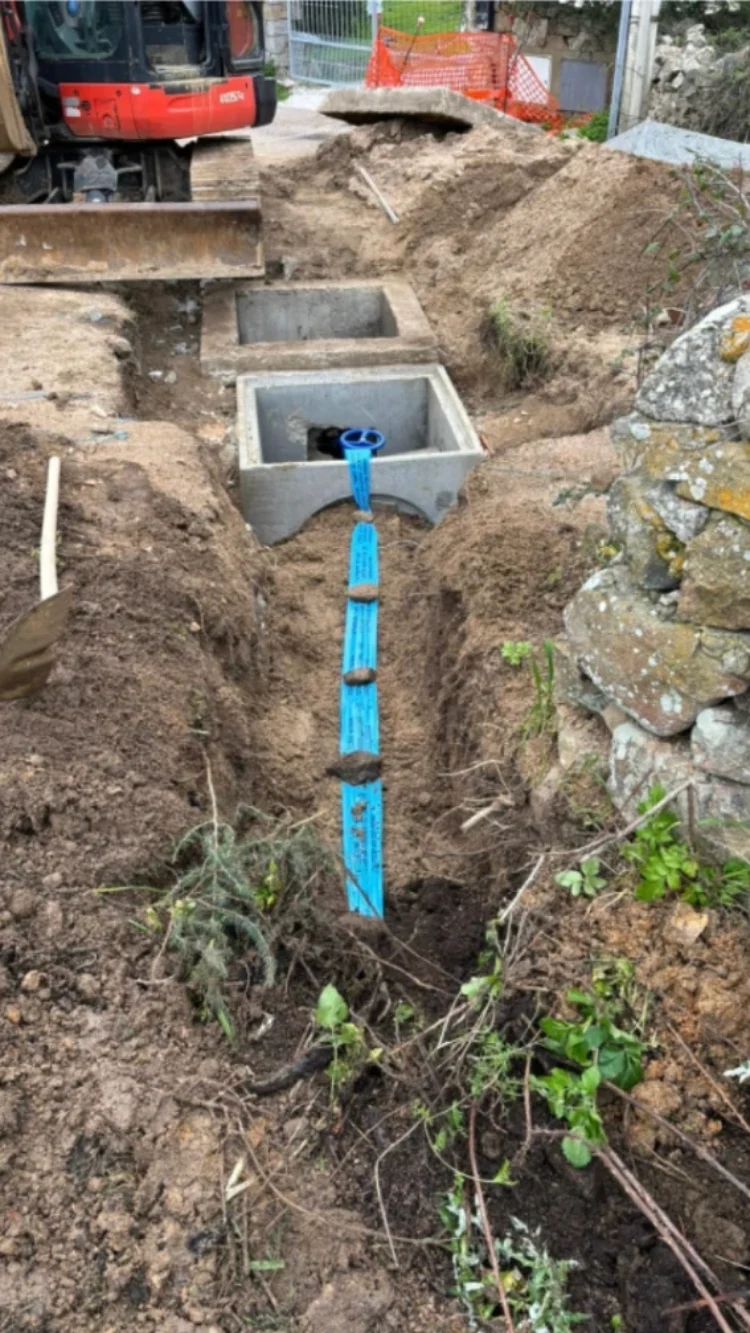

- Water main installed throughout the residential complex with connections provided to each lot.

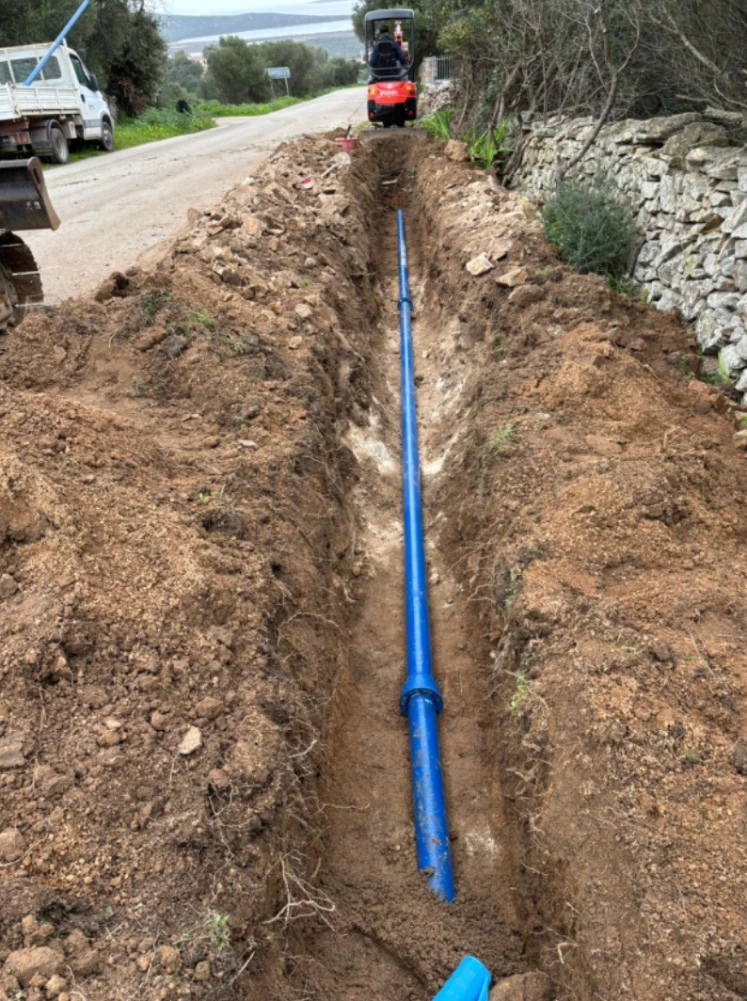

- Connection to Abbanoa (main water utility point) completed.

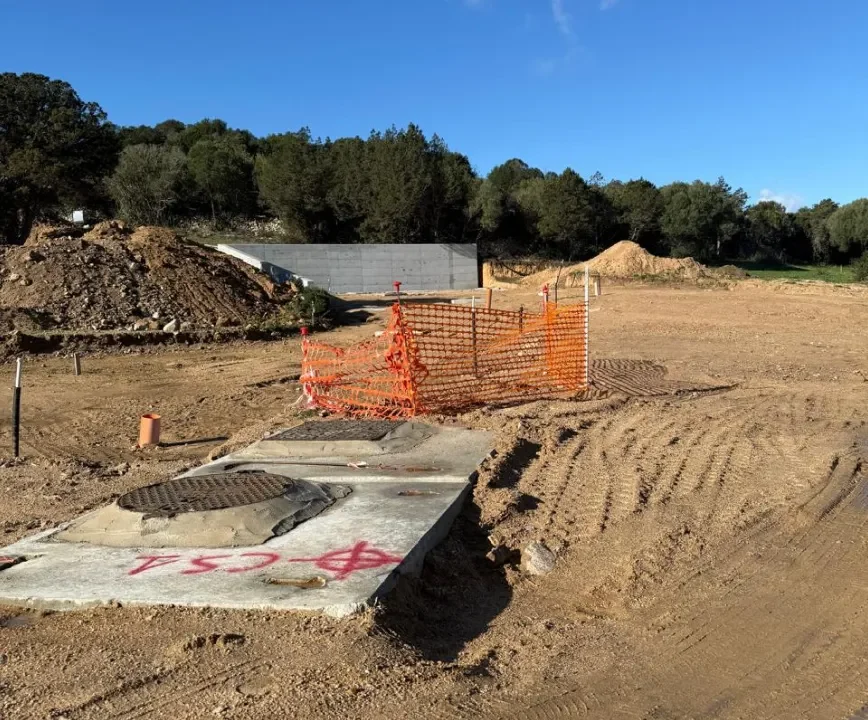

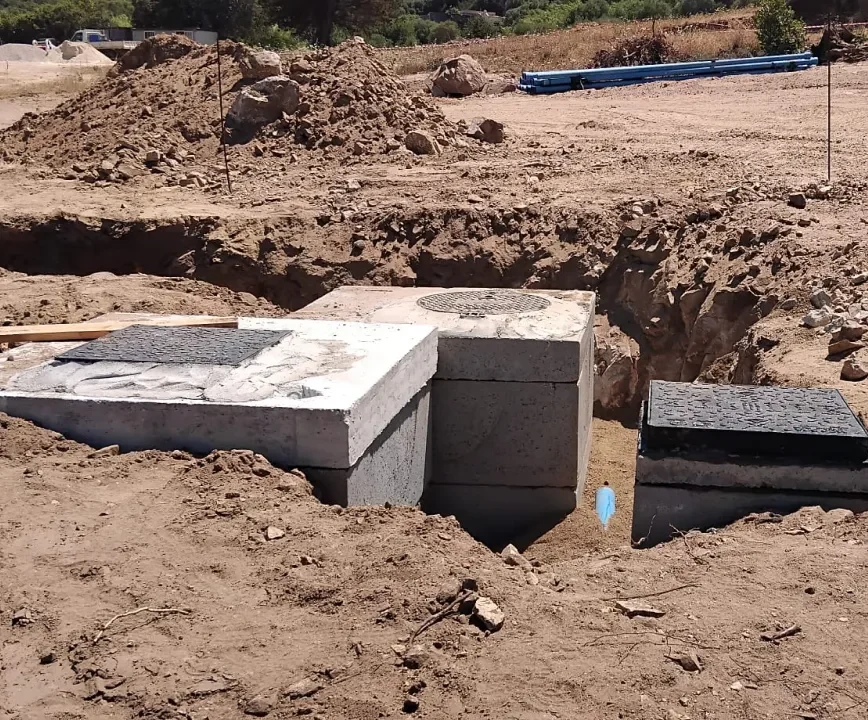

2. Sewage System

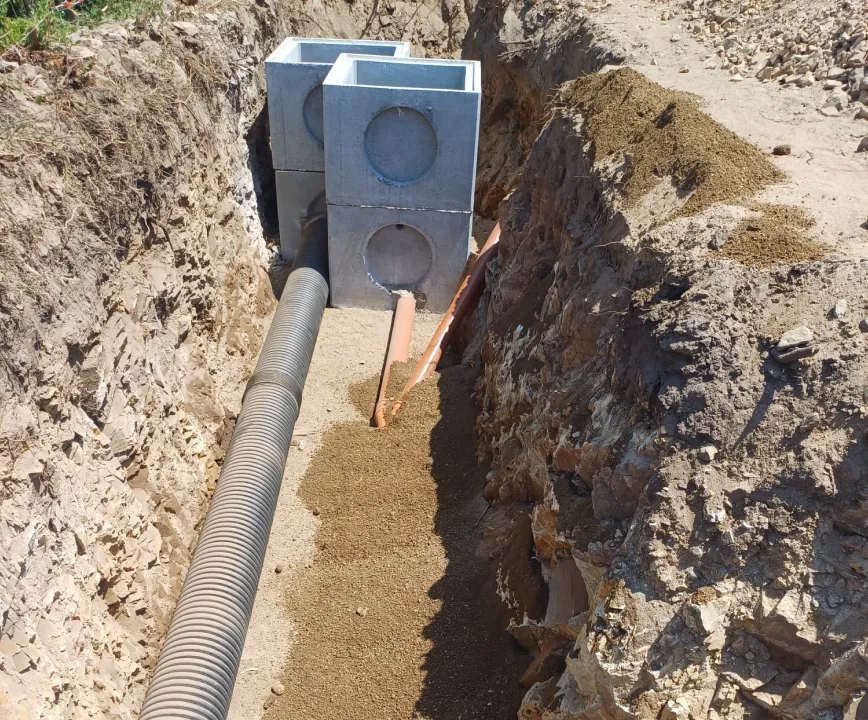

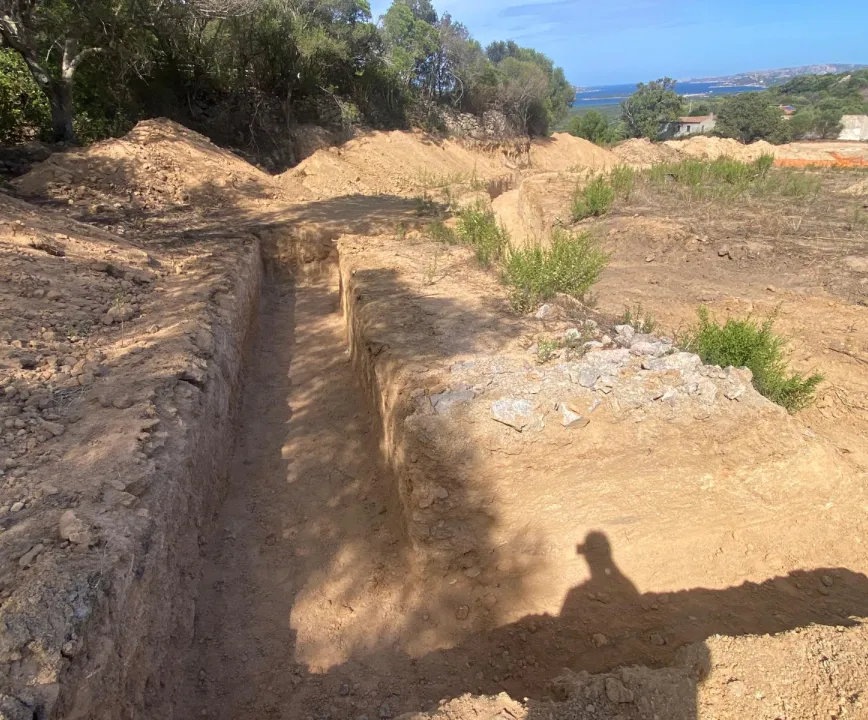

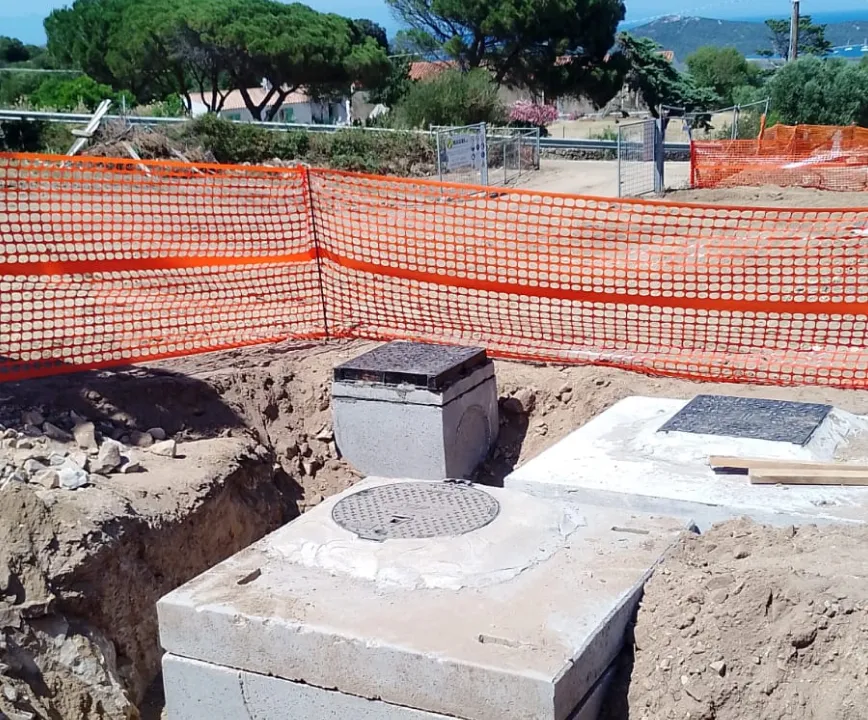

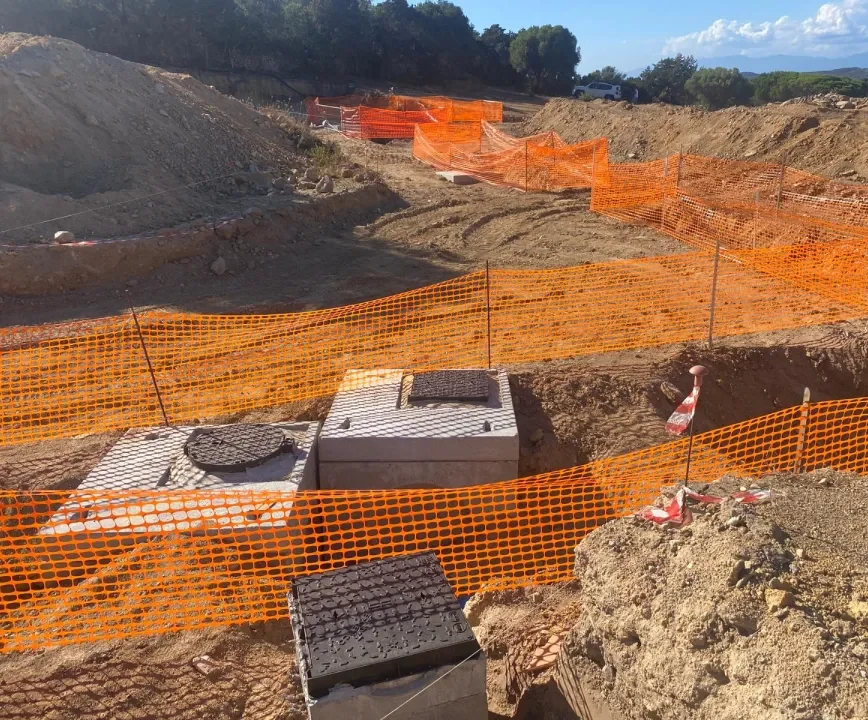

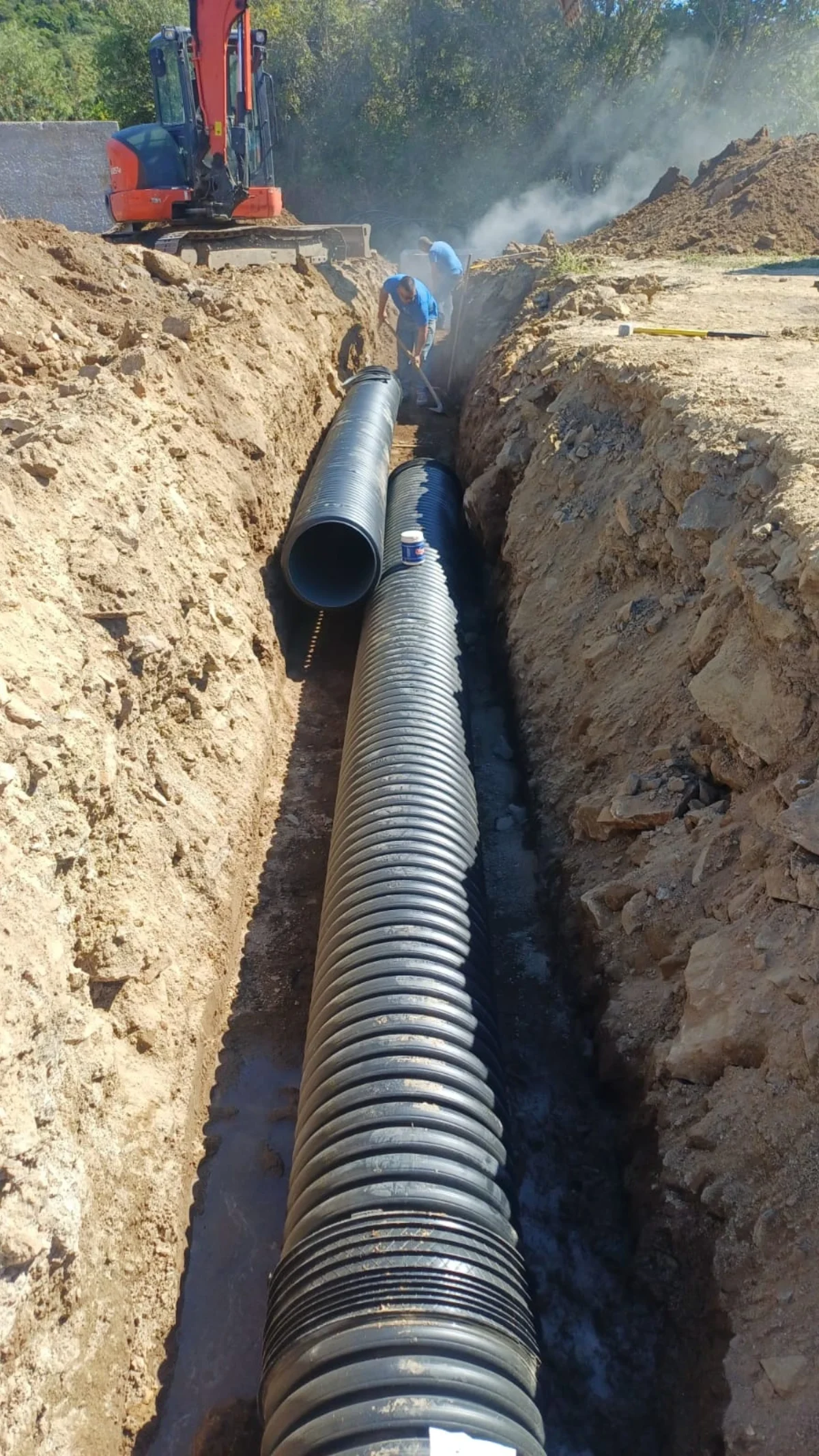

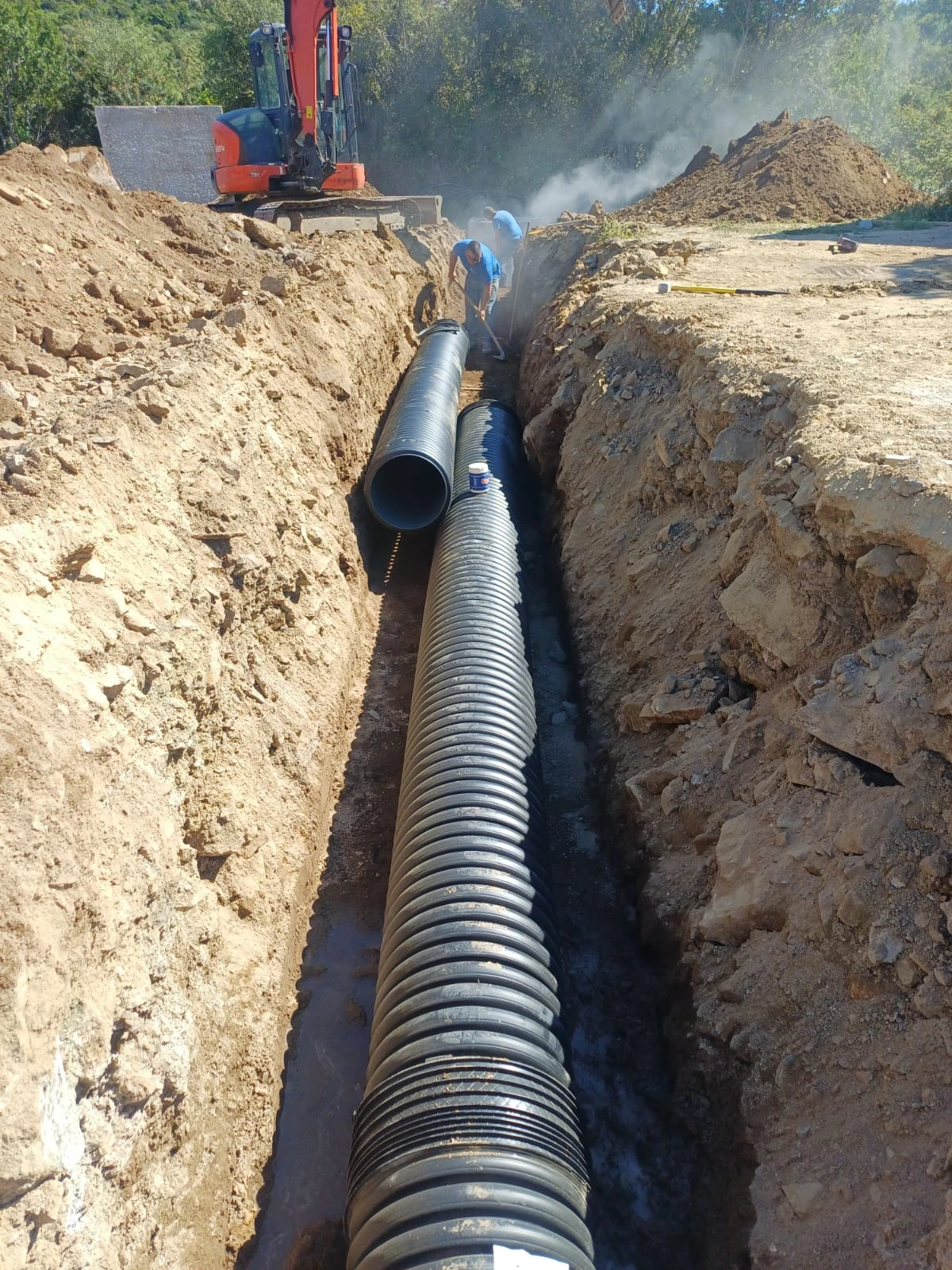

- Sewage pipeline installed throughout the residential complex with connections provided to each lot.

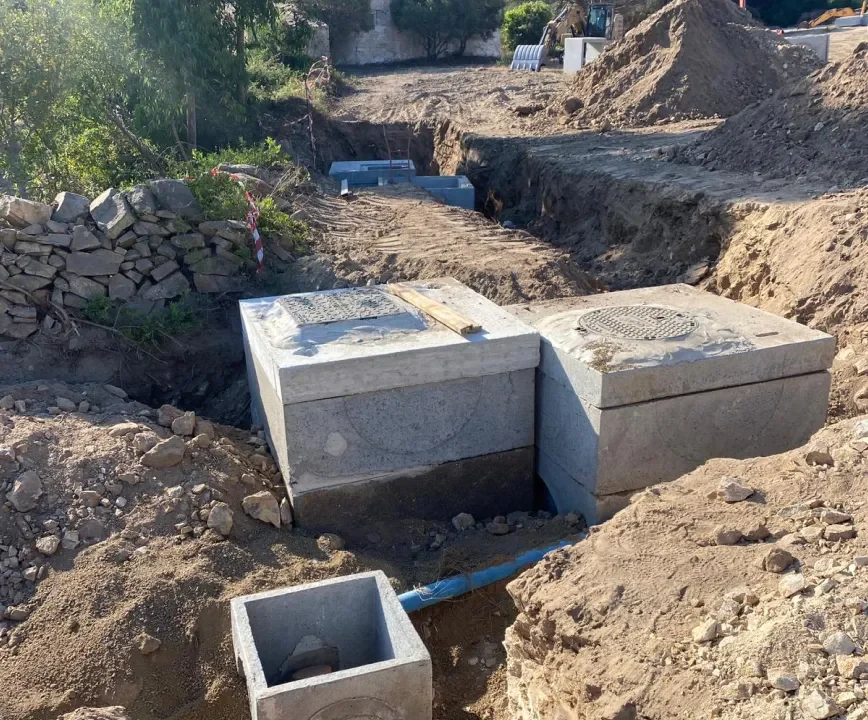

- Connection to the public sewage network completed.
3. Stormwater Drainage

- Stormwater drainage system installed throughout the residential complex.
4. Fire Safety

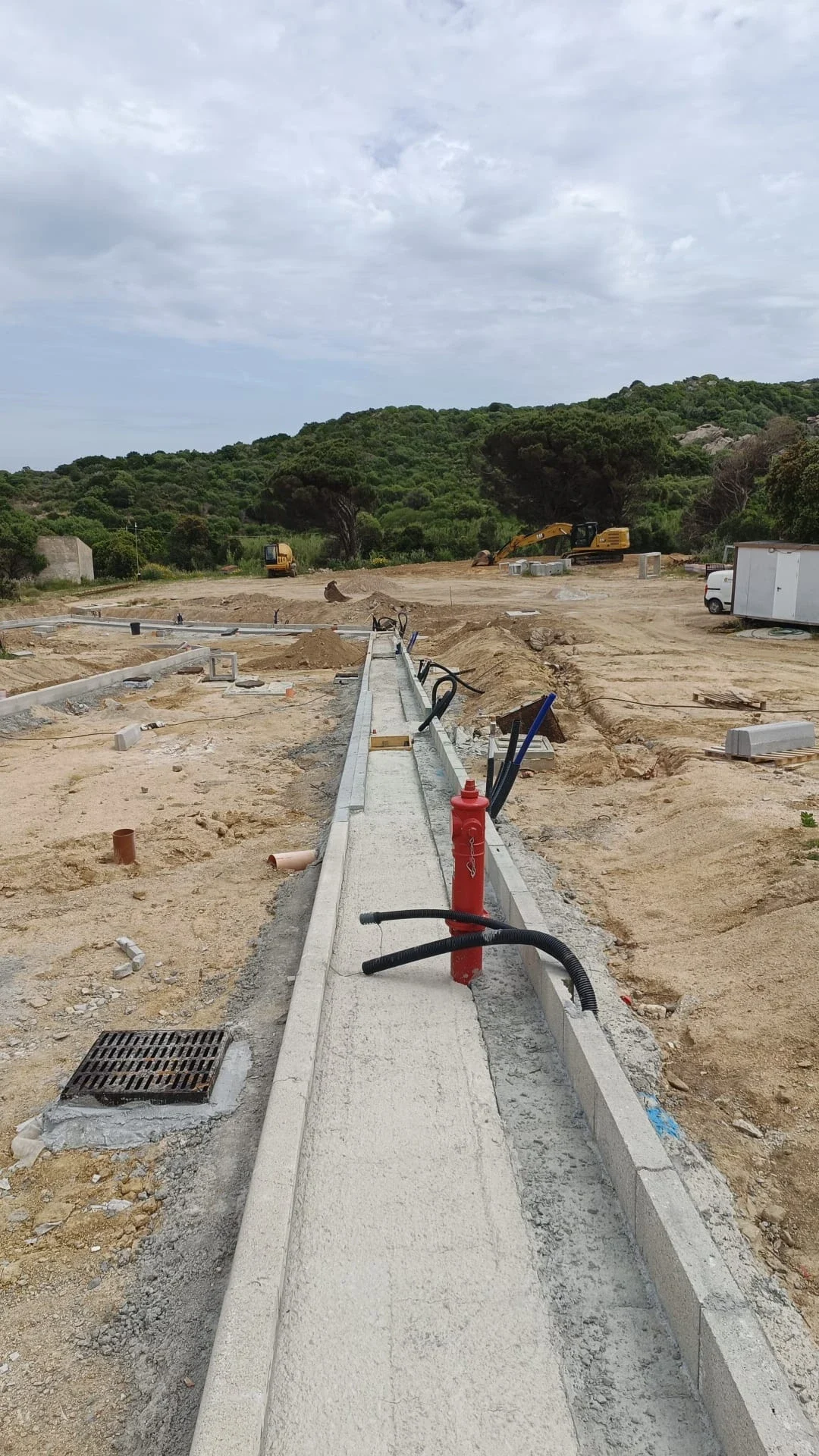

- Two fire hydrants installed on-site.
5. Electrical & Low Current

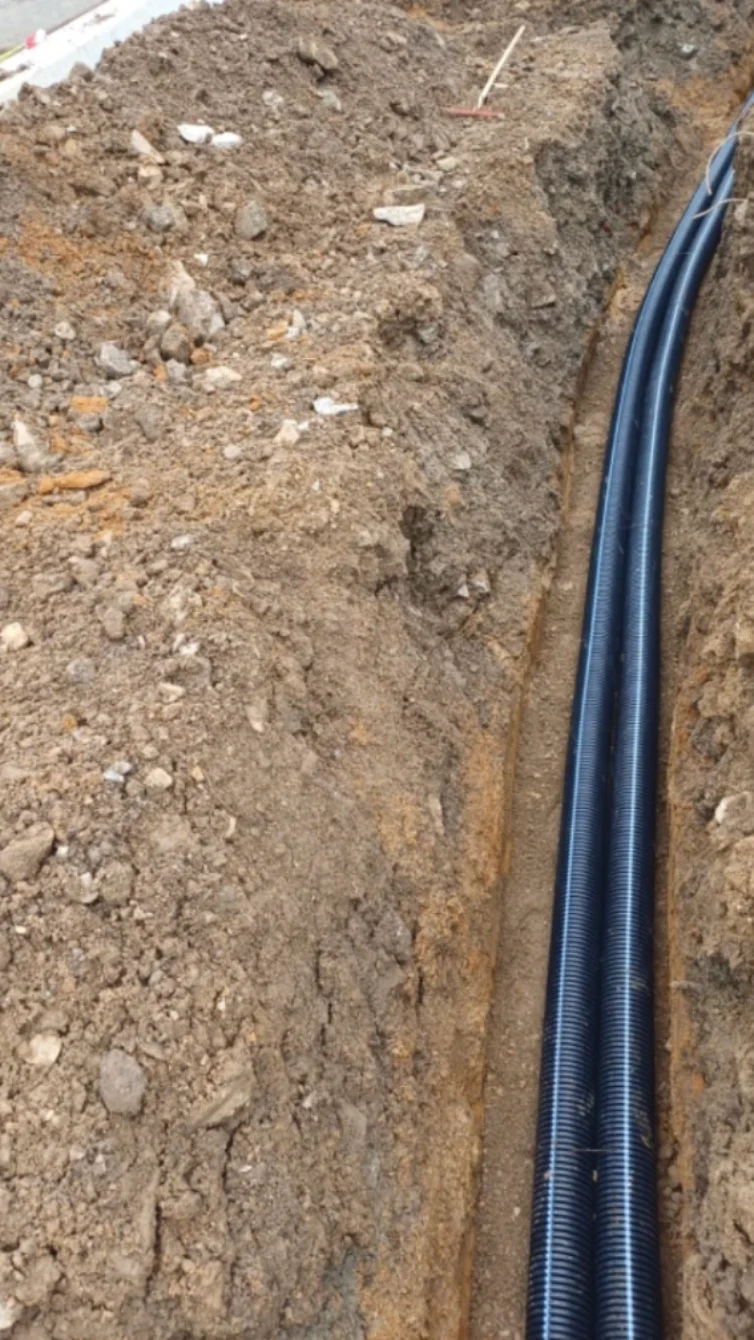

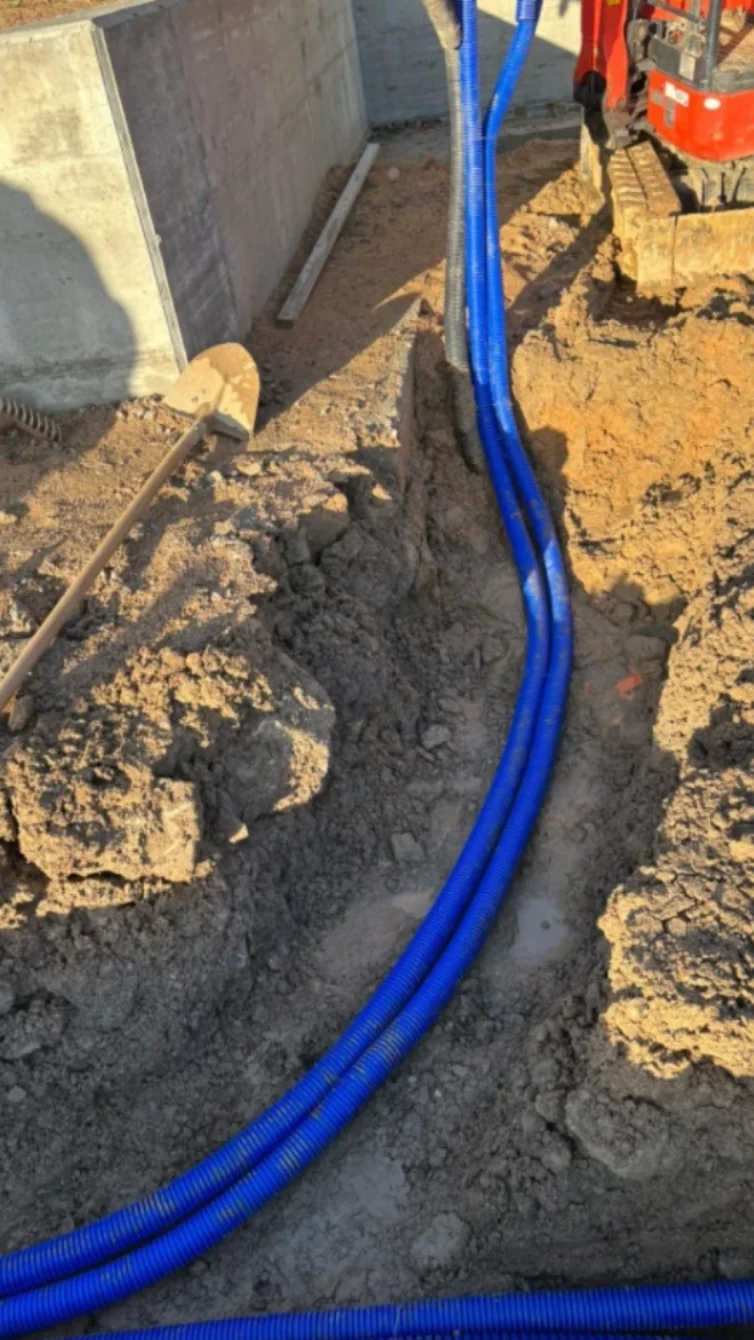

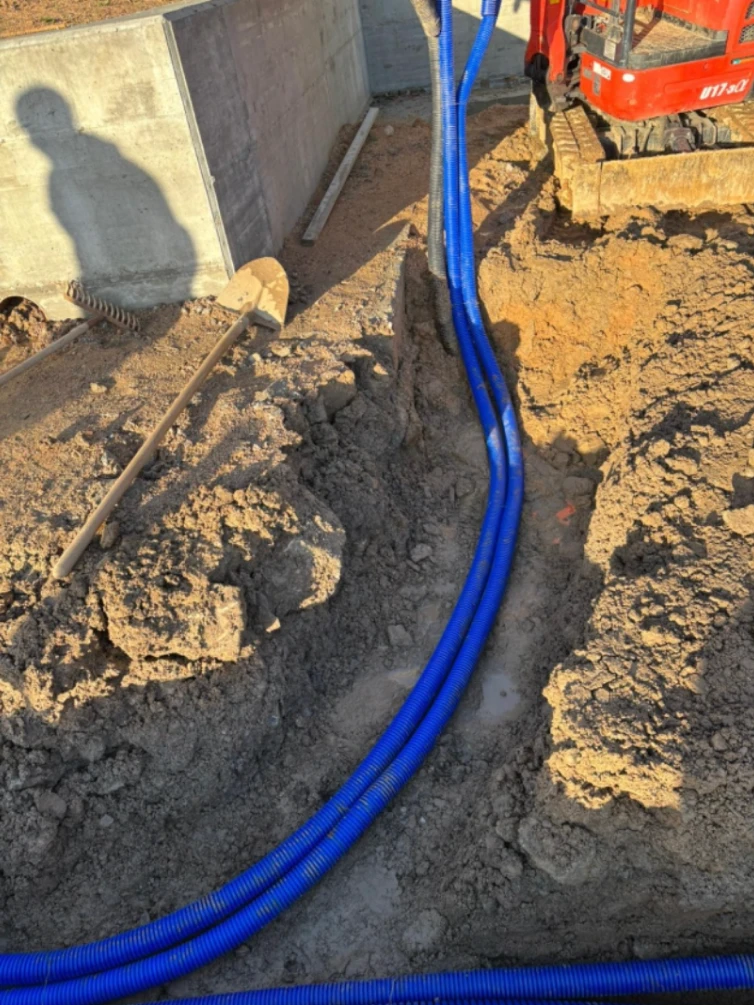

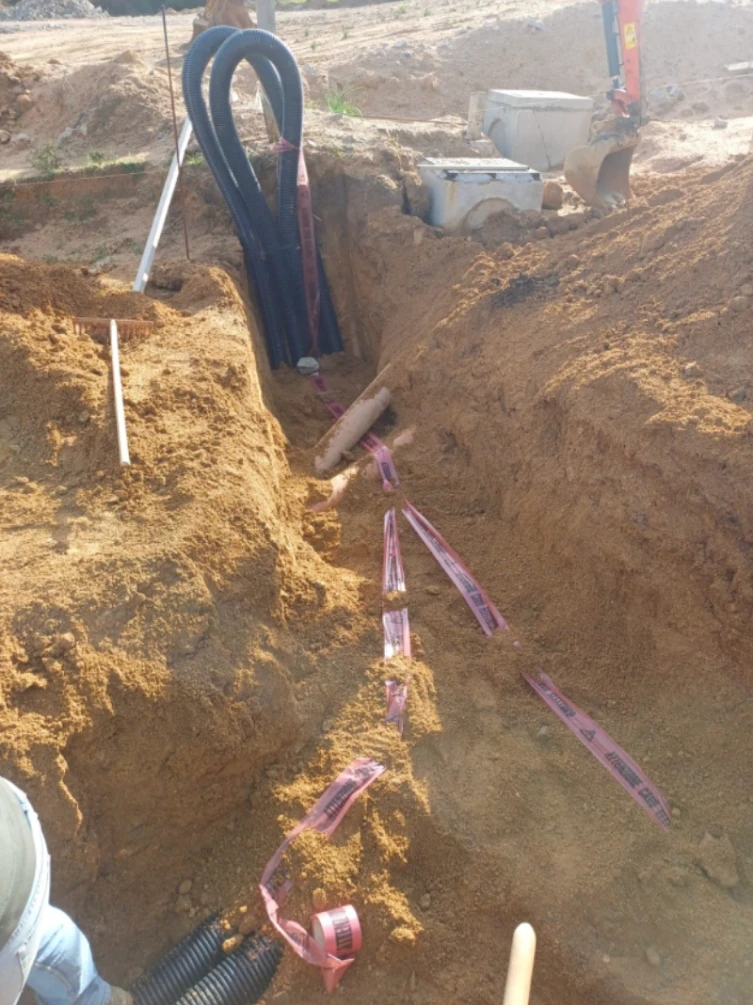

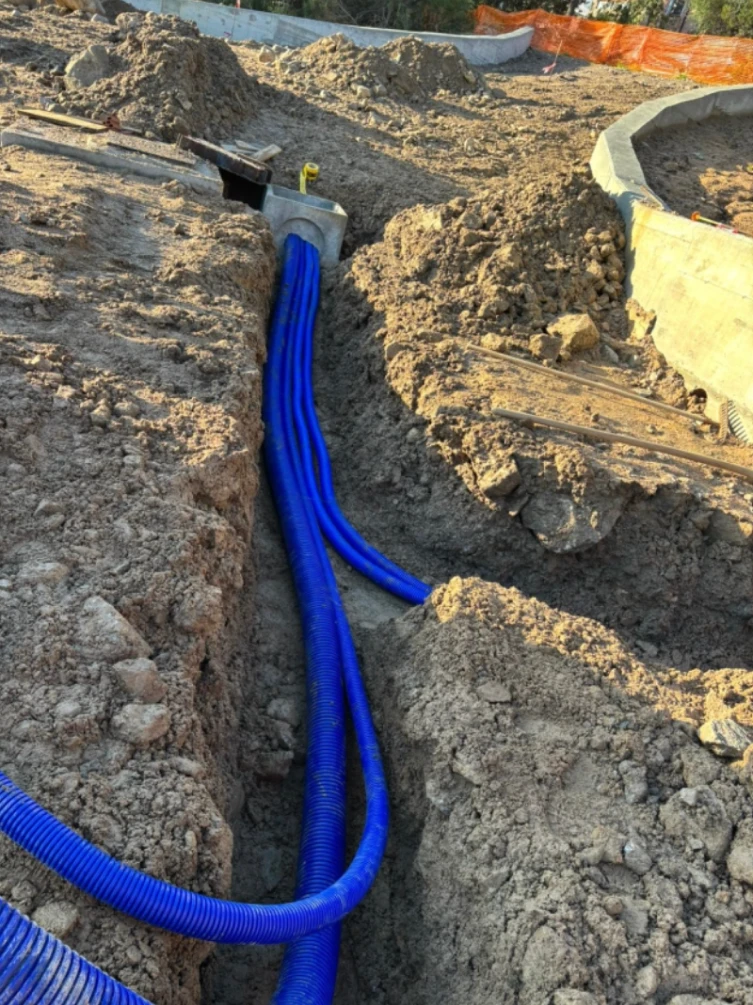

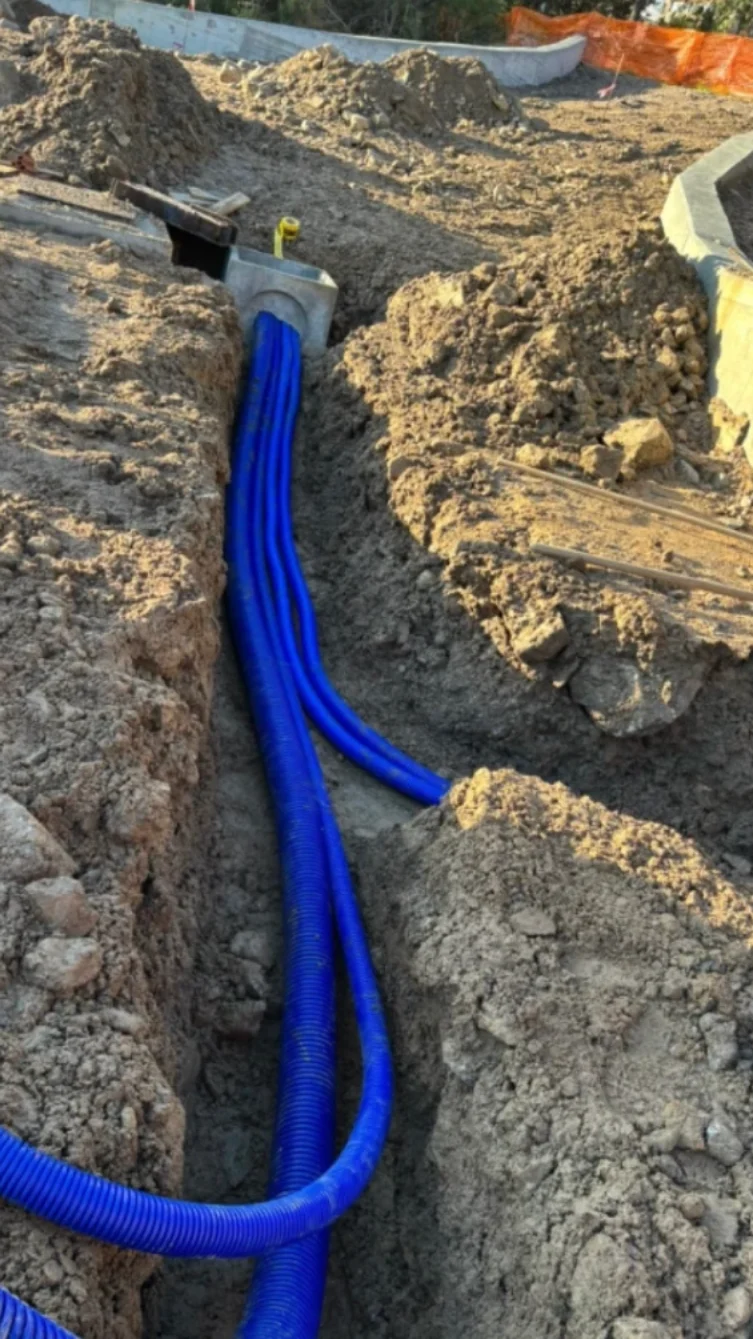

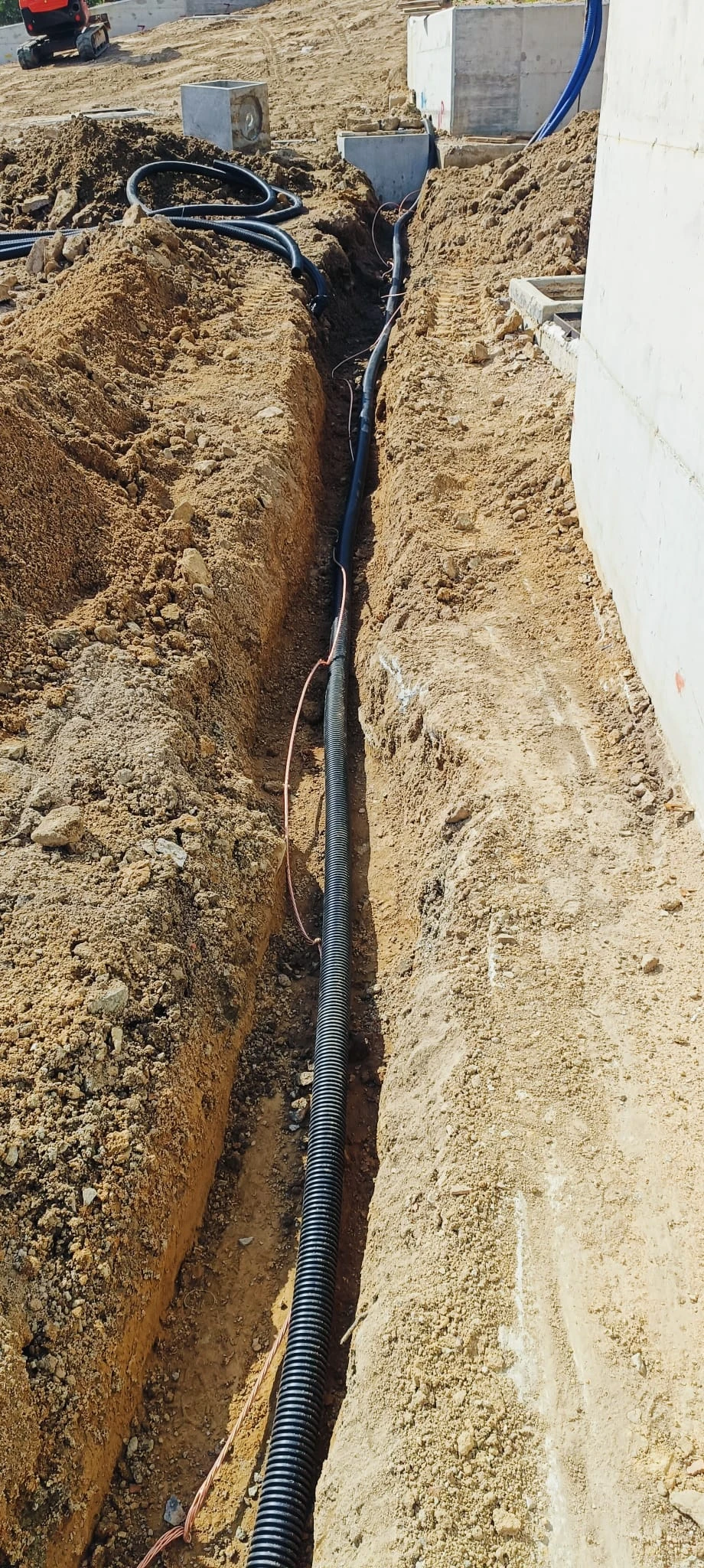

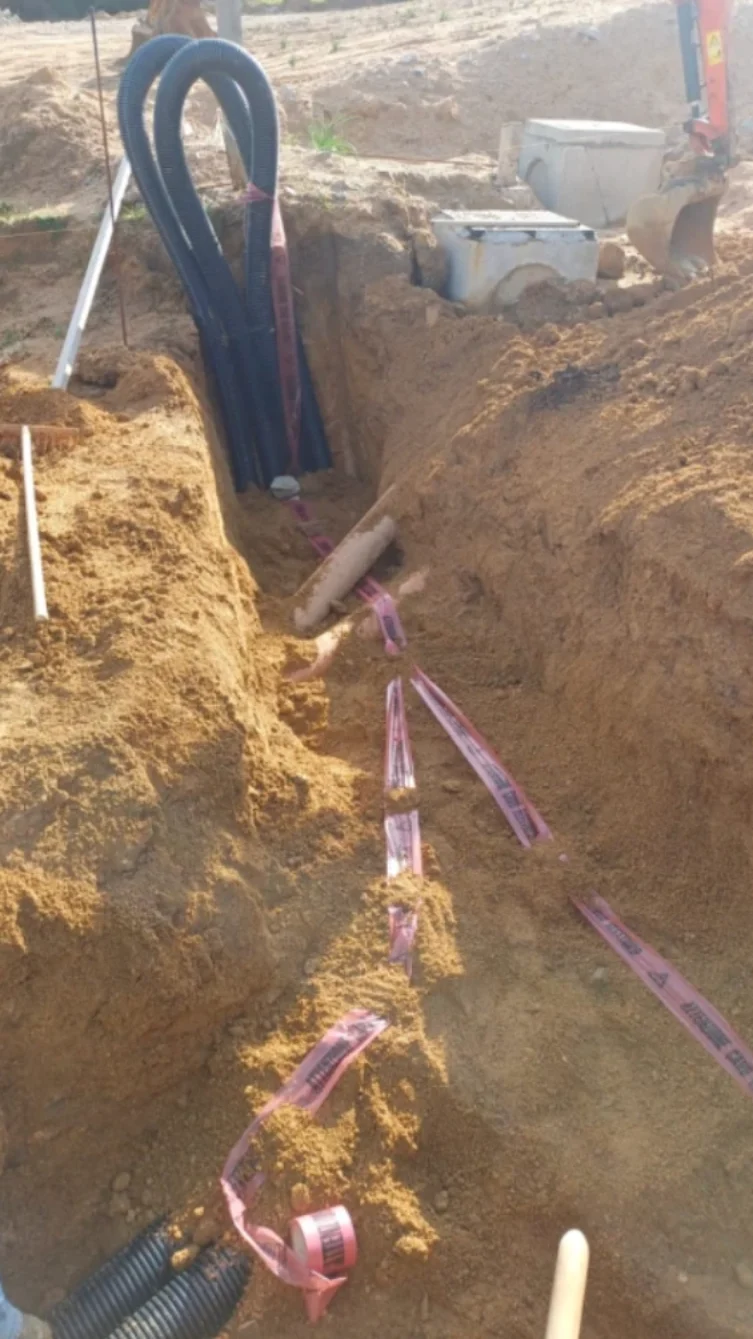

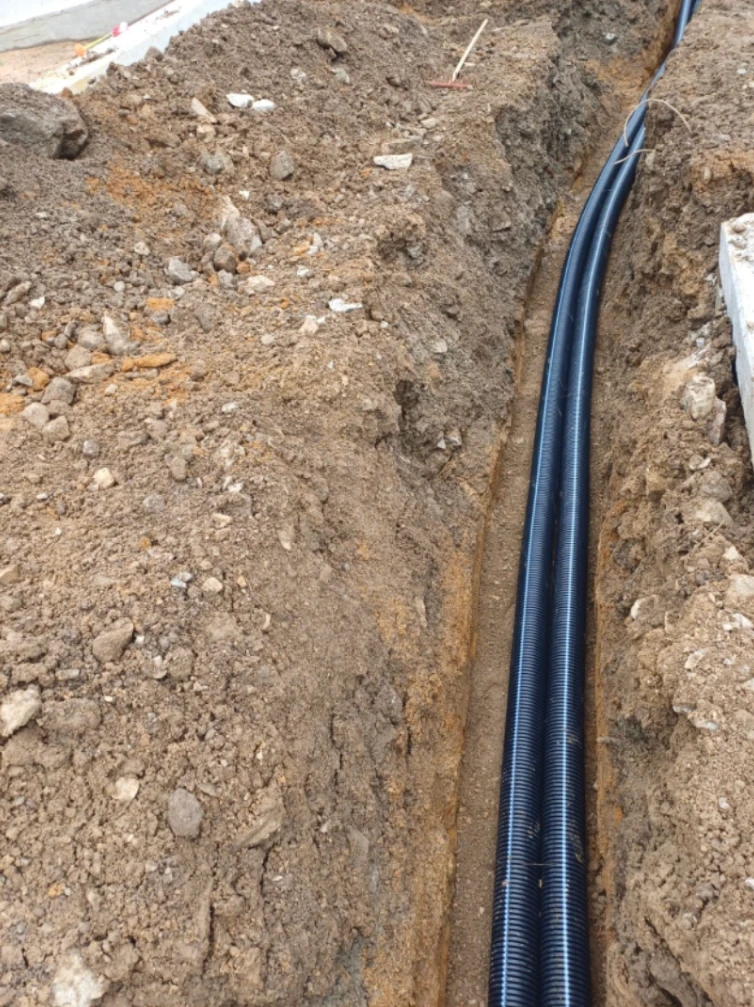

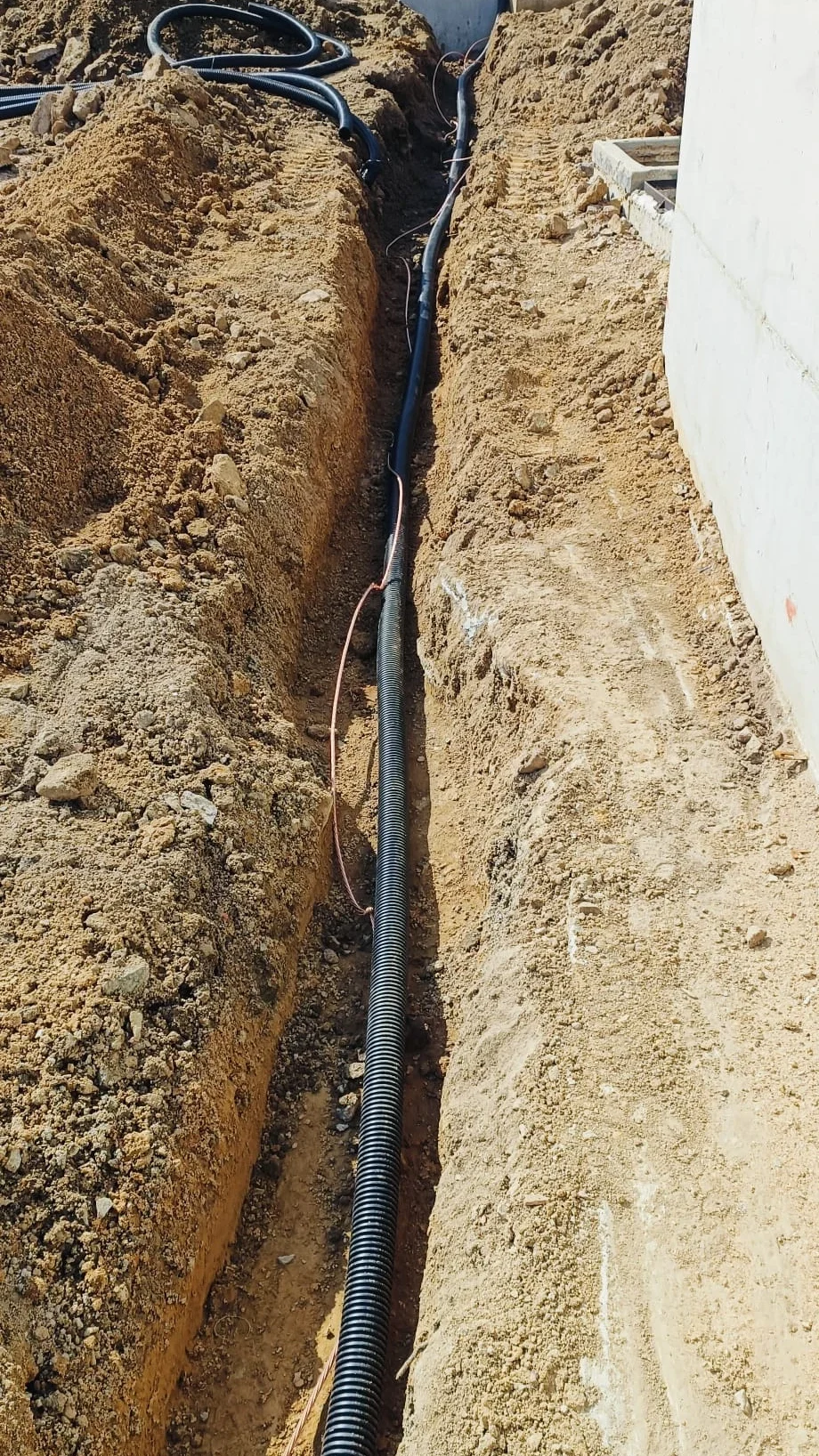

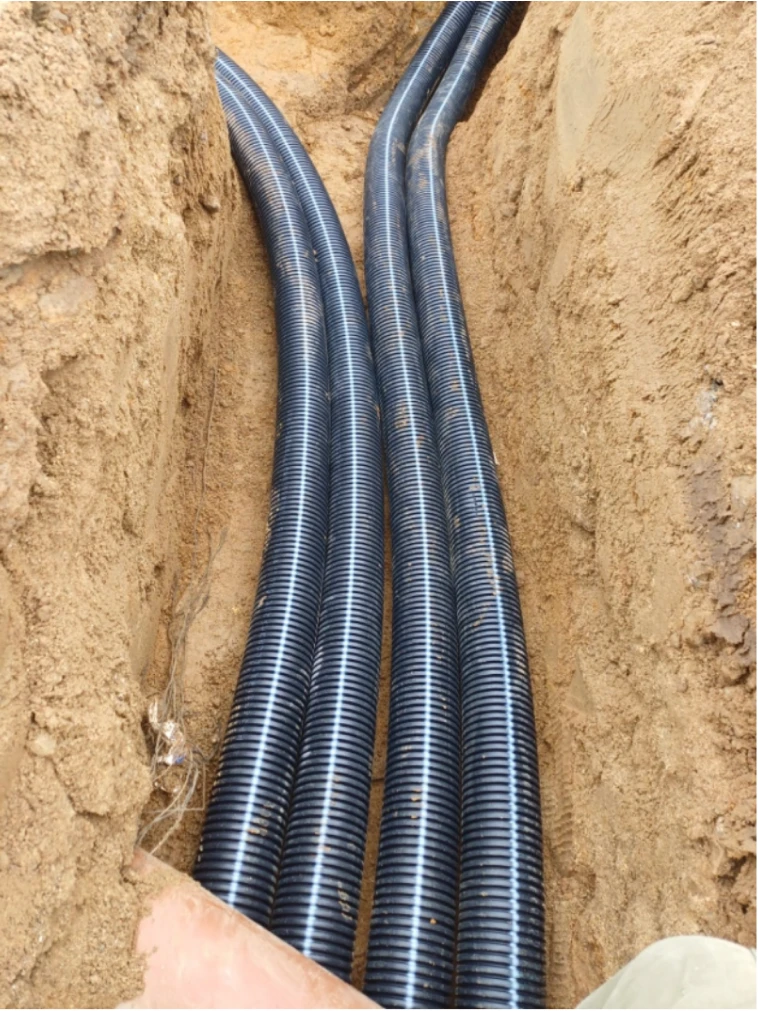

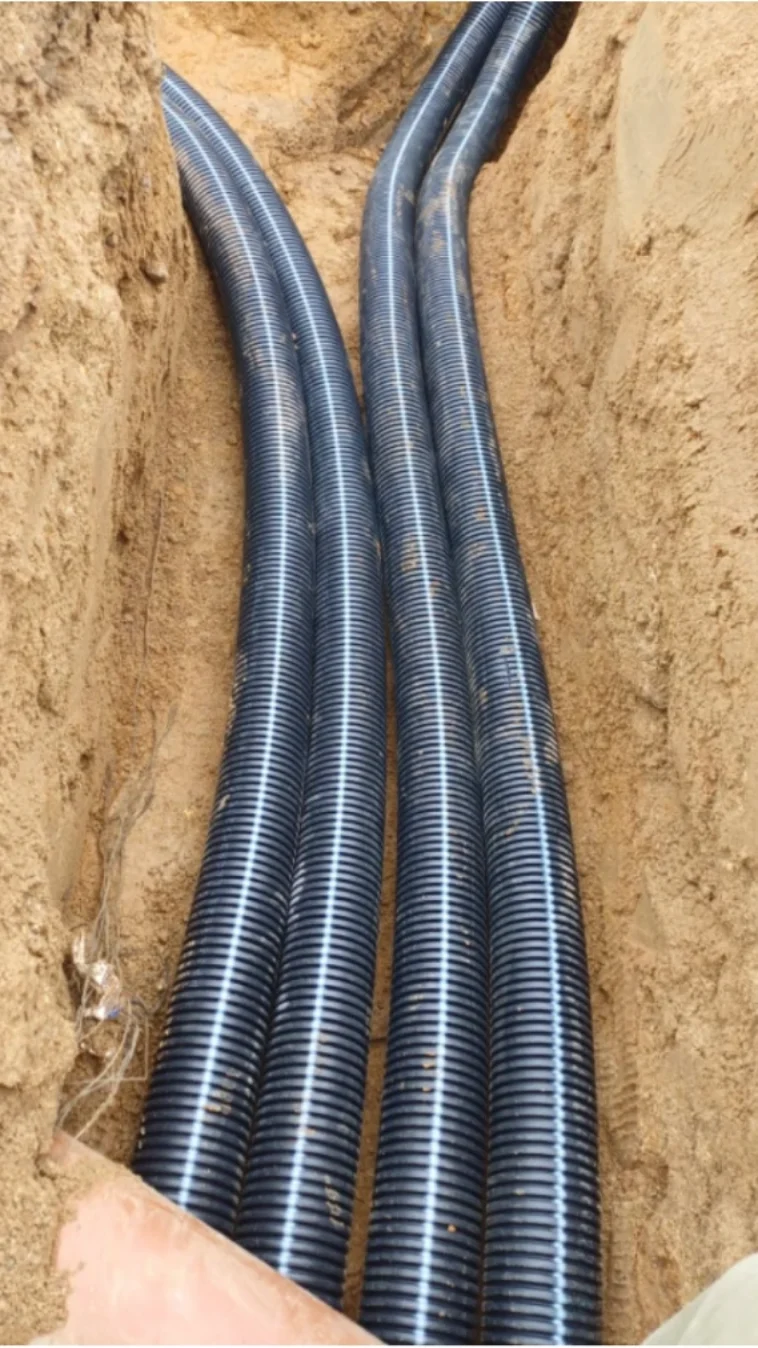

- Conduits for electricity and low-current cables have been laid.
- Transformer substation installed to ensure power supply.

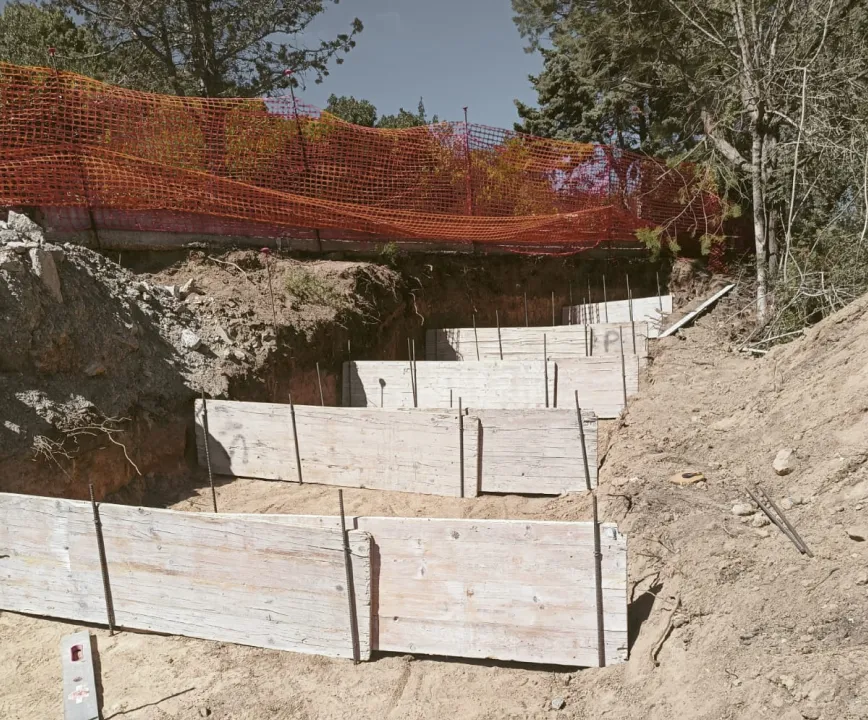

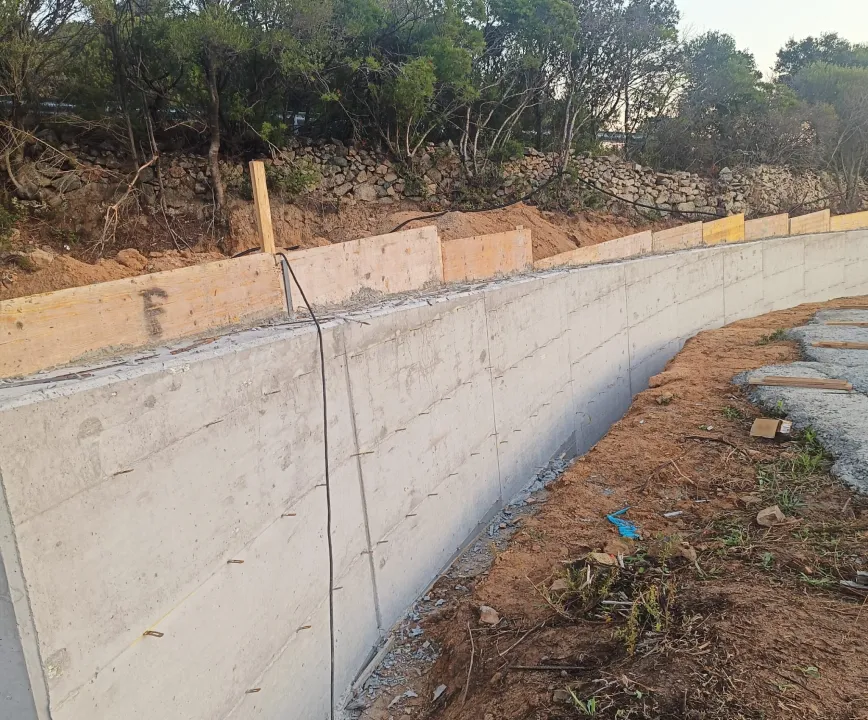

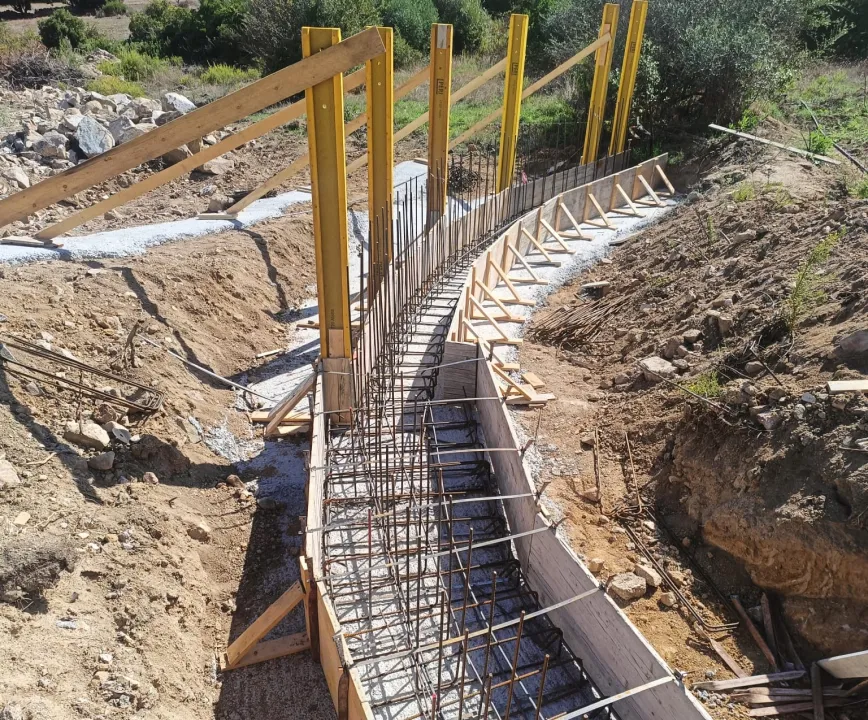

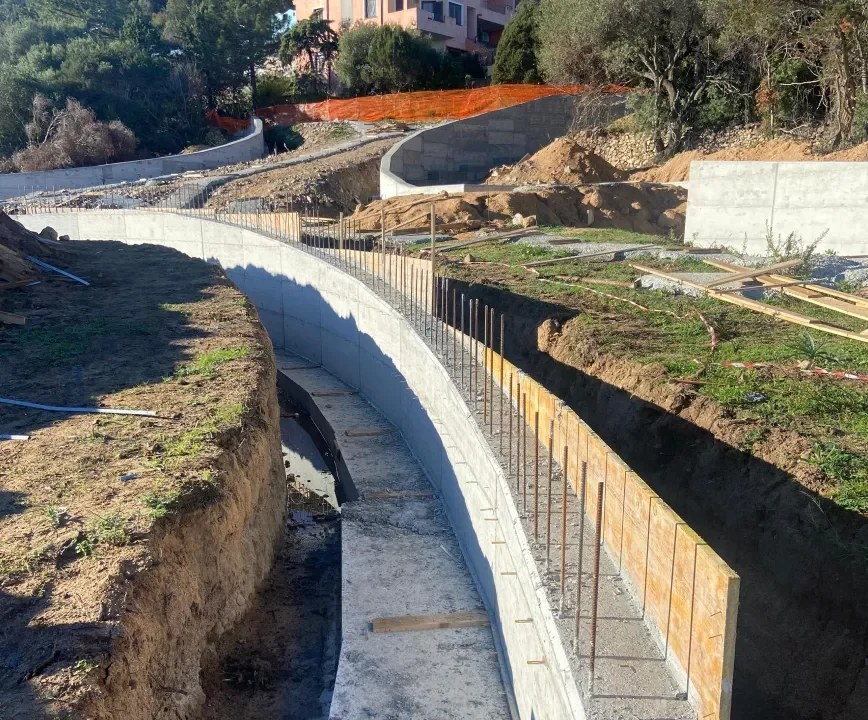

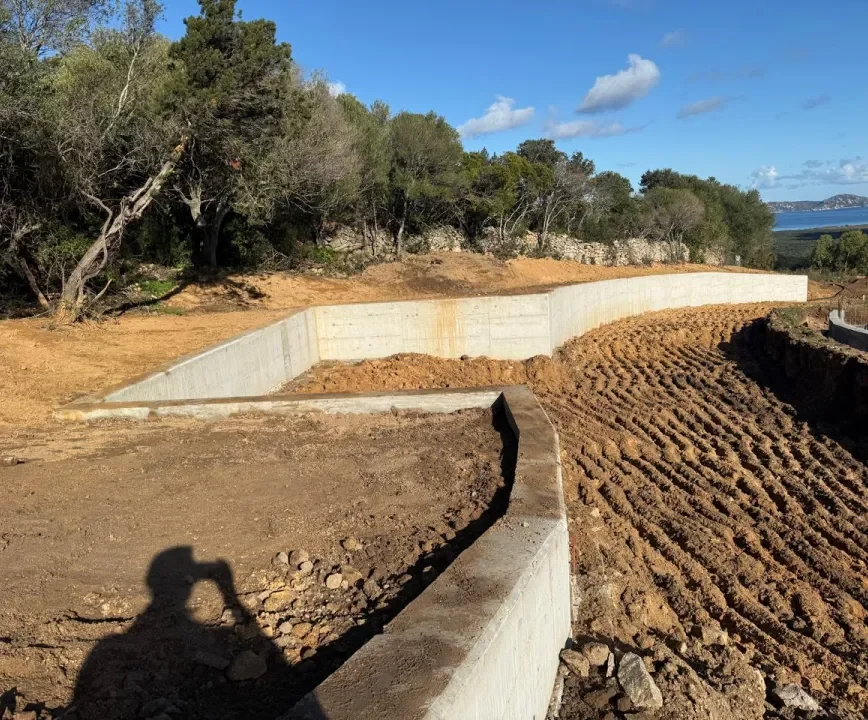

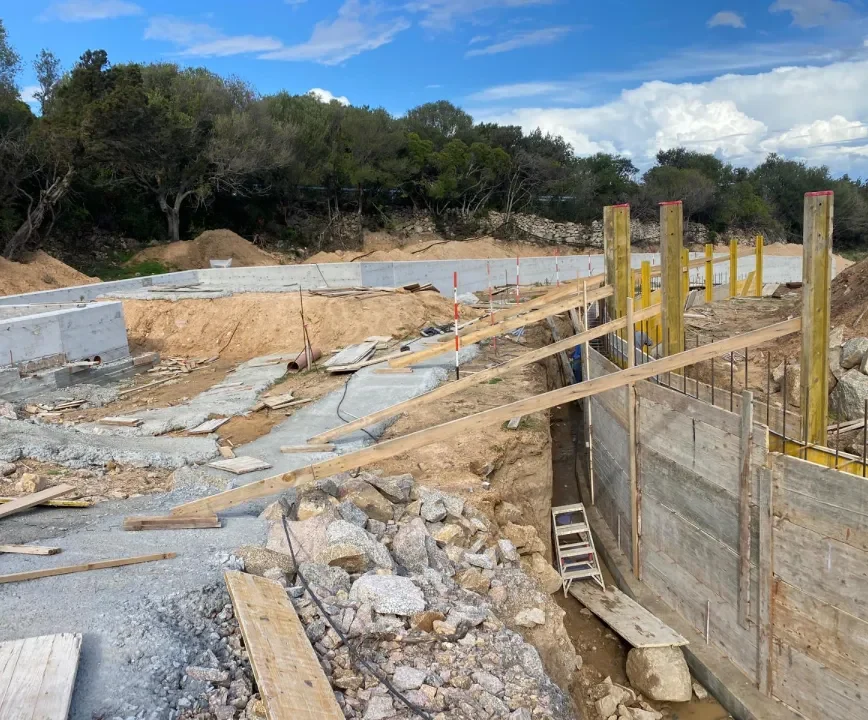

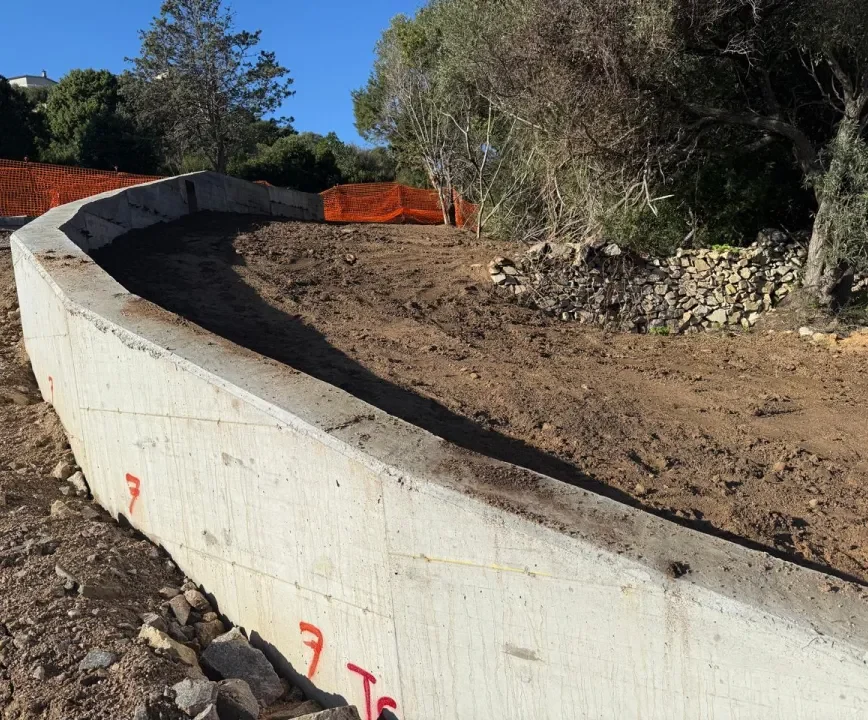

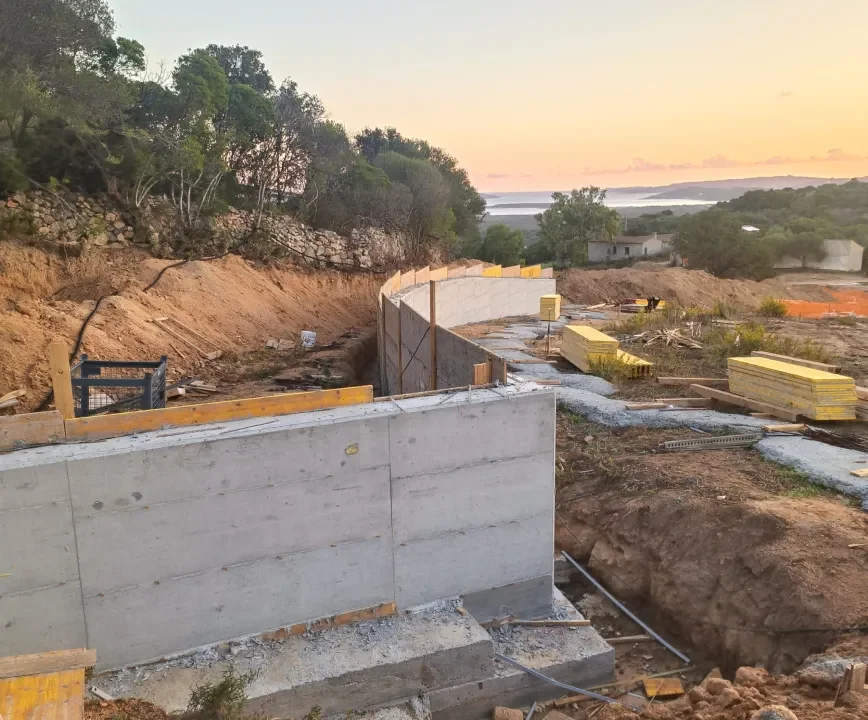

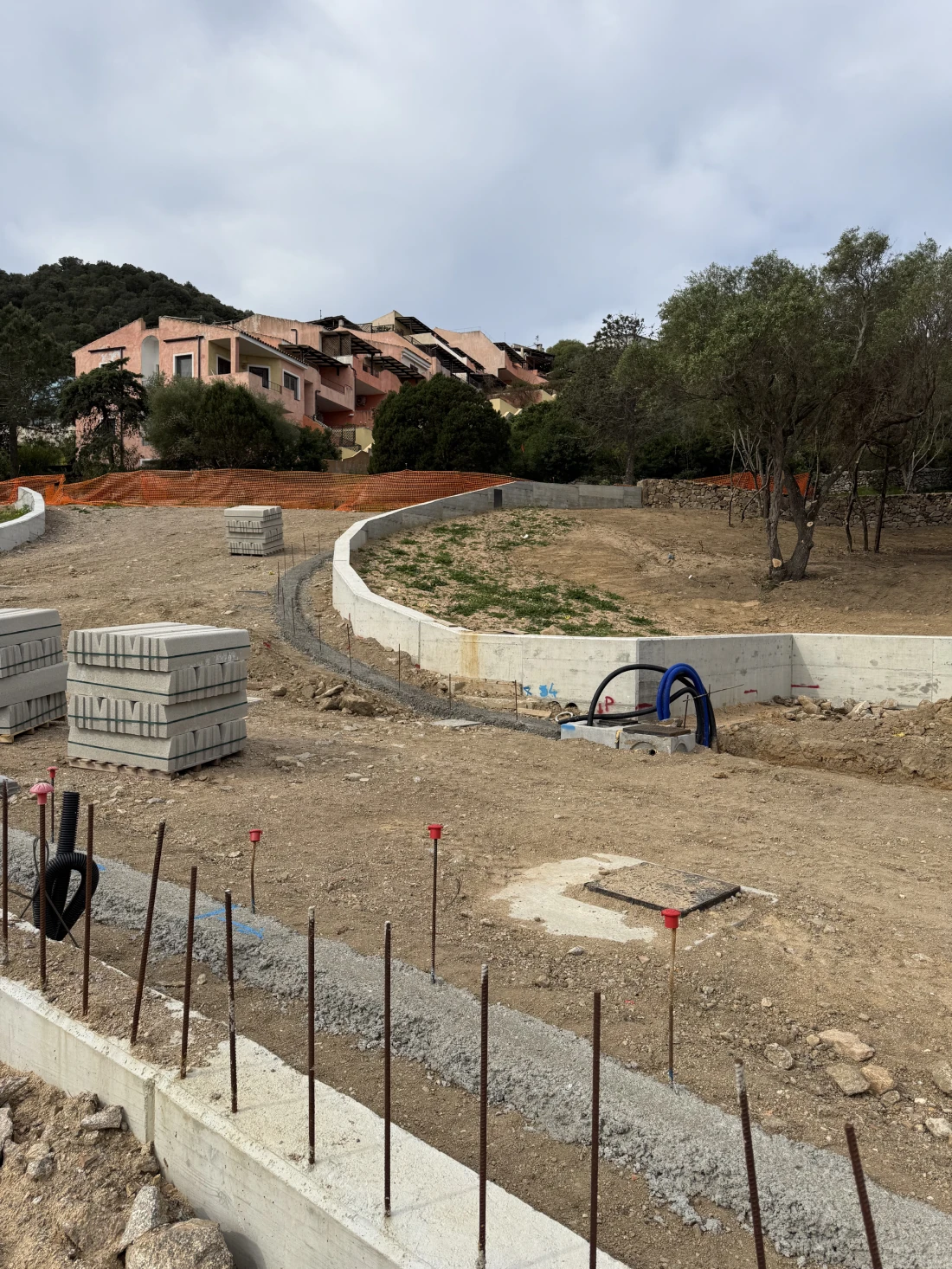

6. Retaining Walls

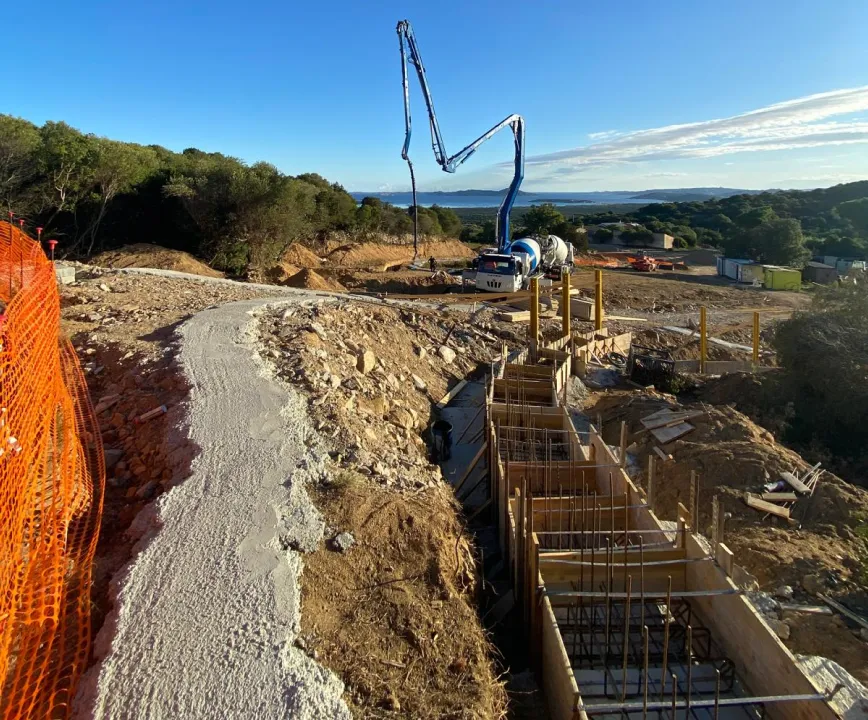

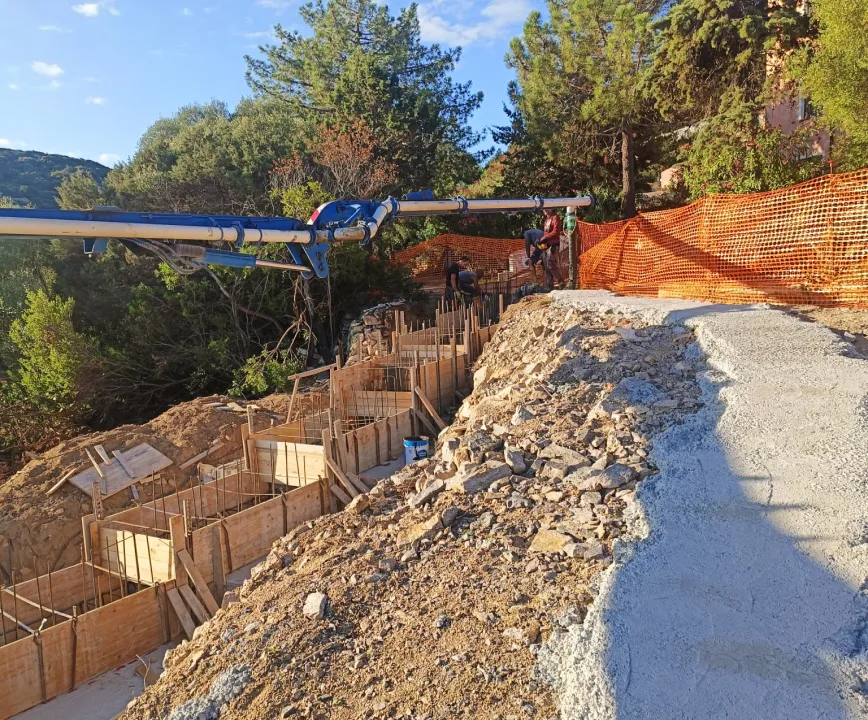

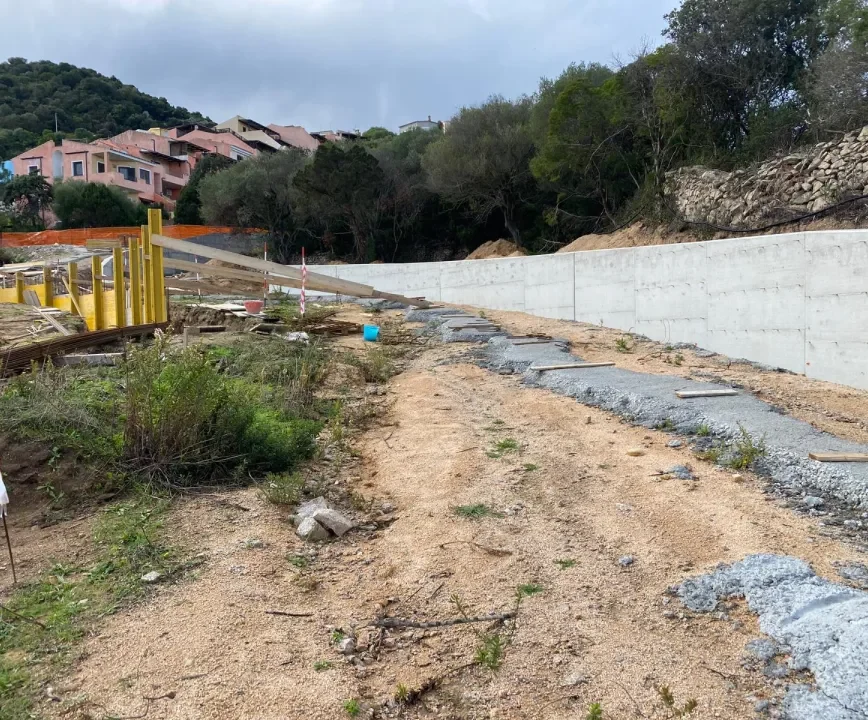

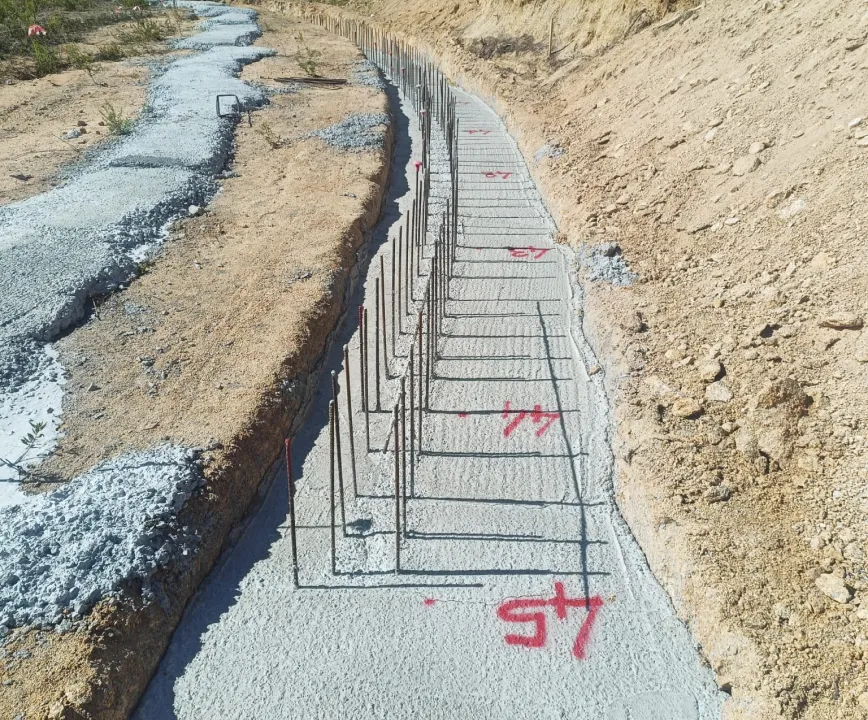

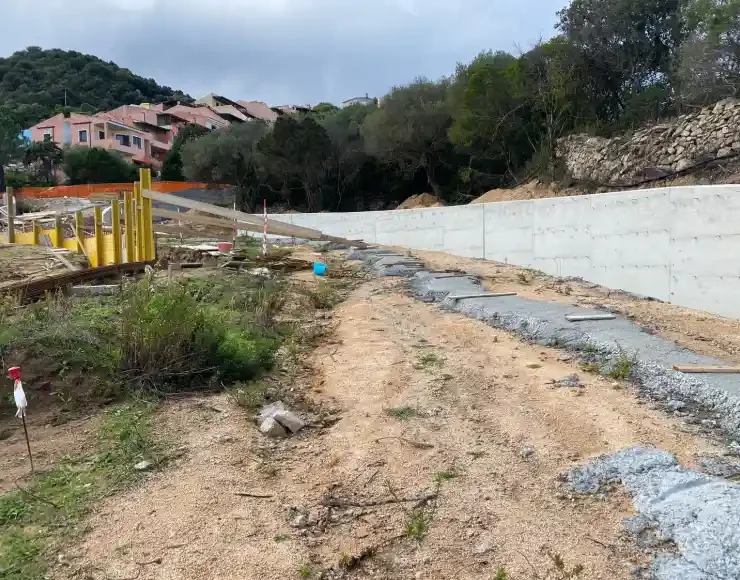

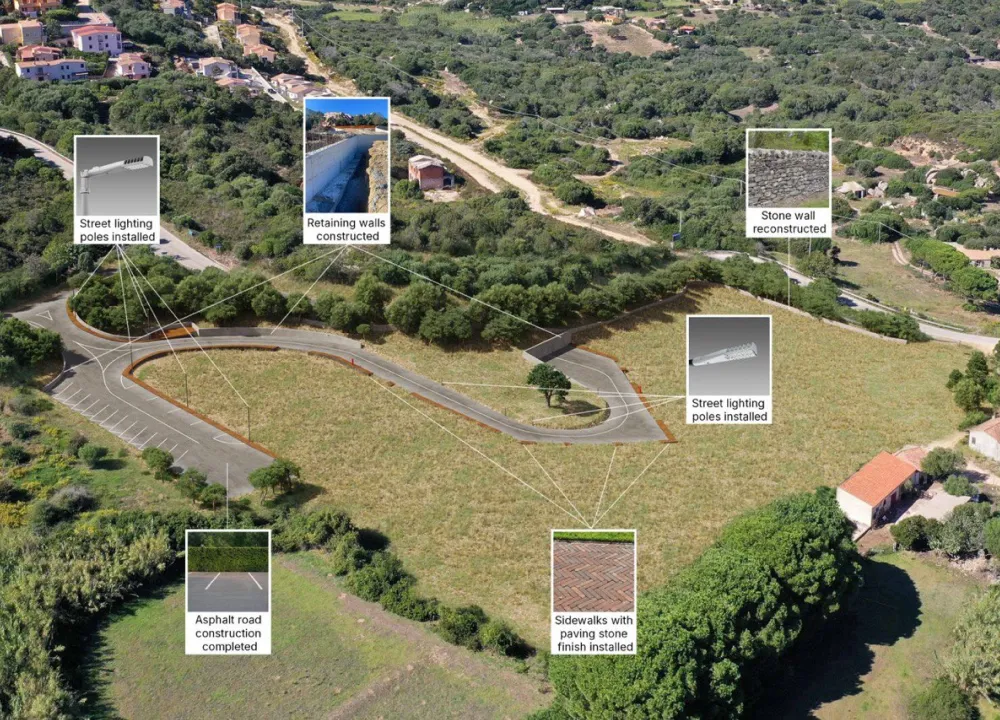

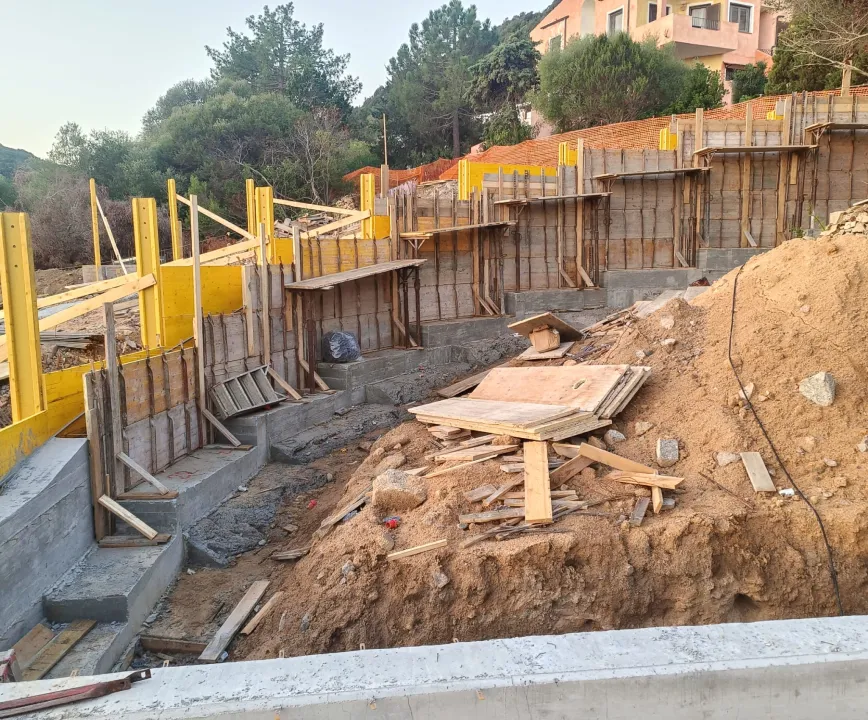

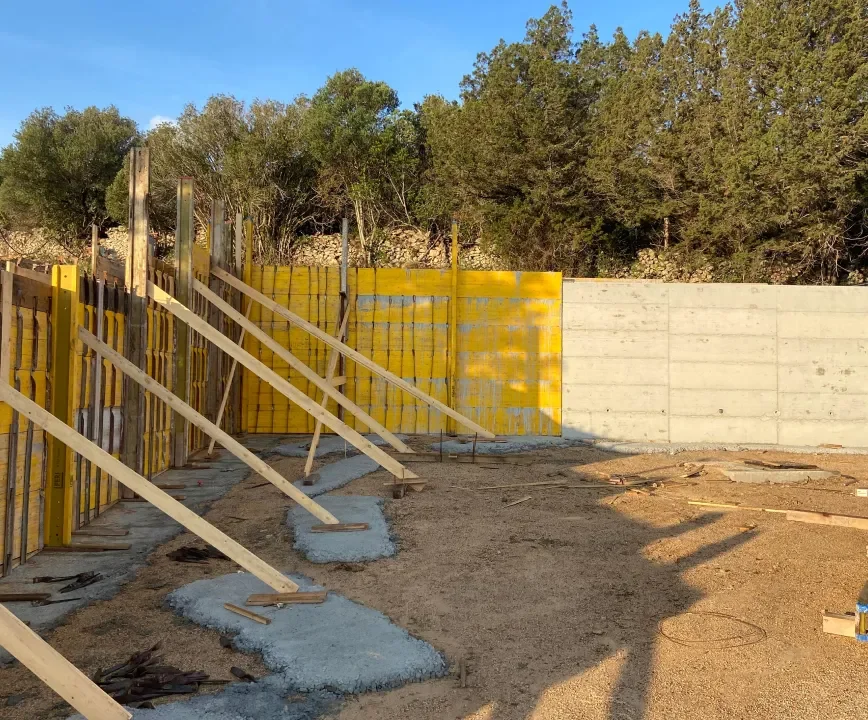

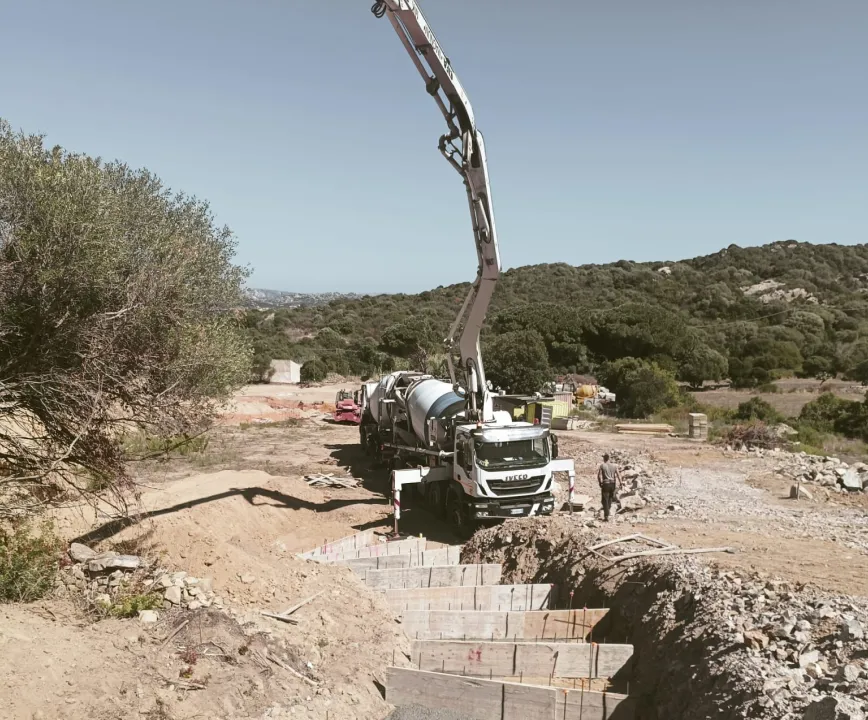

- Construction of main retaining walls across the site completed.

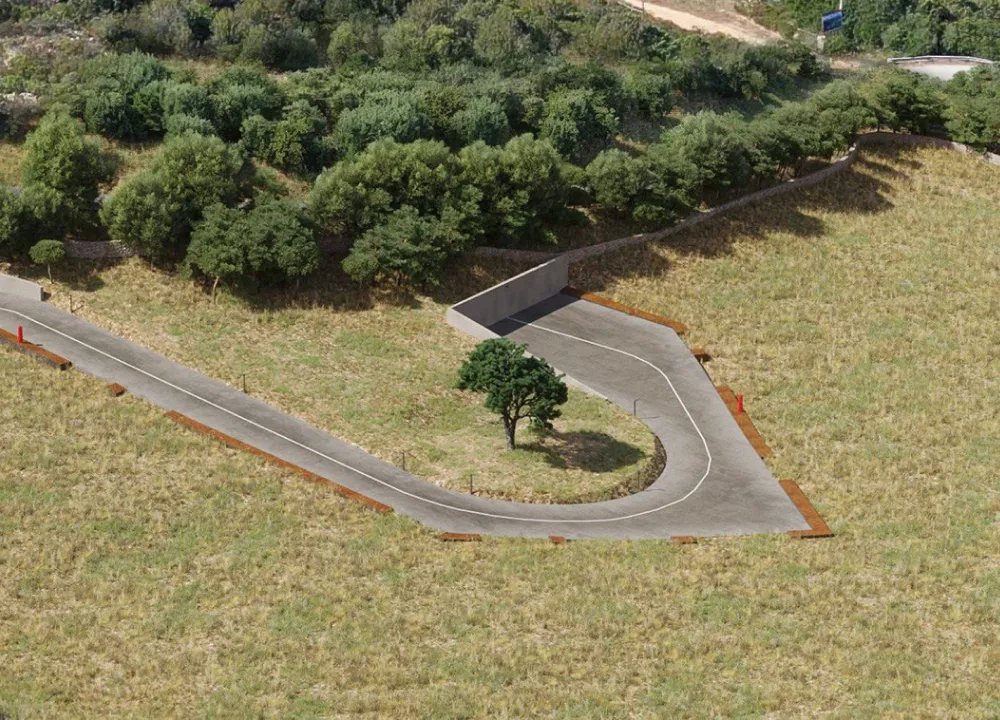

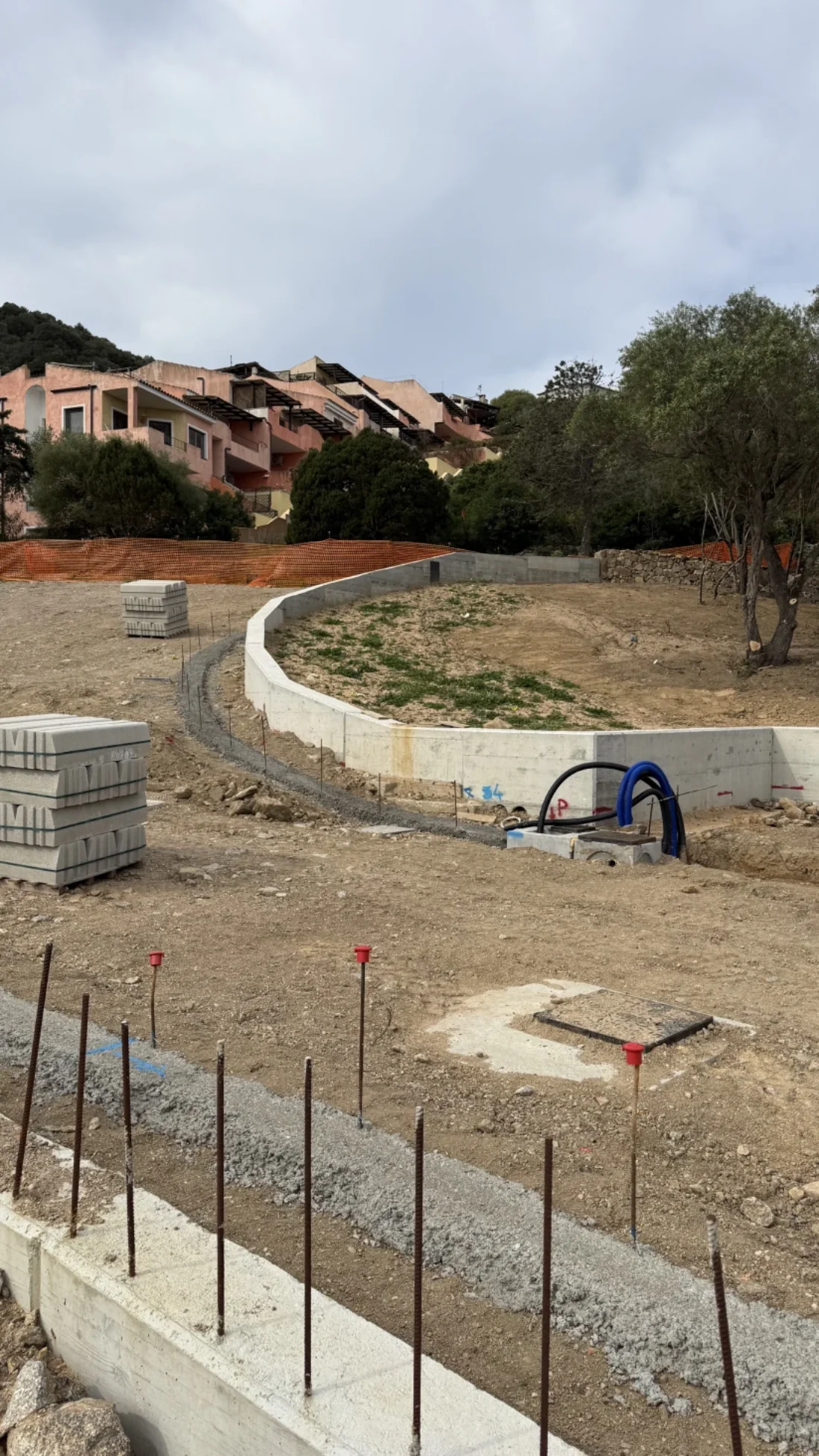

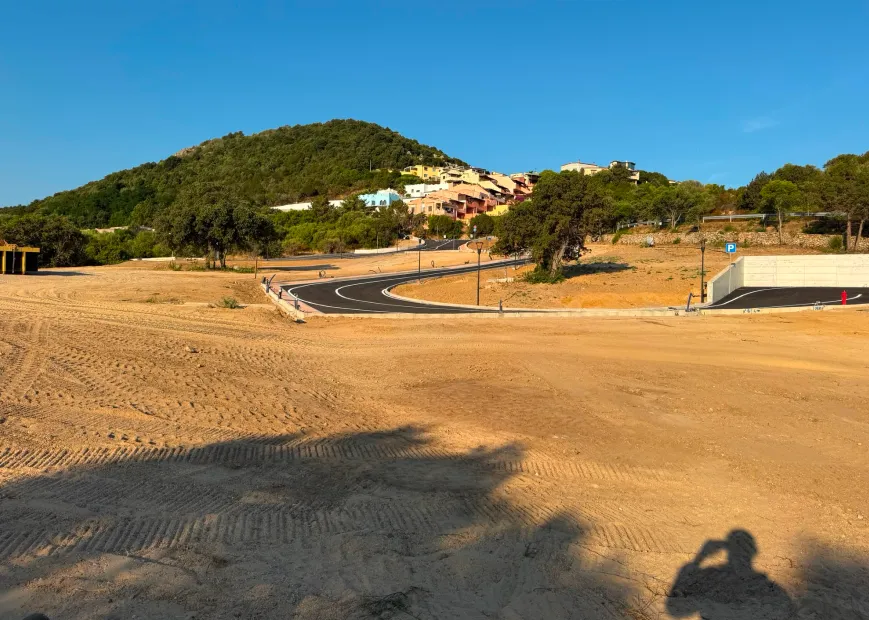

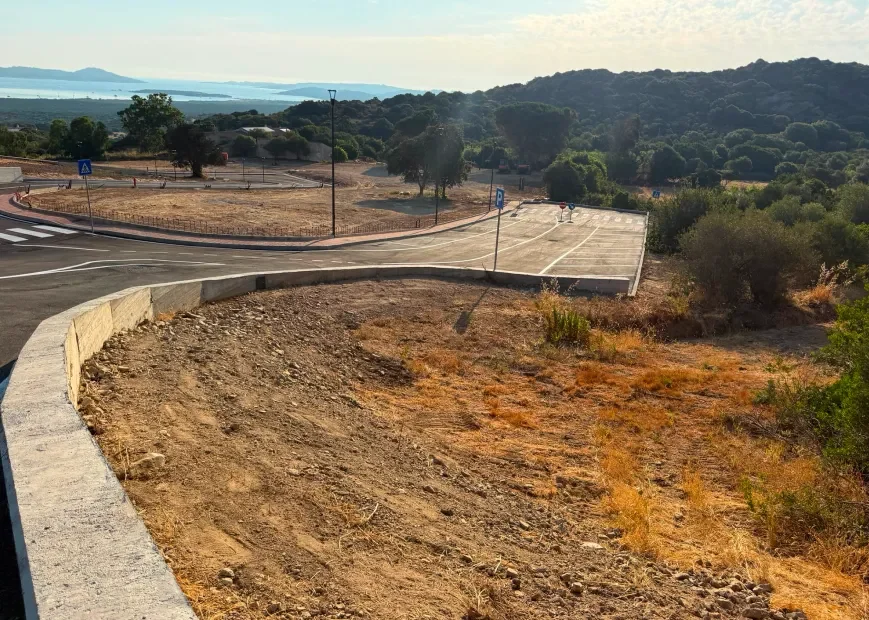

7. Roads and Sidewalks

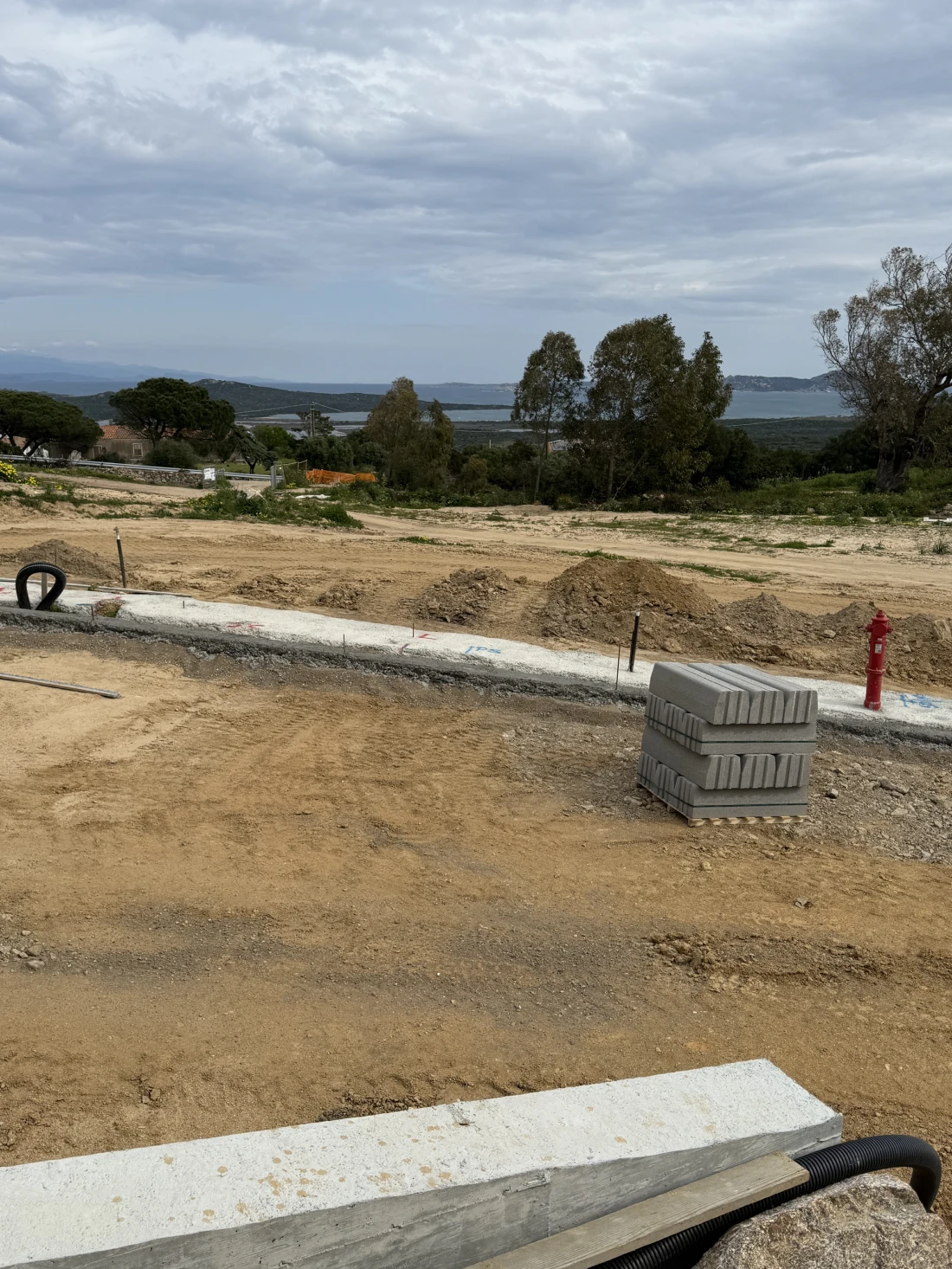

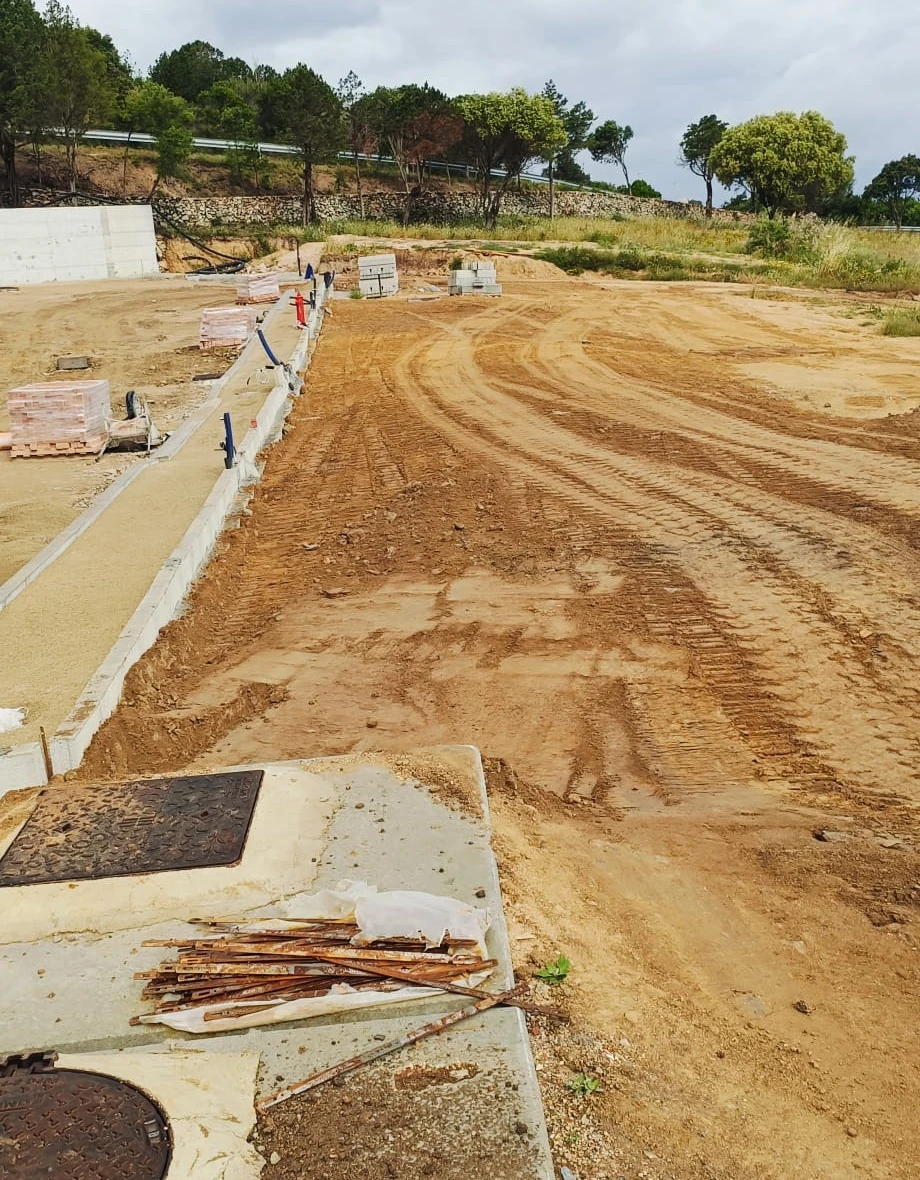

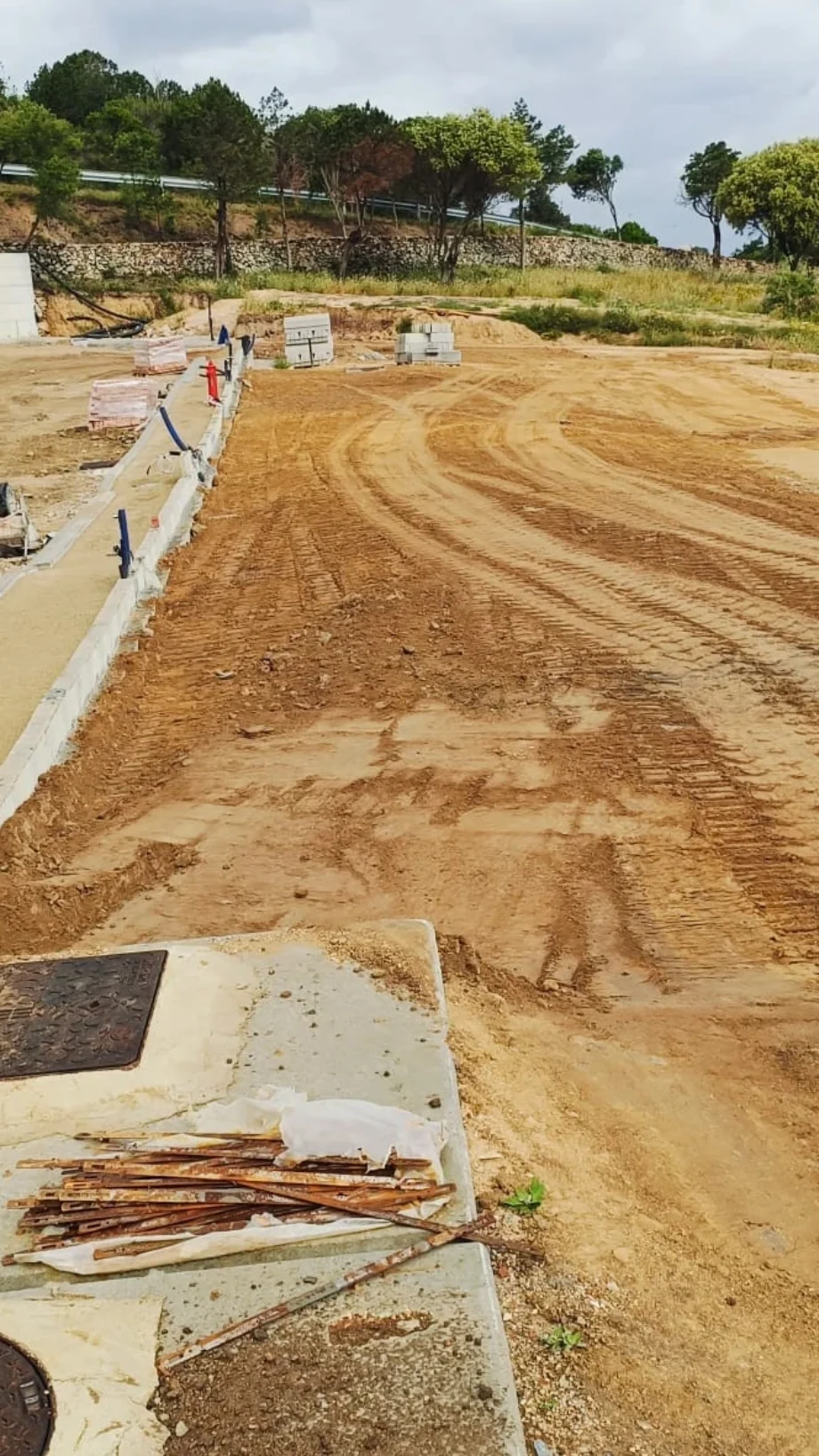

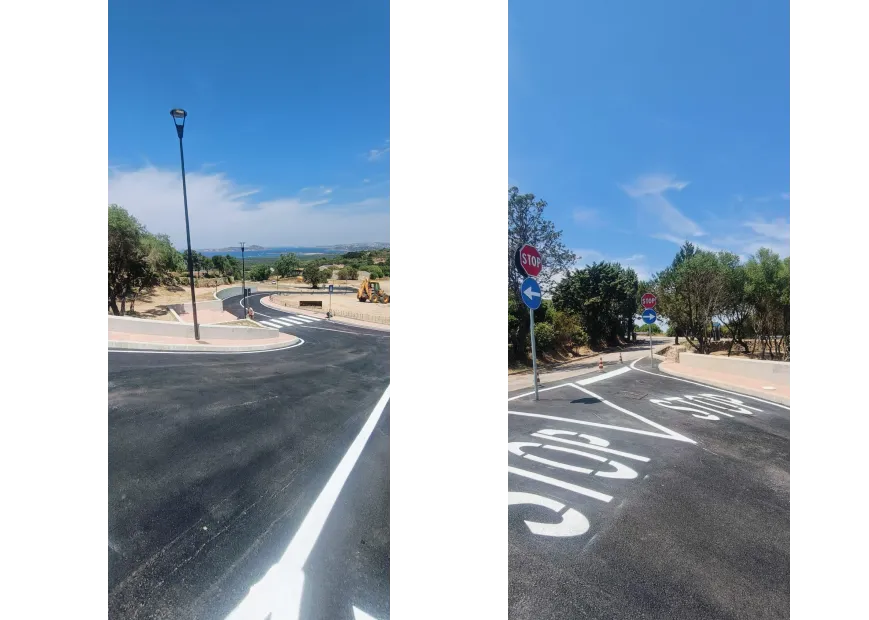

- Internal roads laid and paved with asphalt.

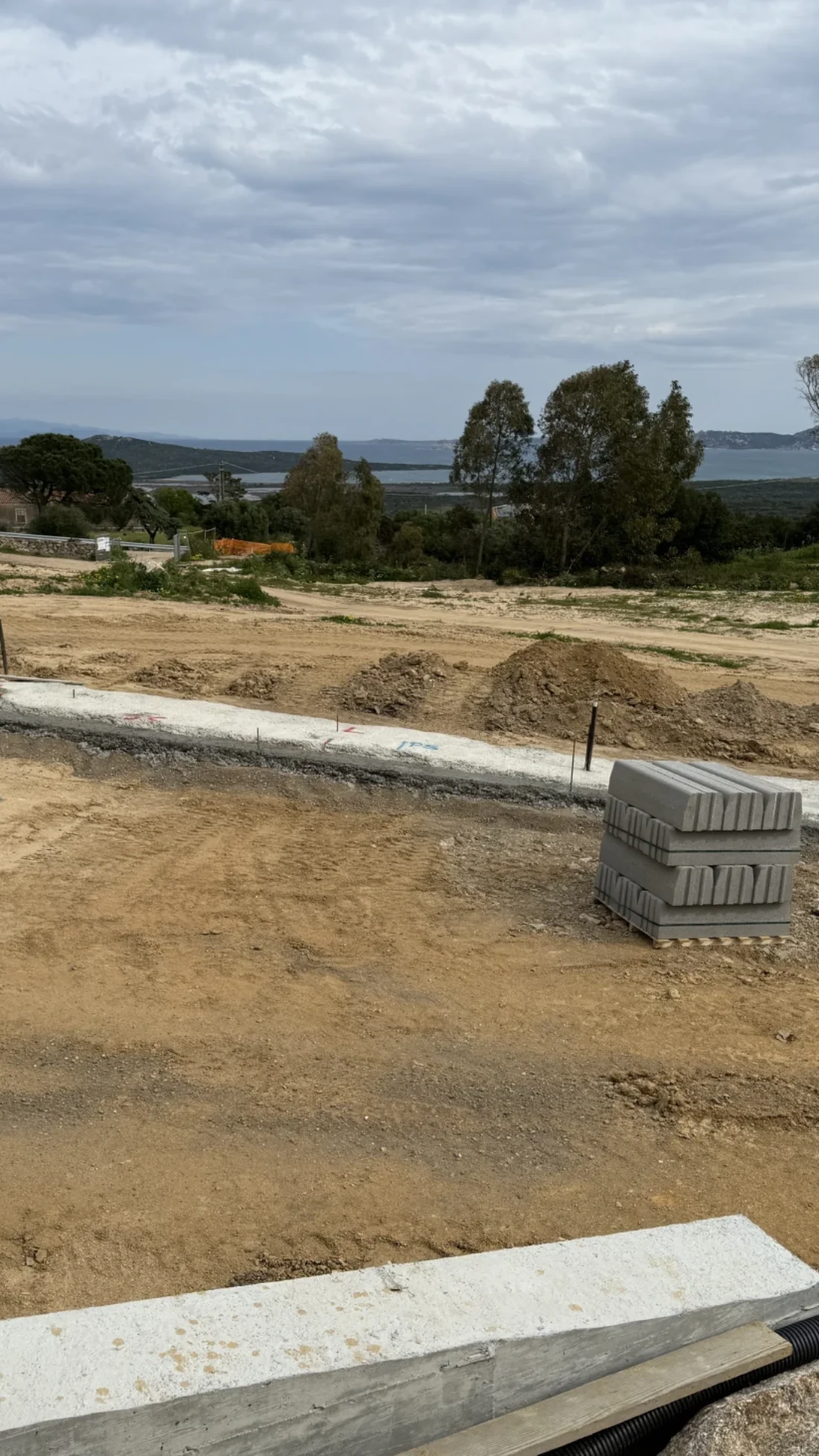

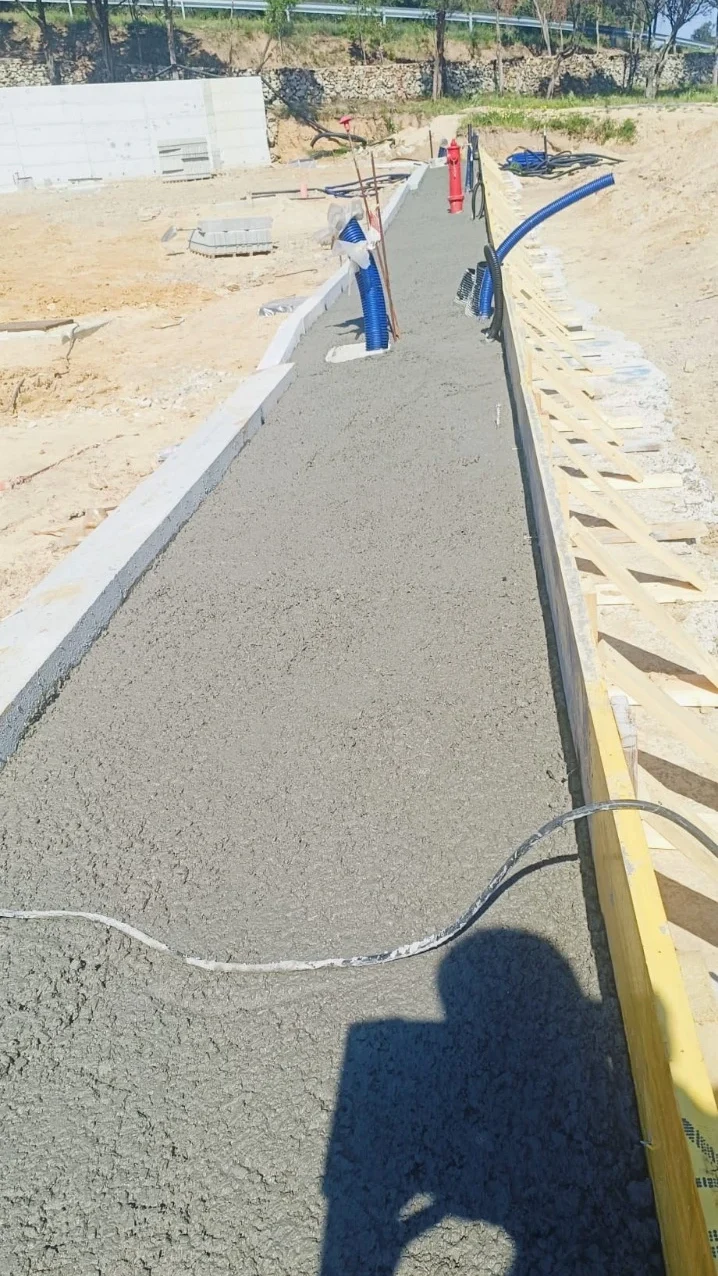

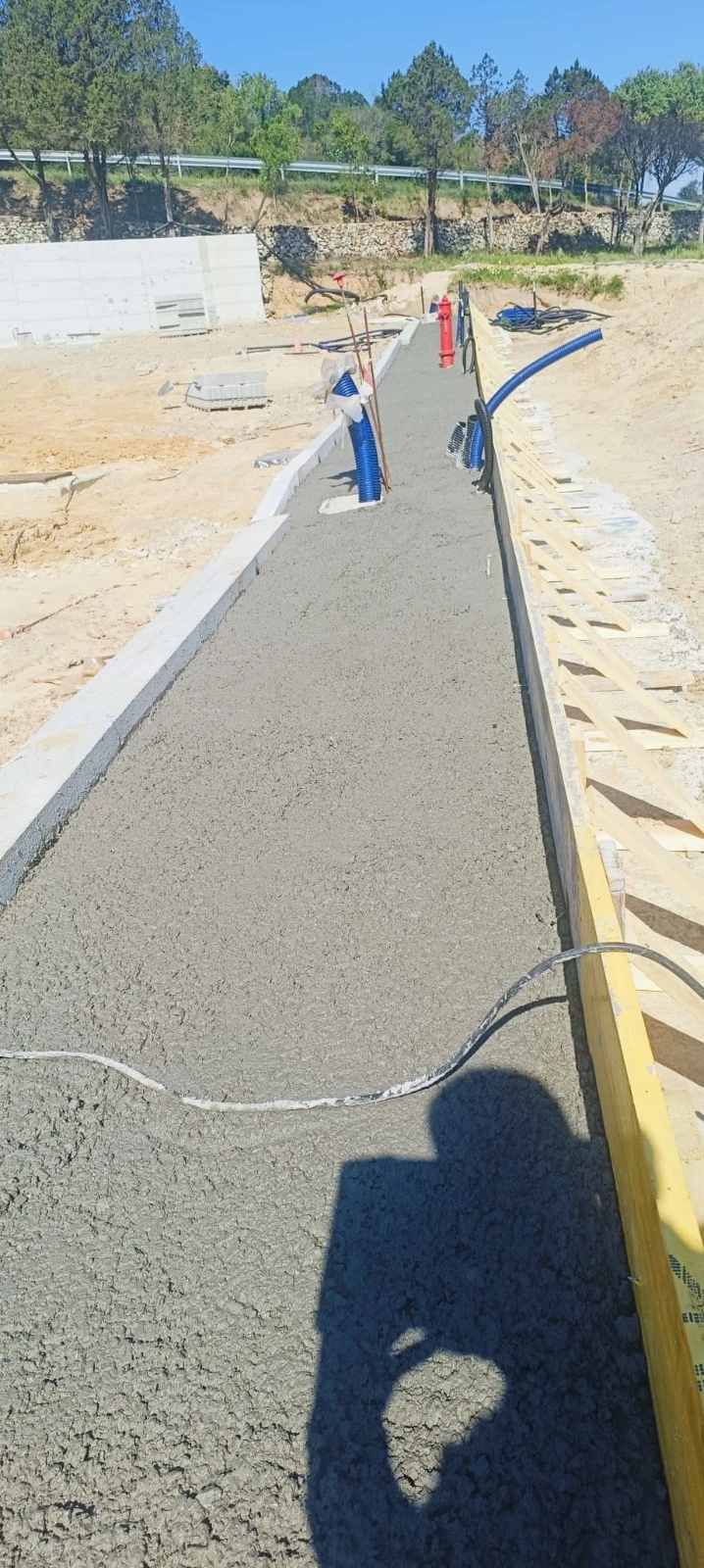

- Pedestrian walkways constructed and finished throughout the complex.

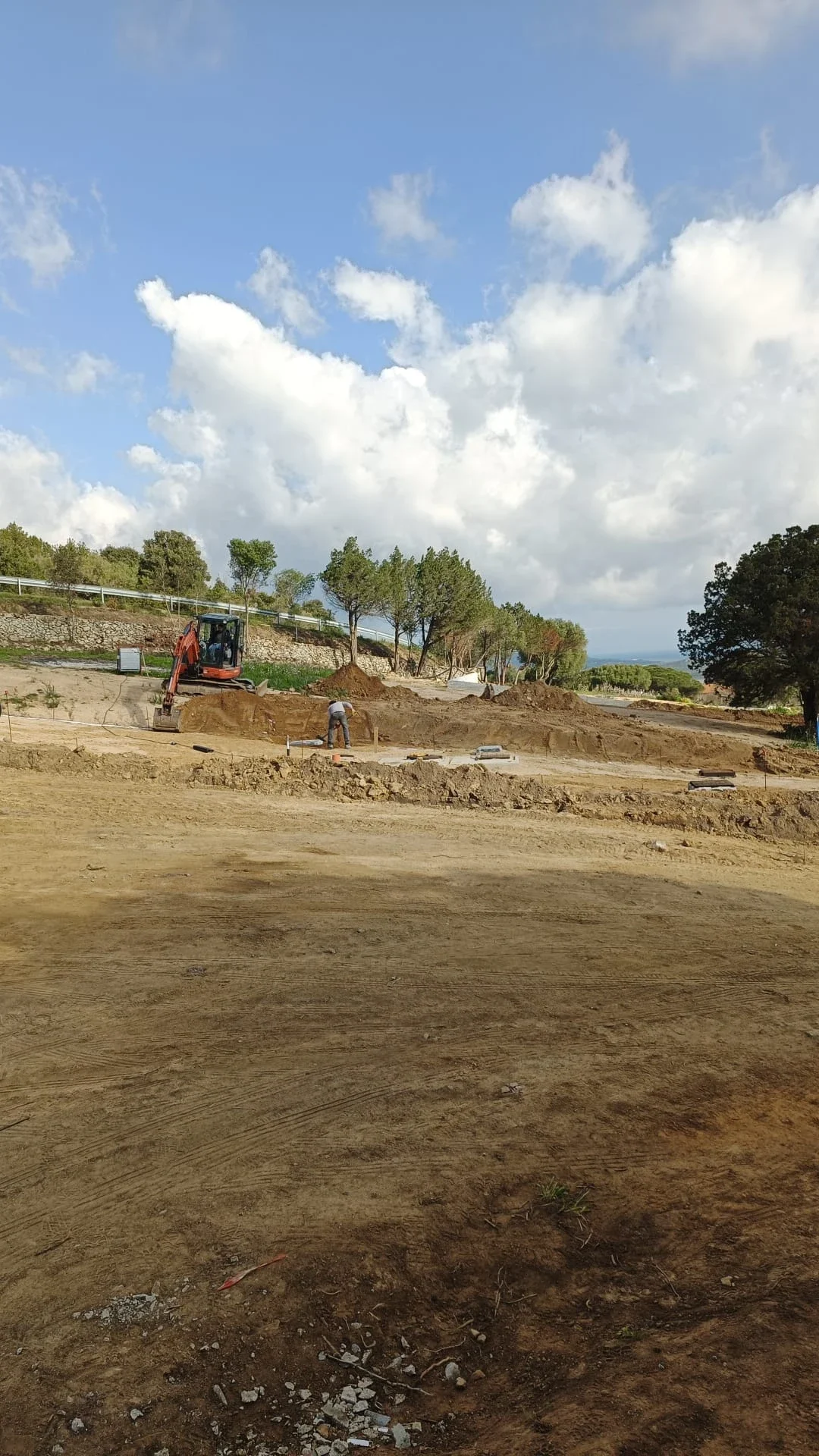

- Curbs installed.

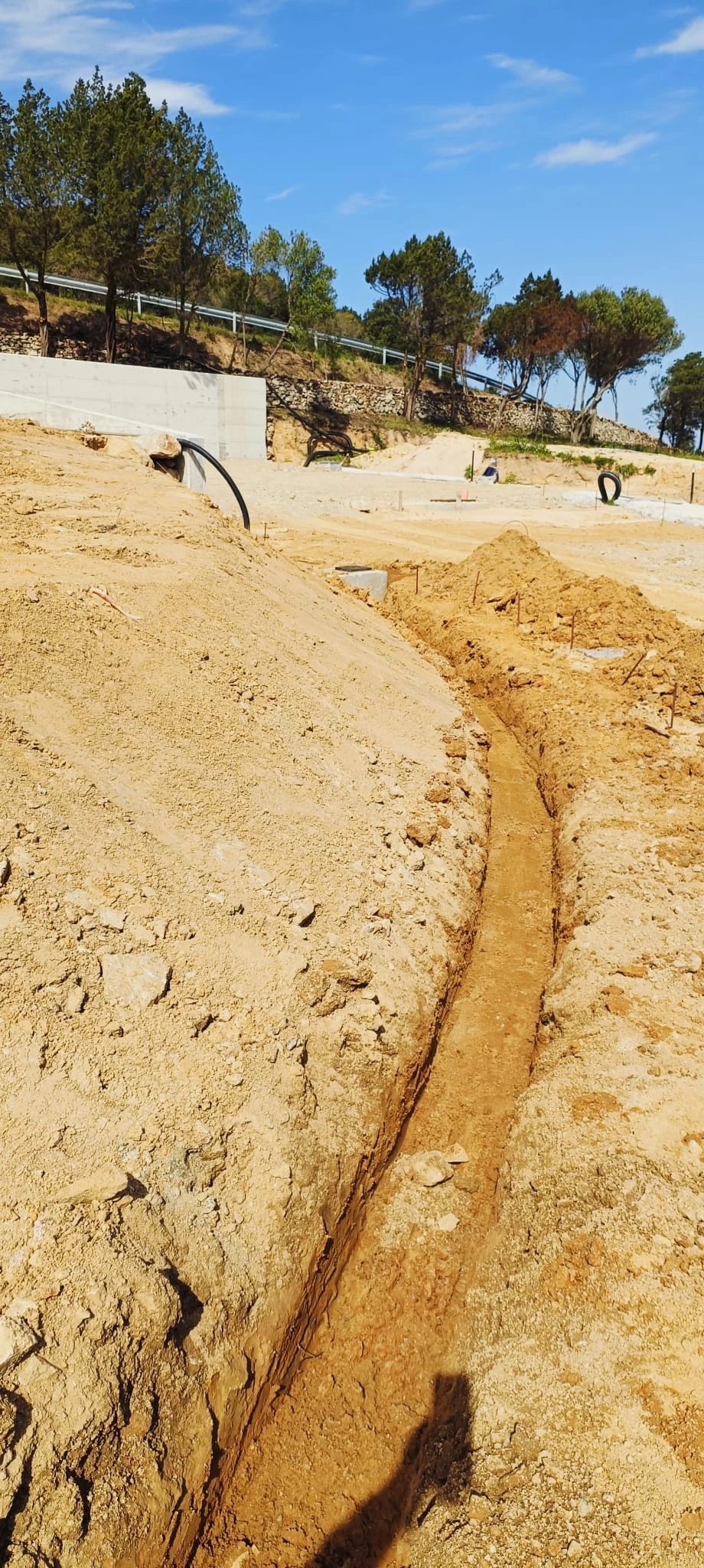

- Gullies and catch basins (water inlets) installed.

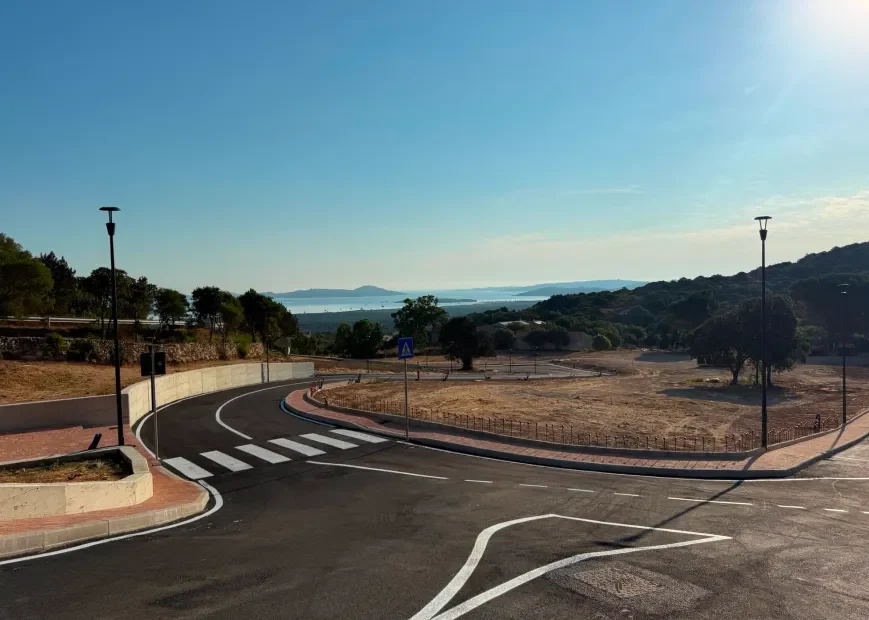

8. Lighting

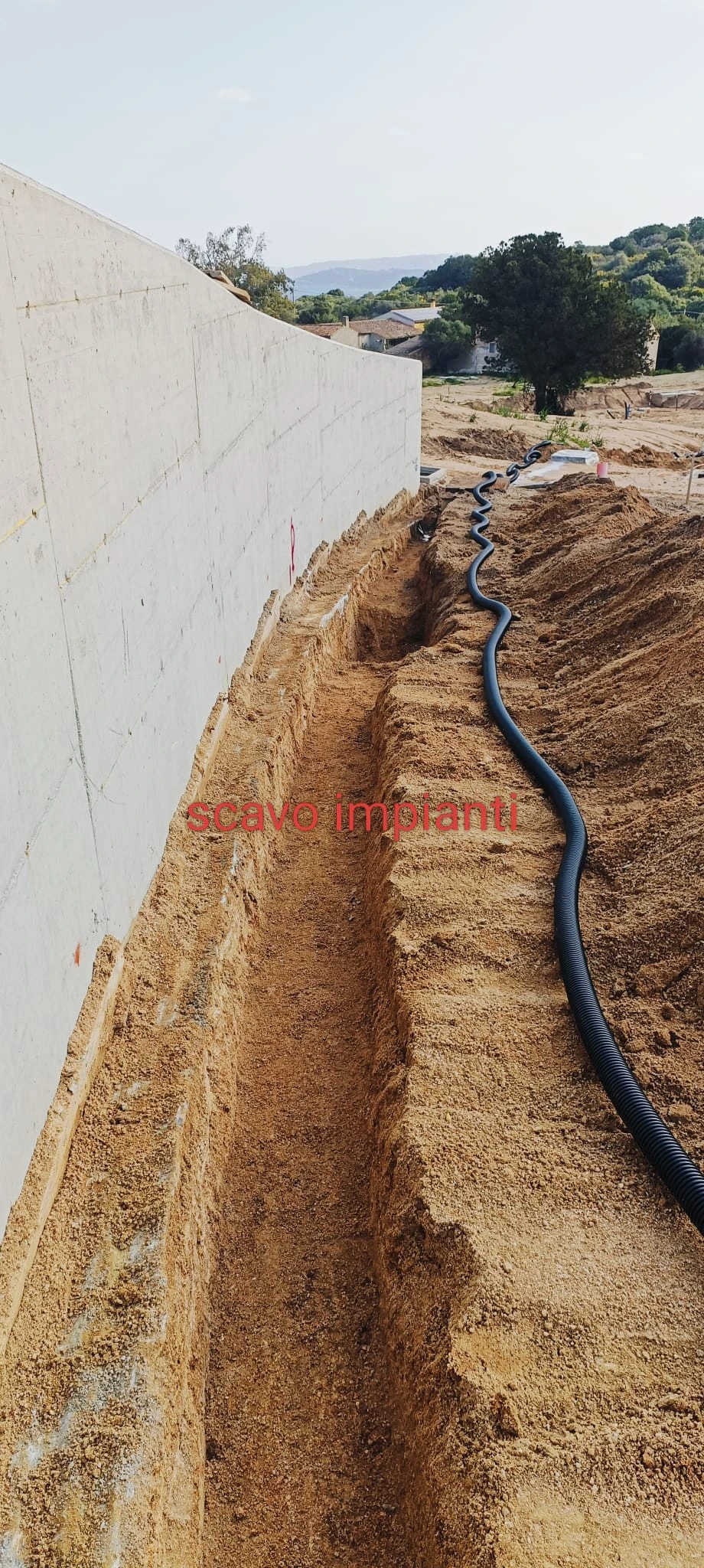

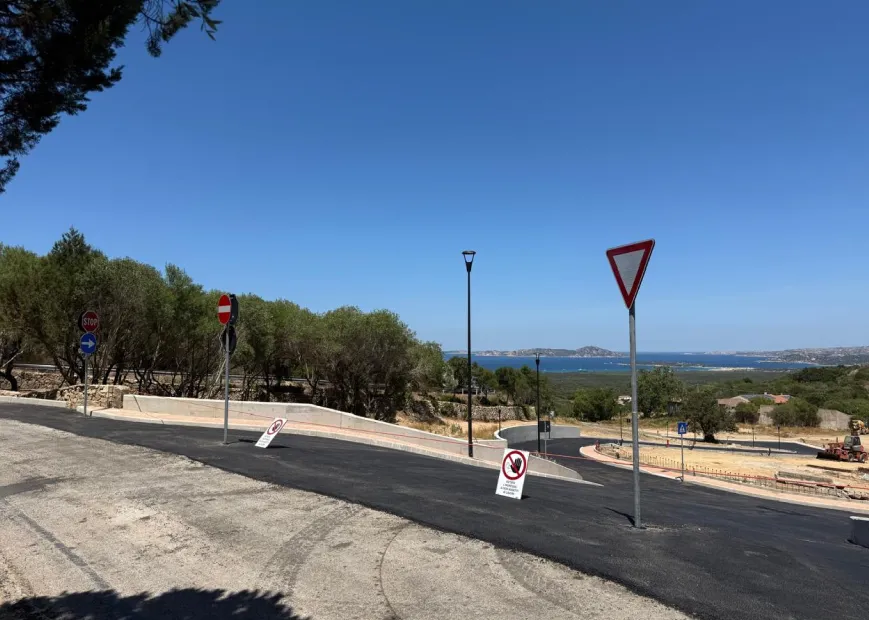

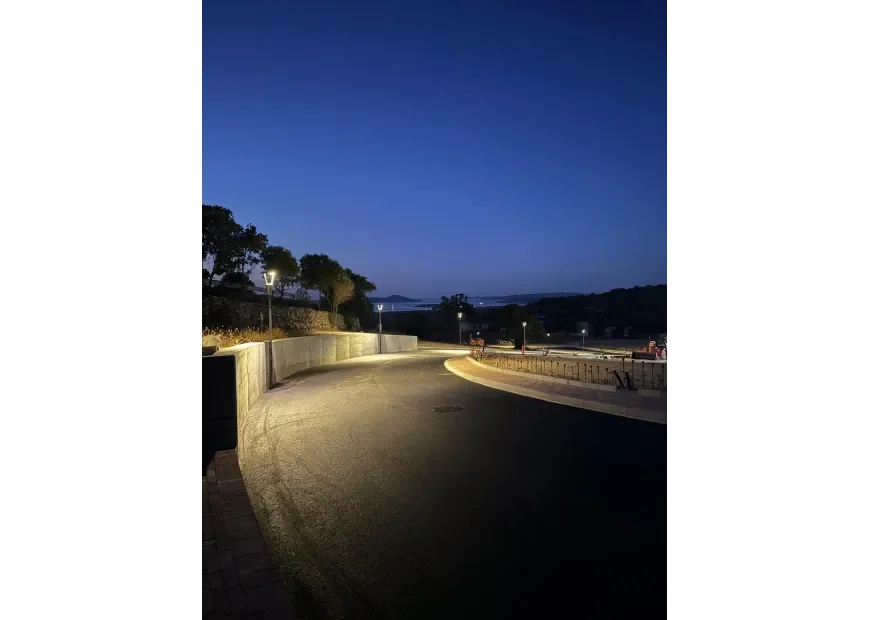

- Lighting poles installed for roads and parking areas.
- Connection for common area lighting established.
- Conduit installed for the illumination of the stone wall (muretto).

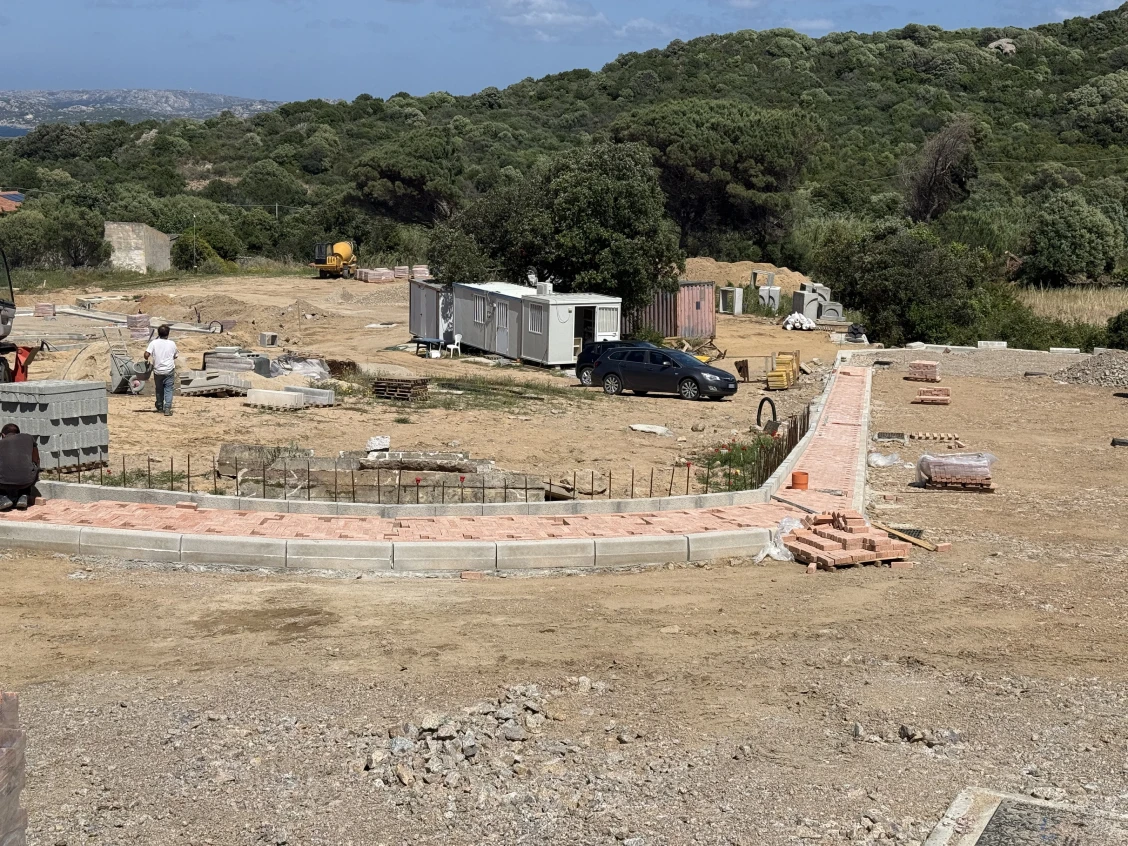

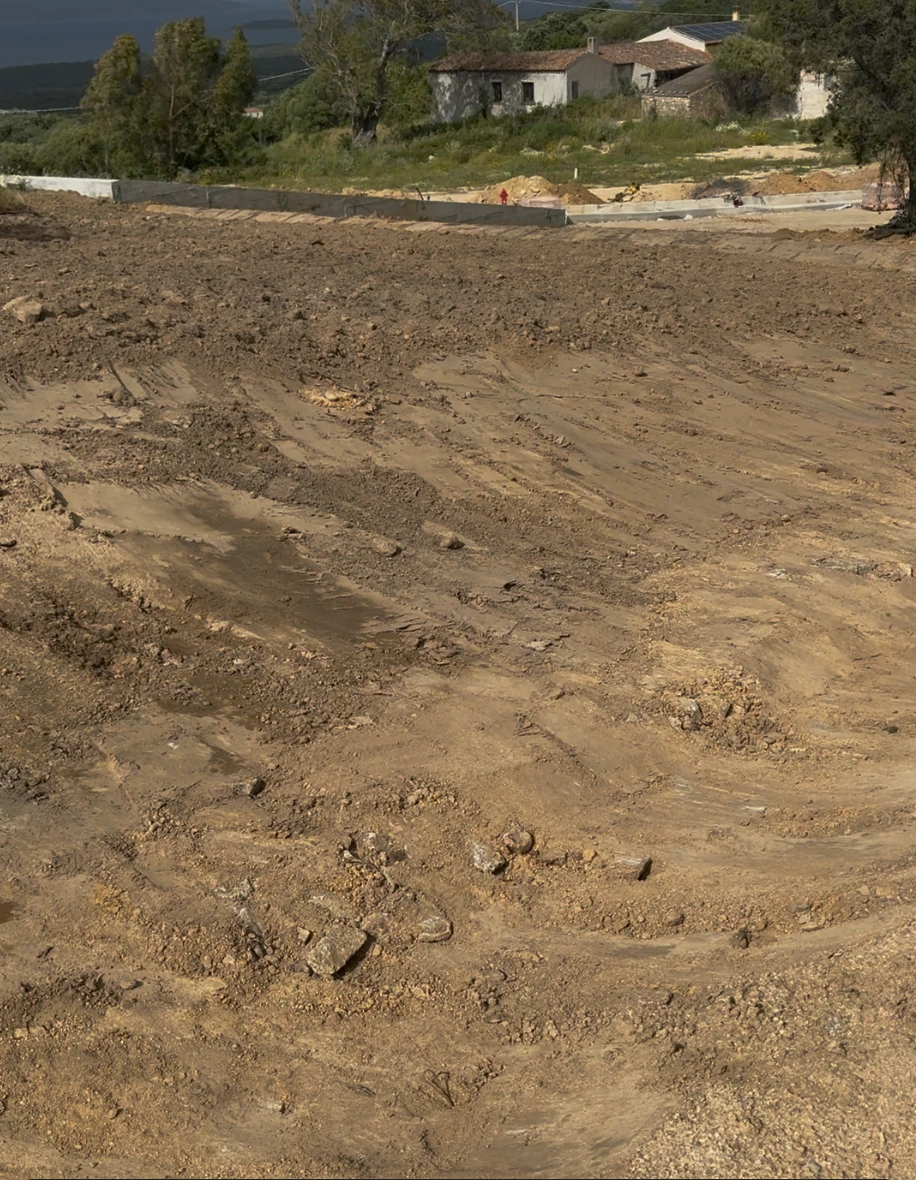

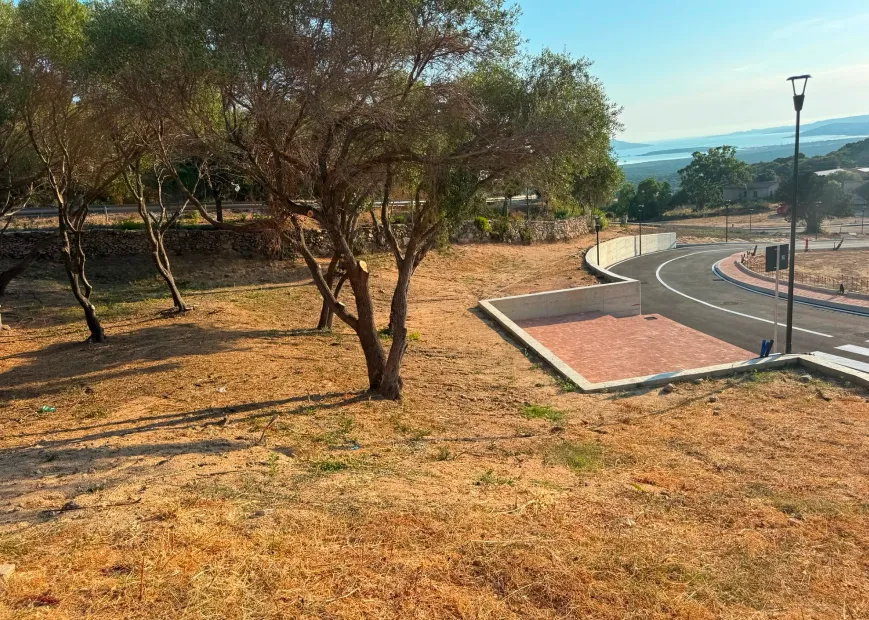

9. Common Areas and Site Prep

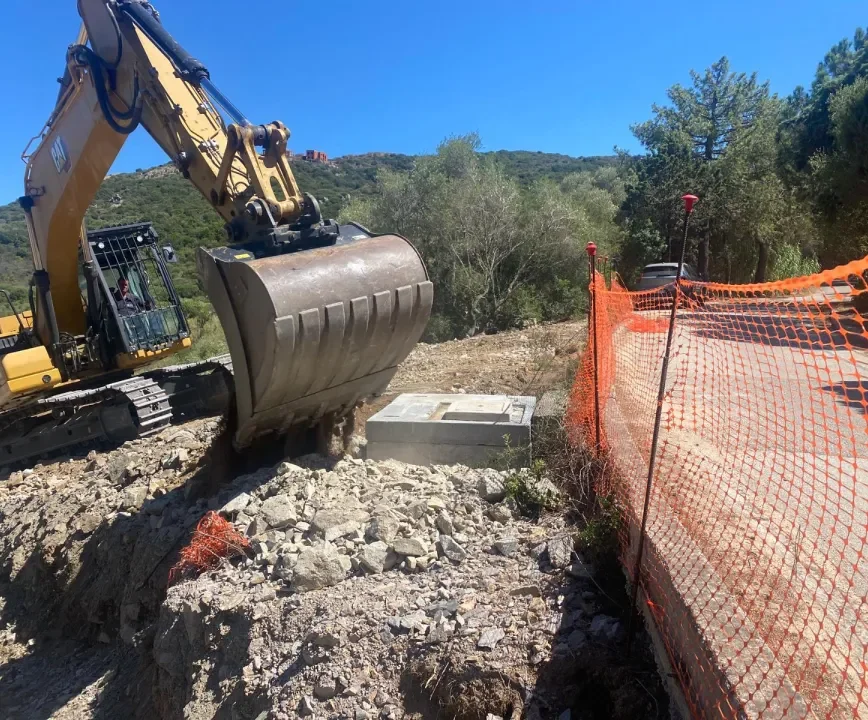

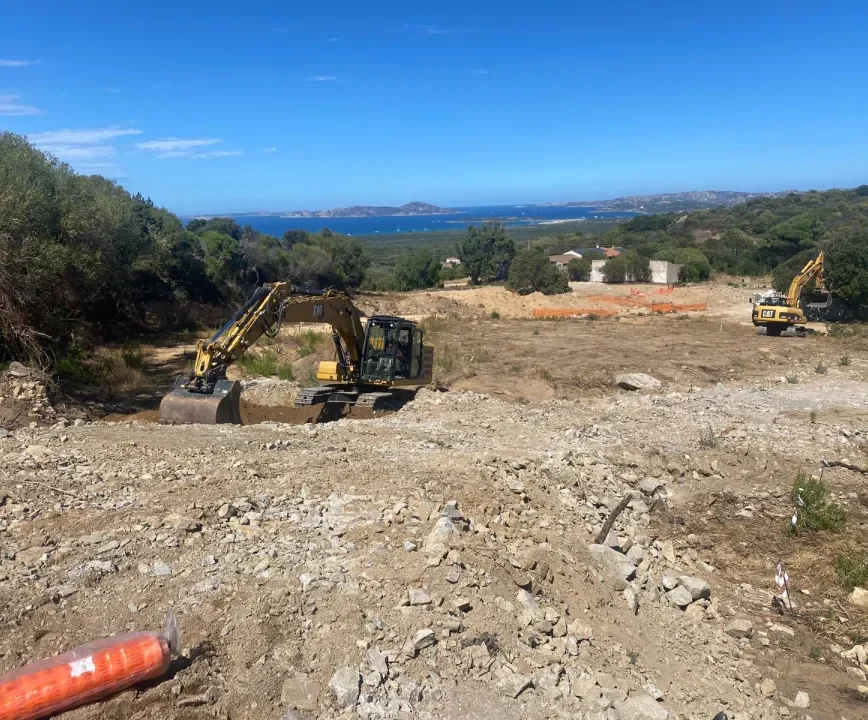

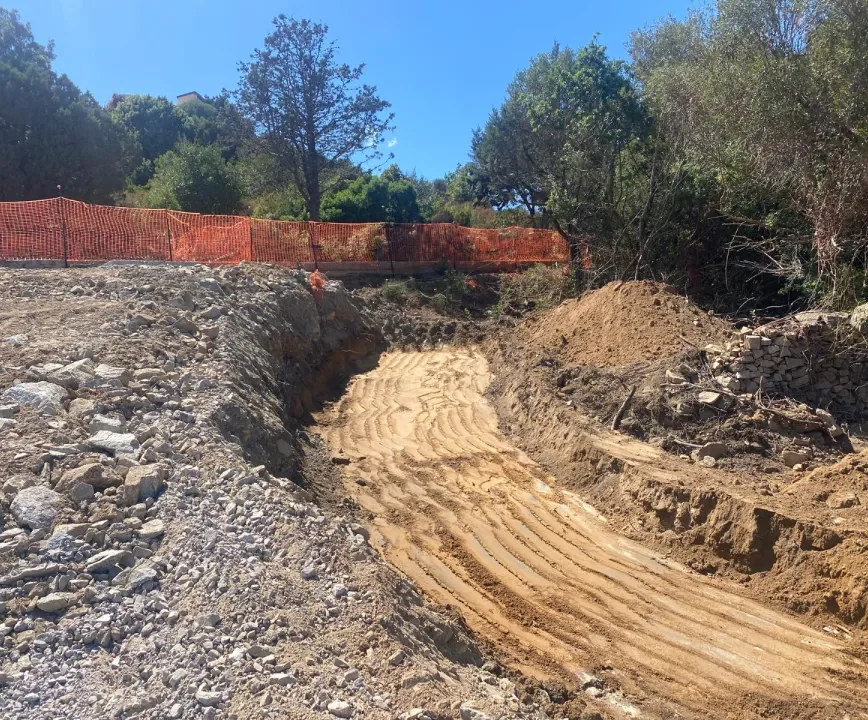

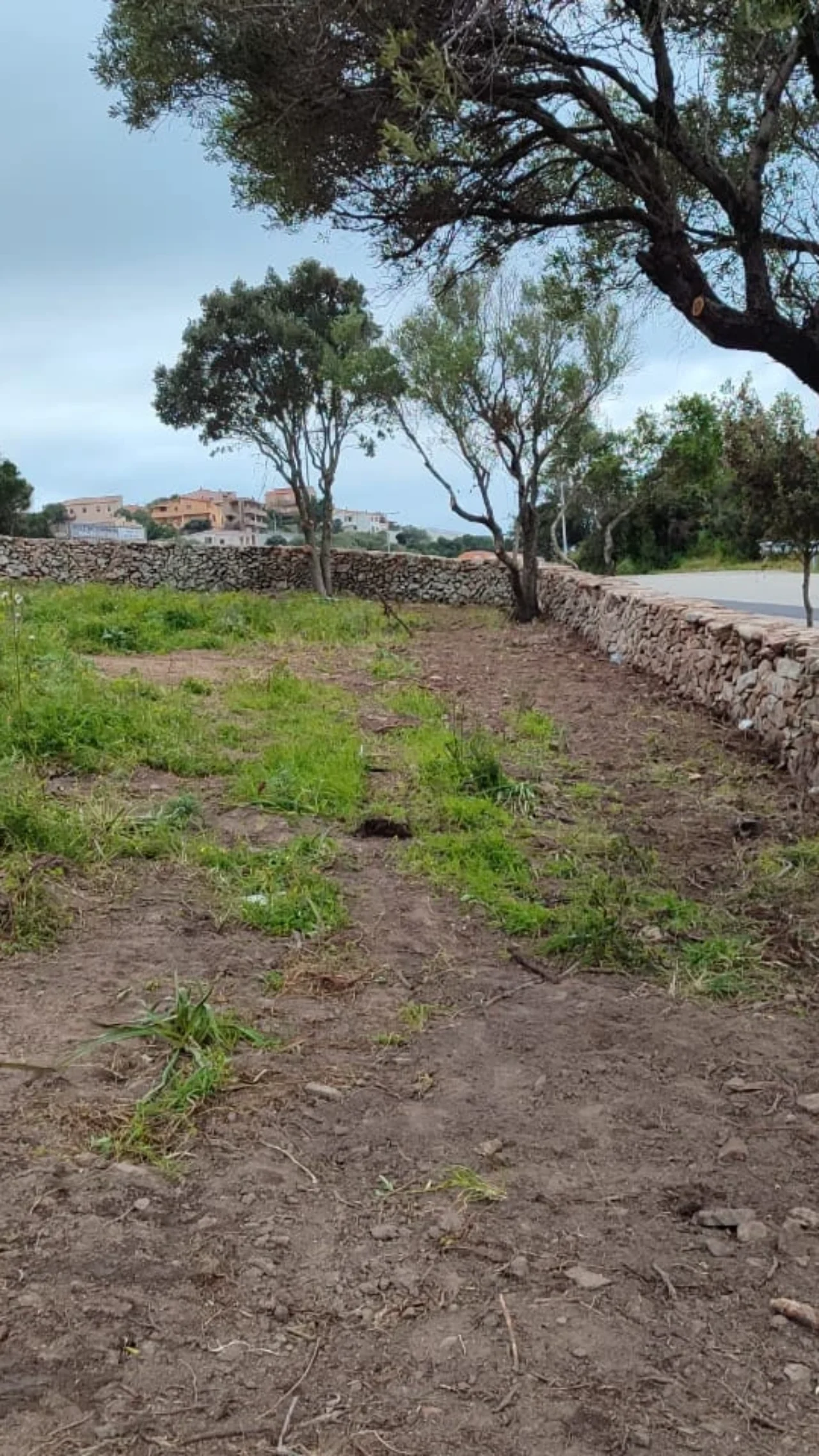

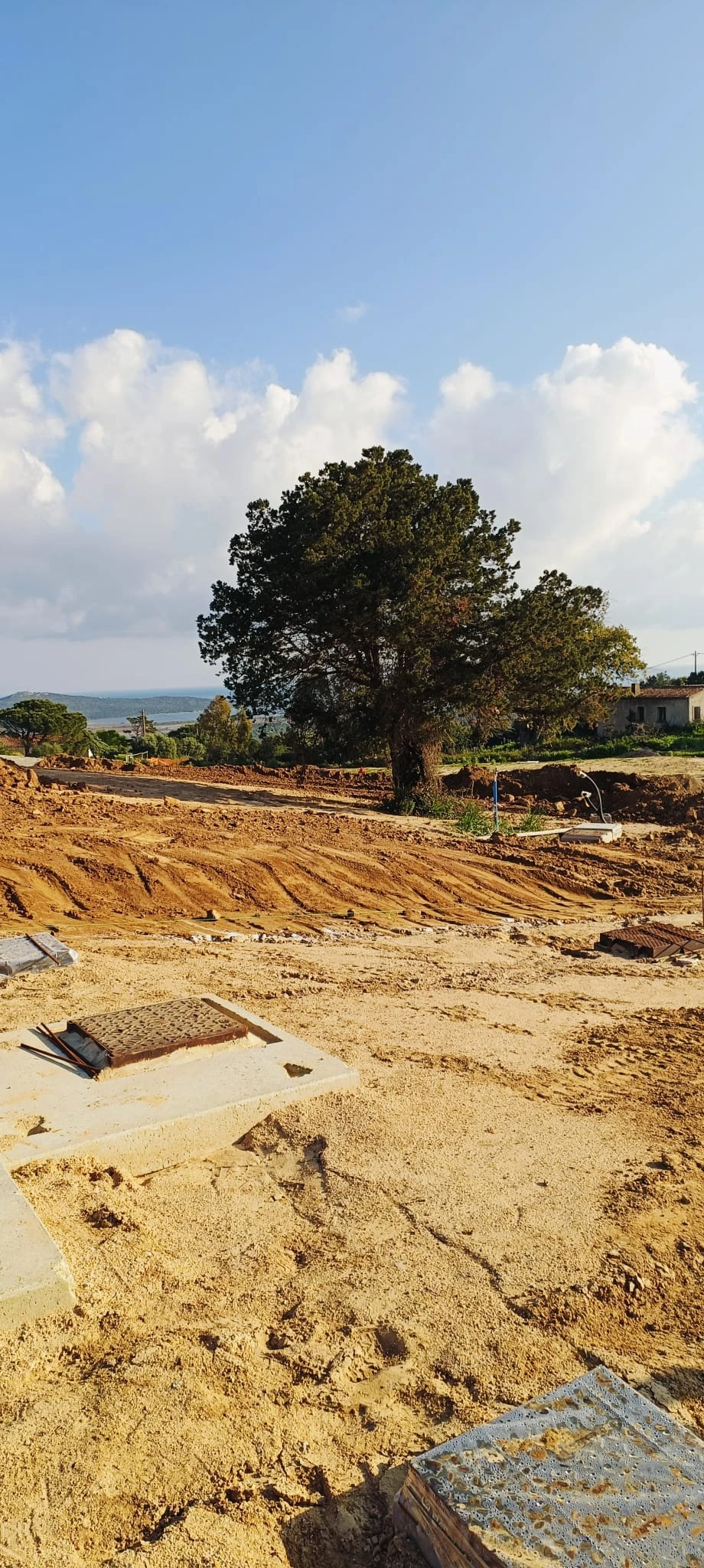

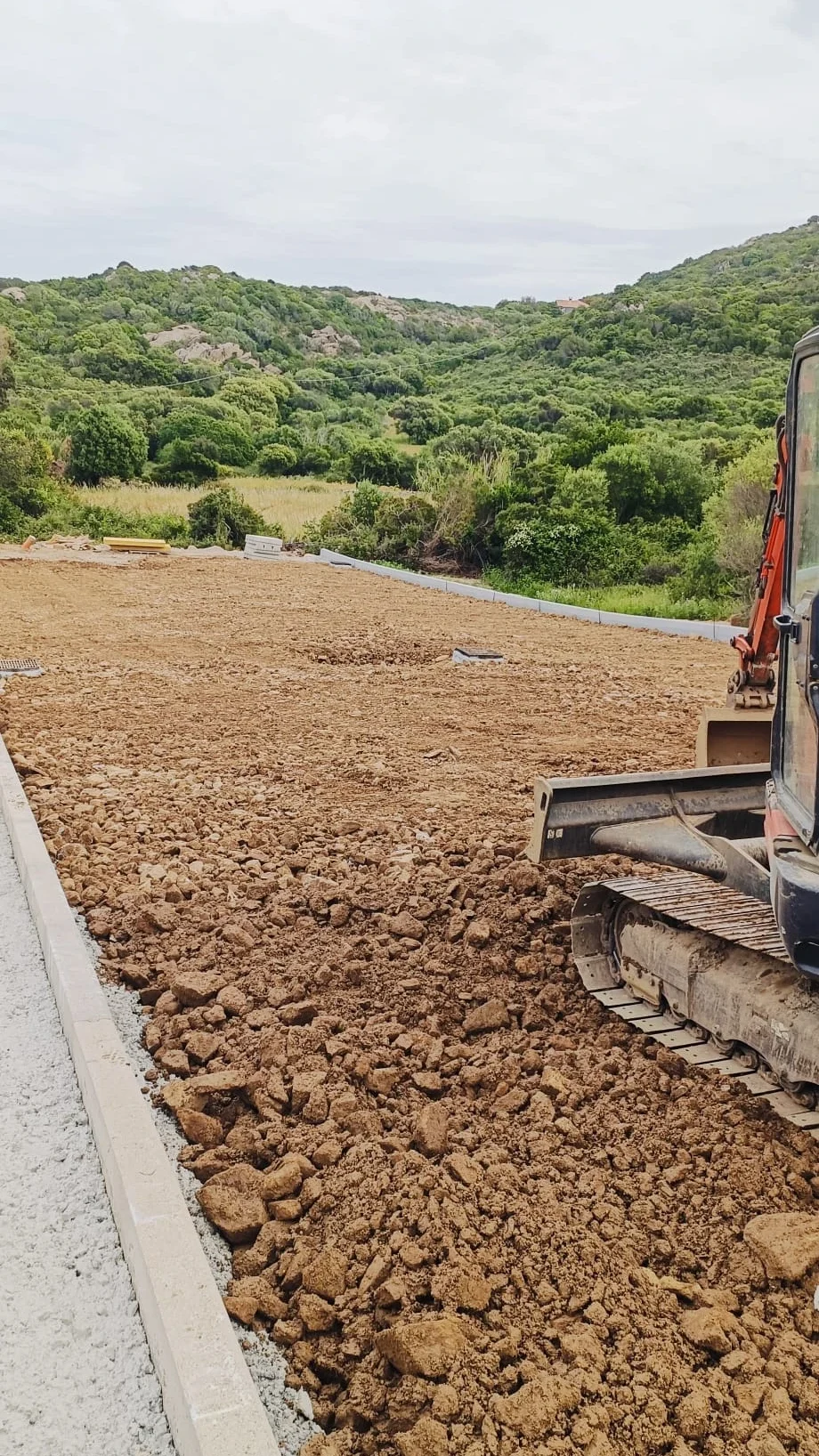

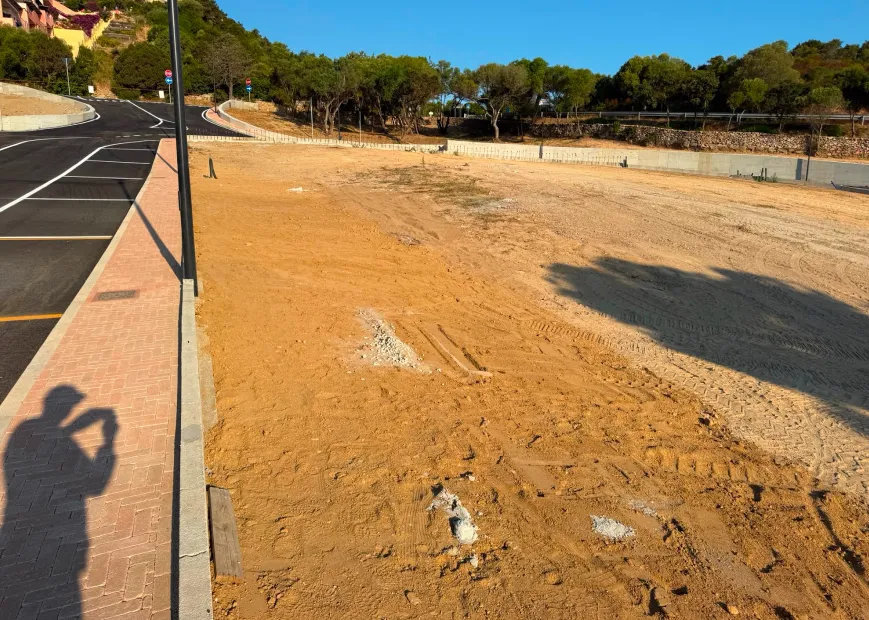

- Clearing of the entire territory from overgrown vegetation.

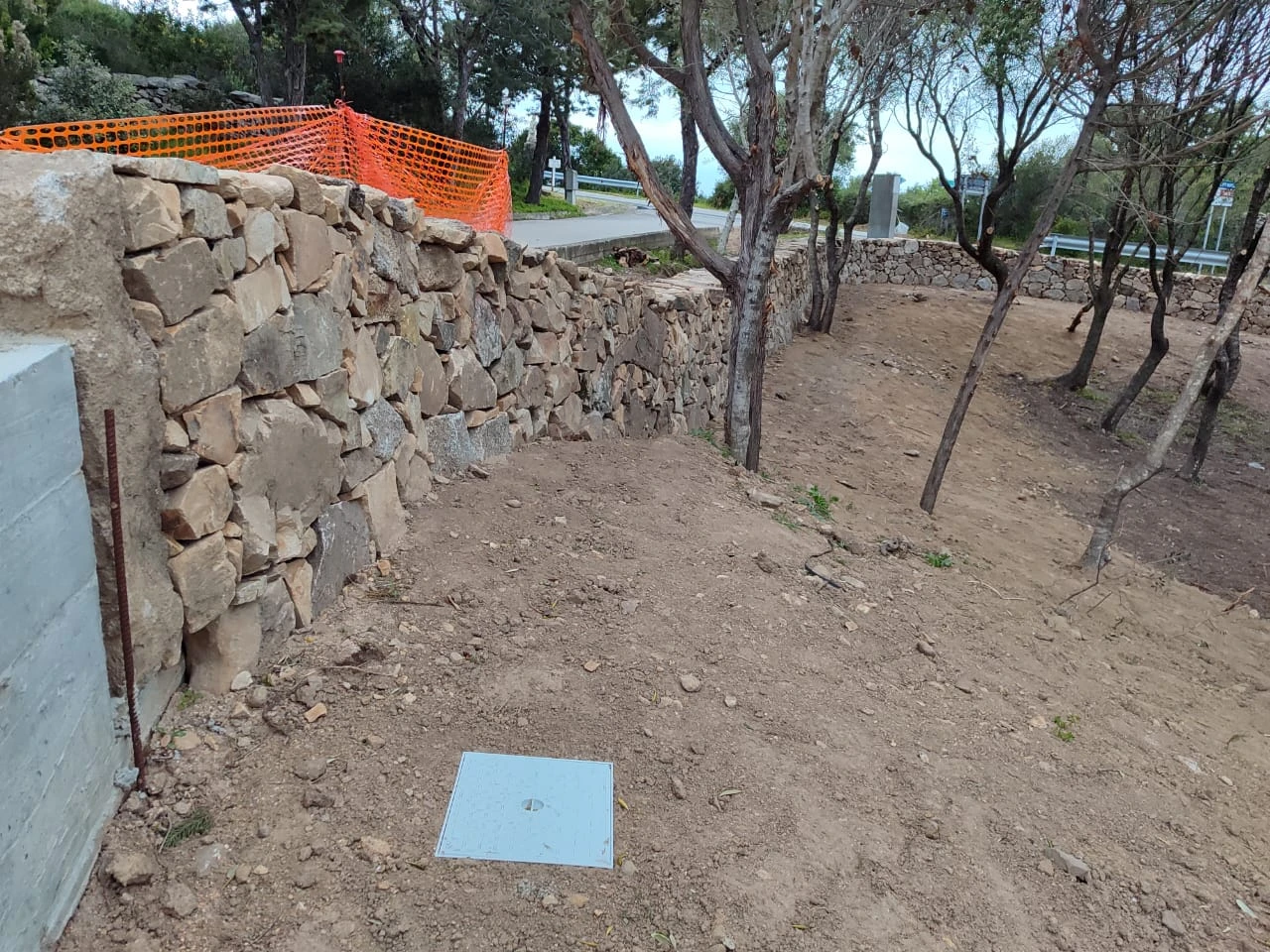

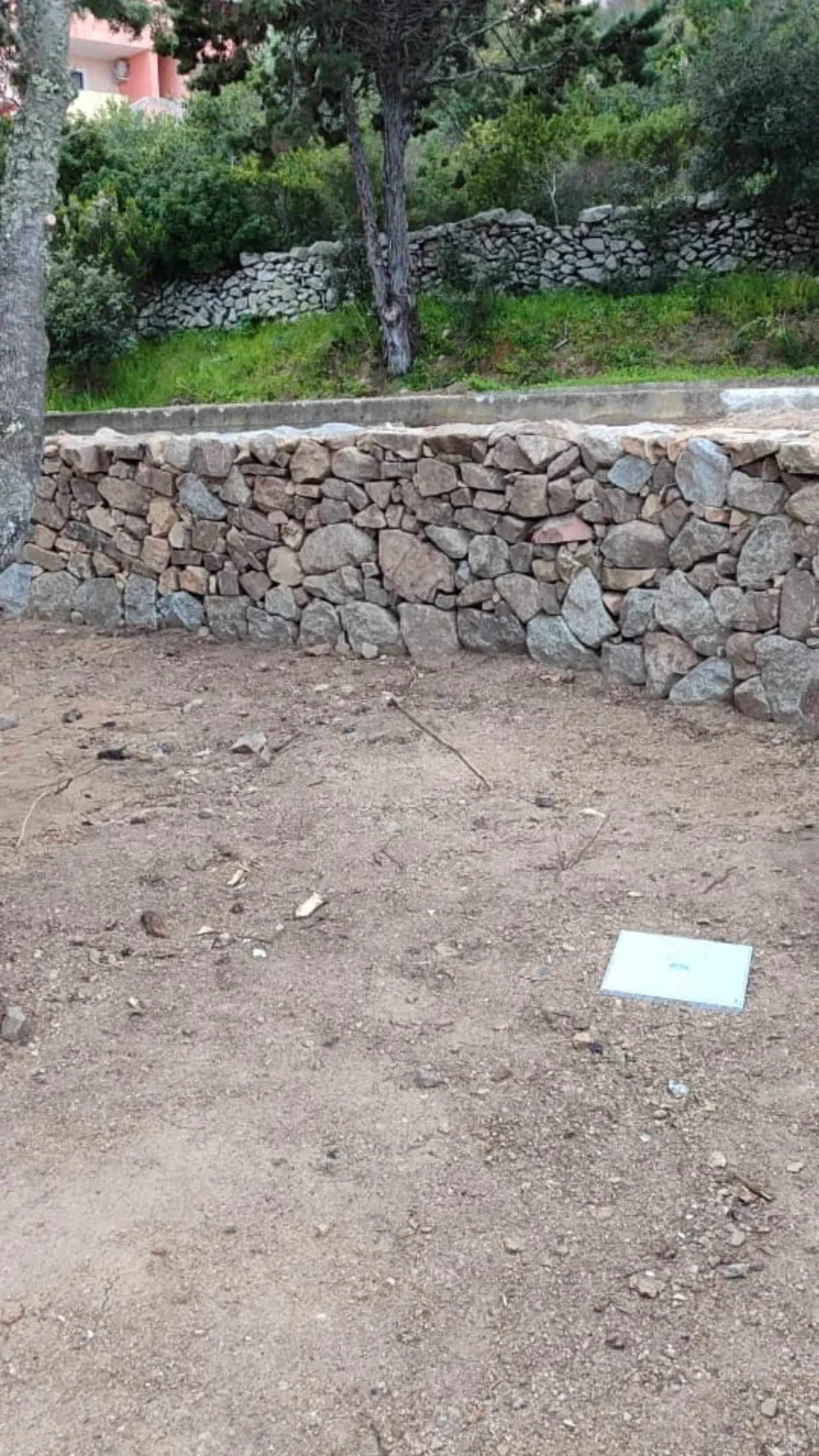

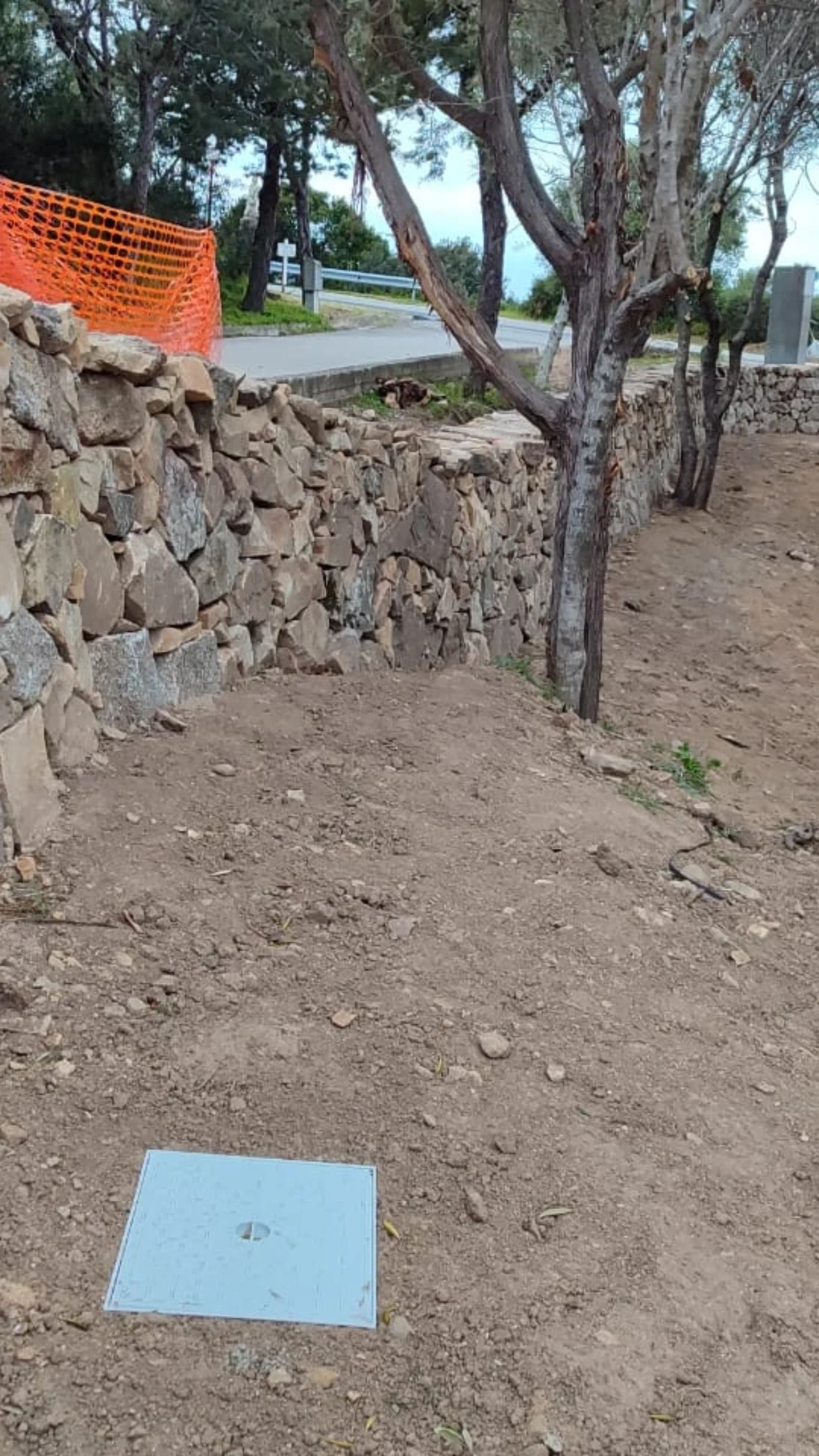

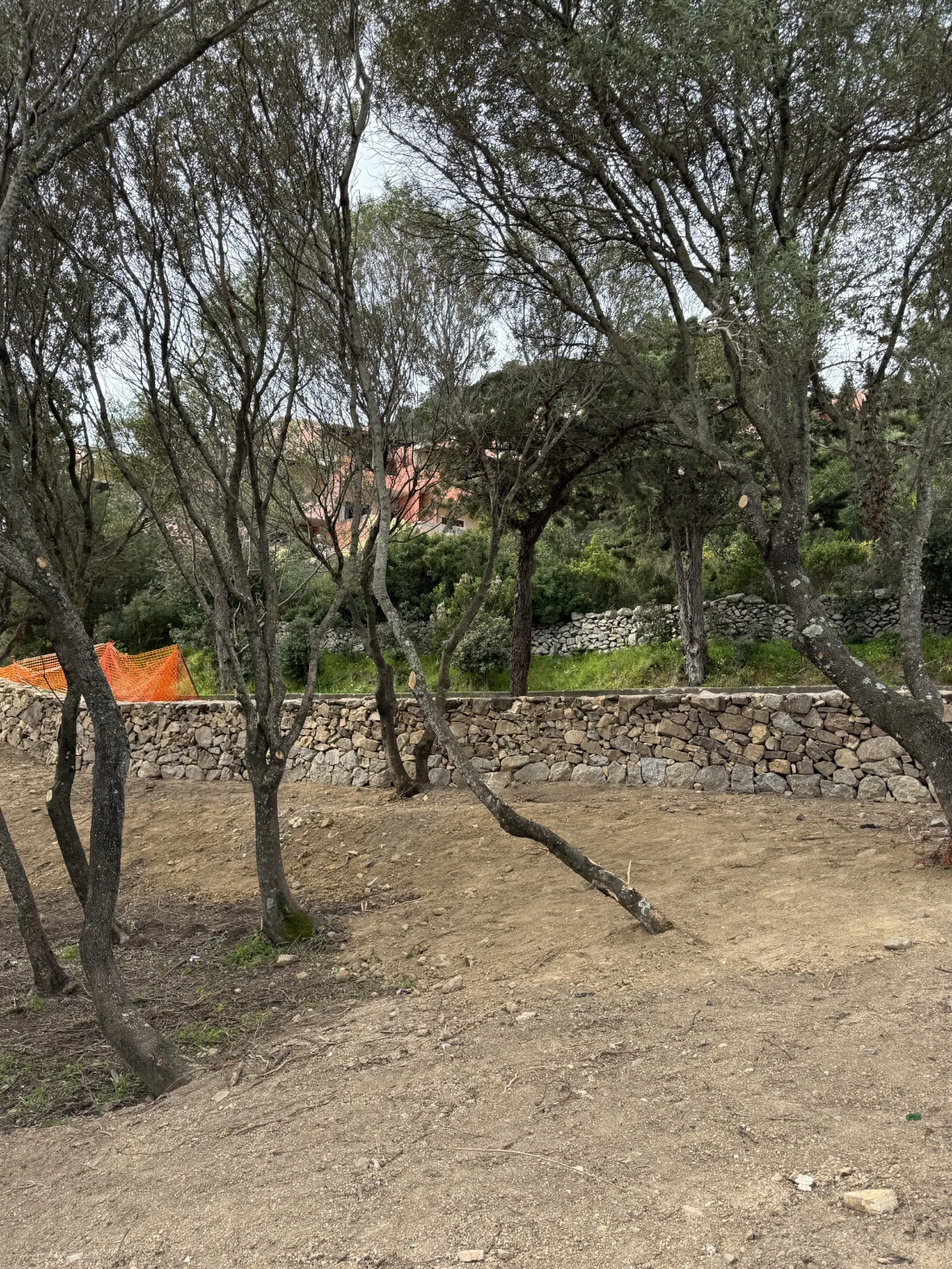

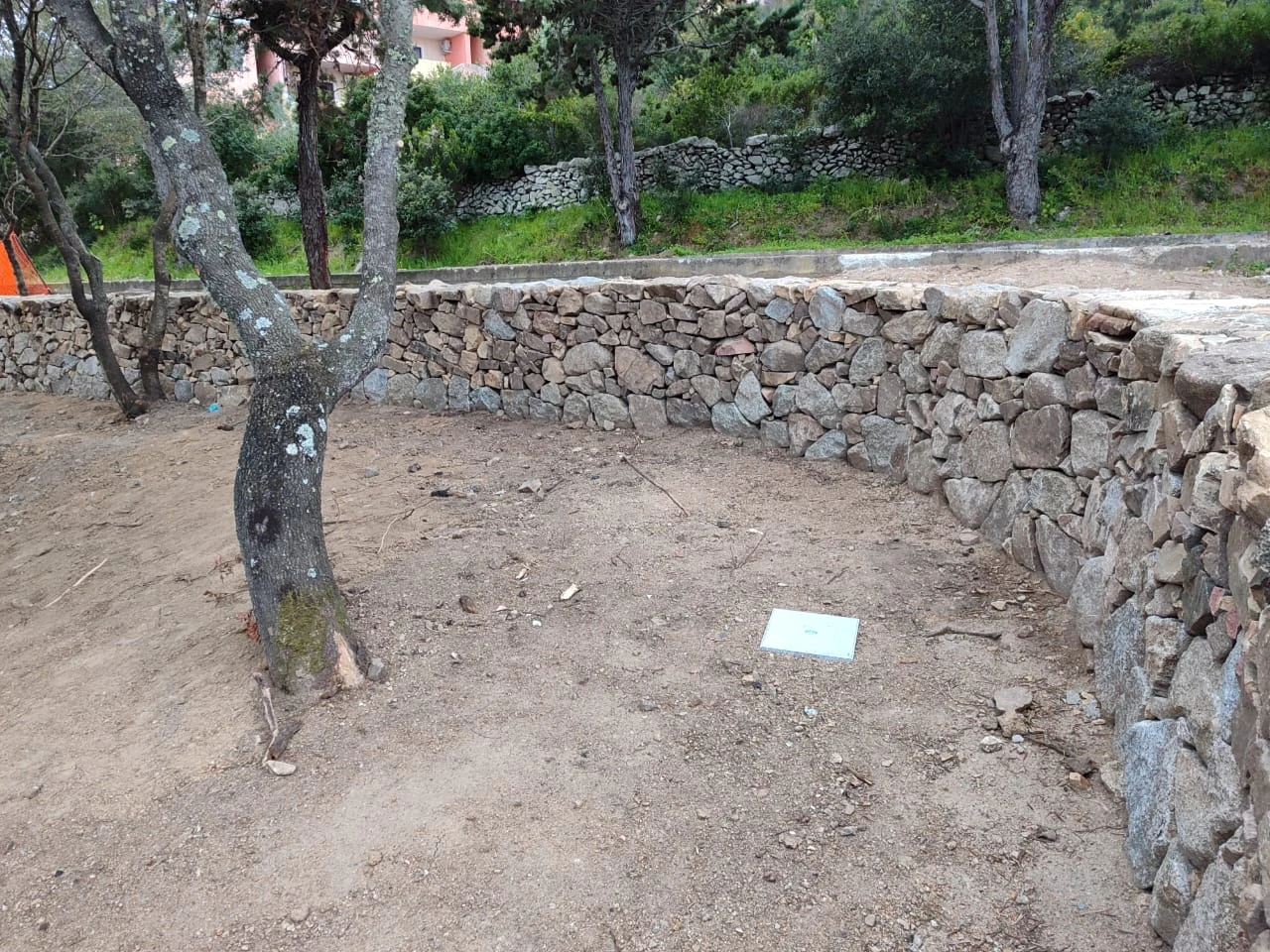

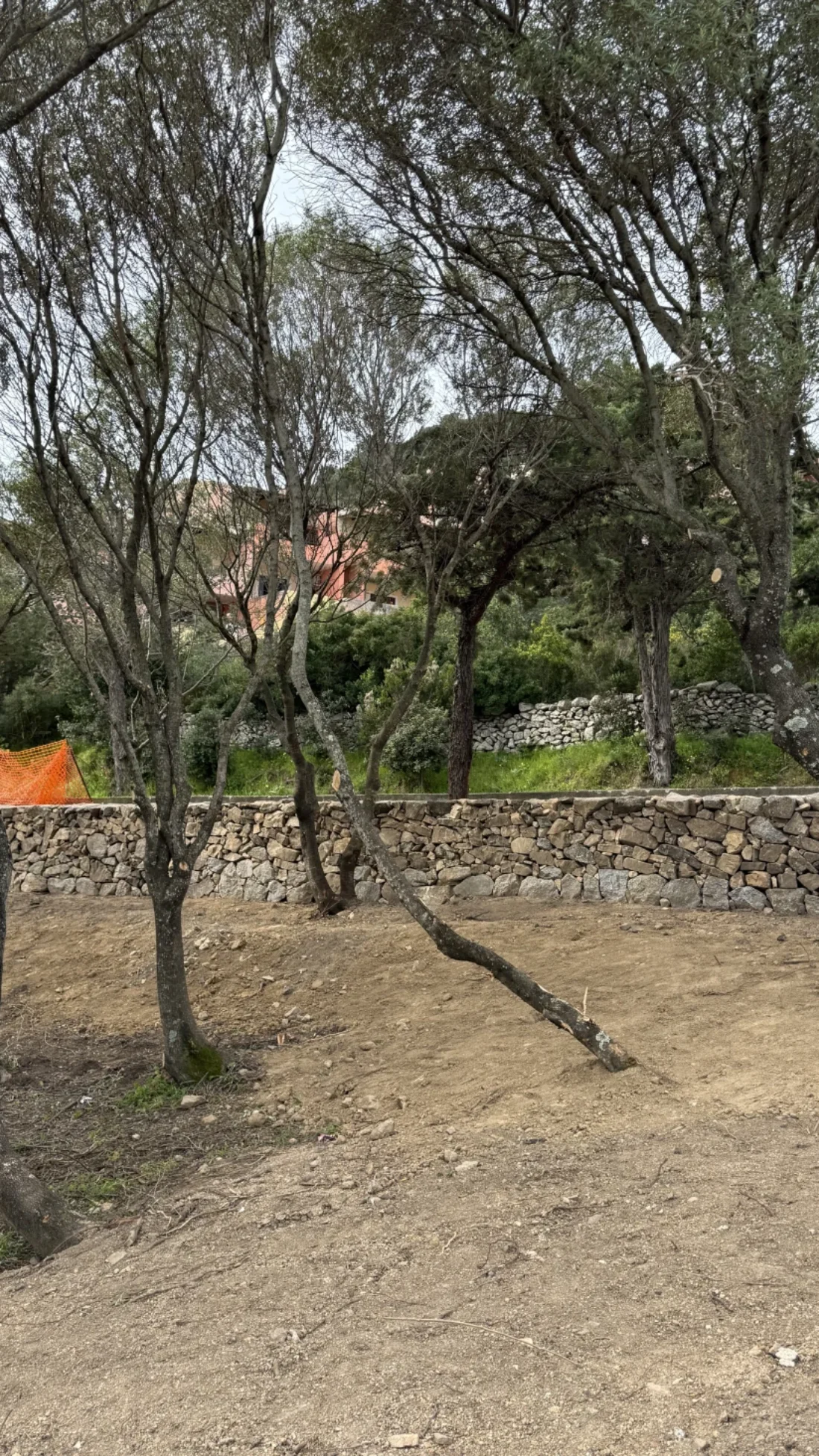

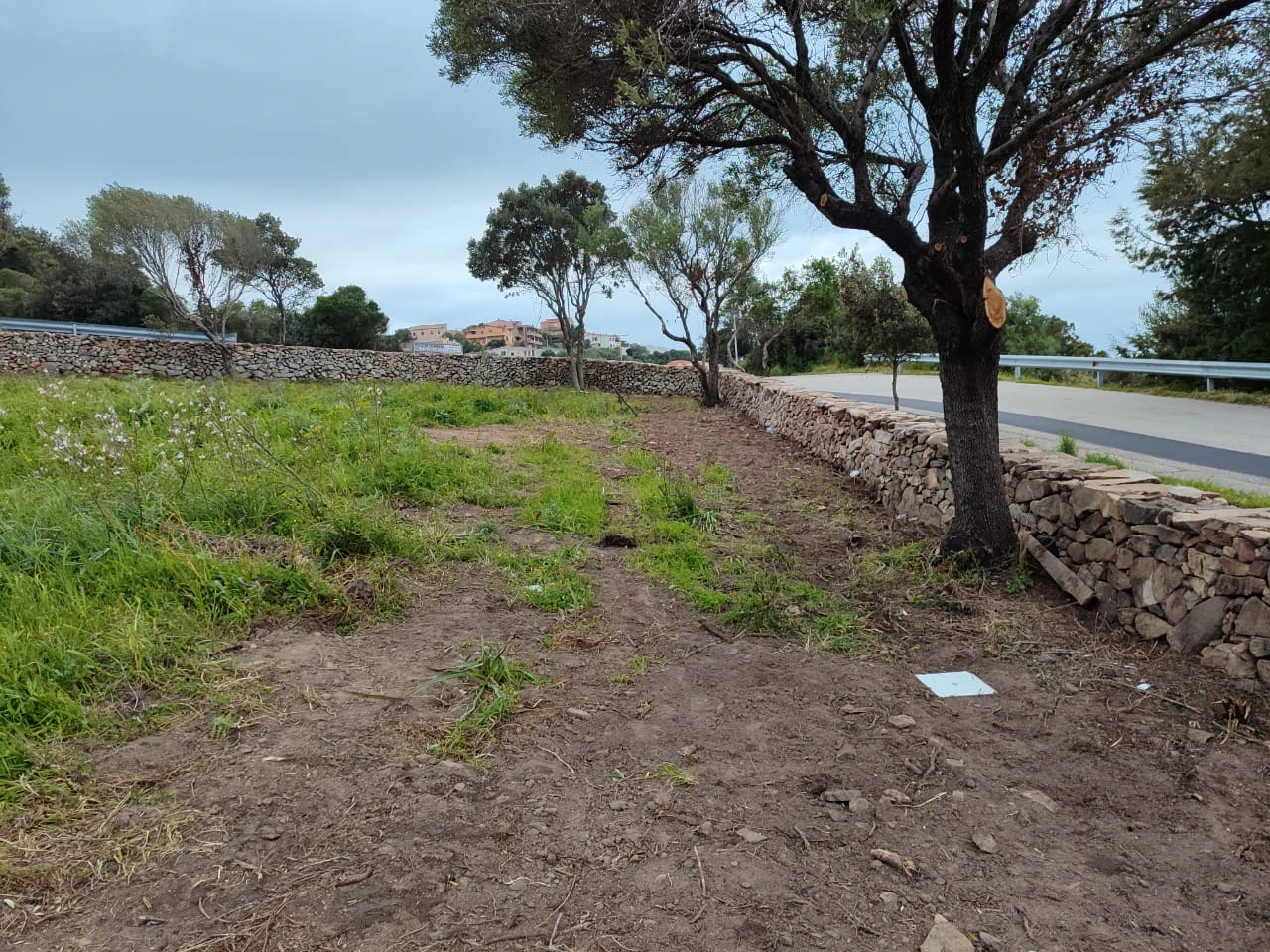

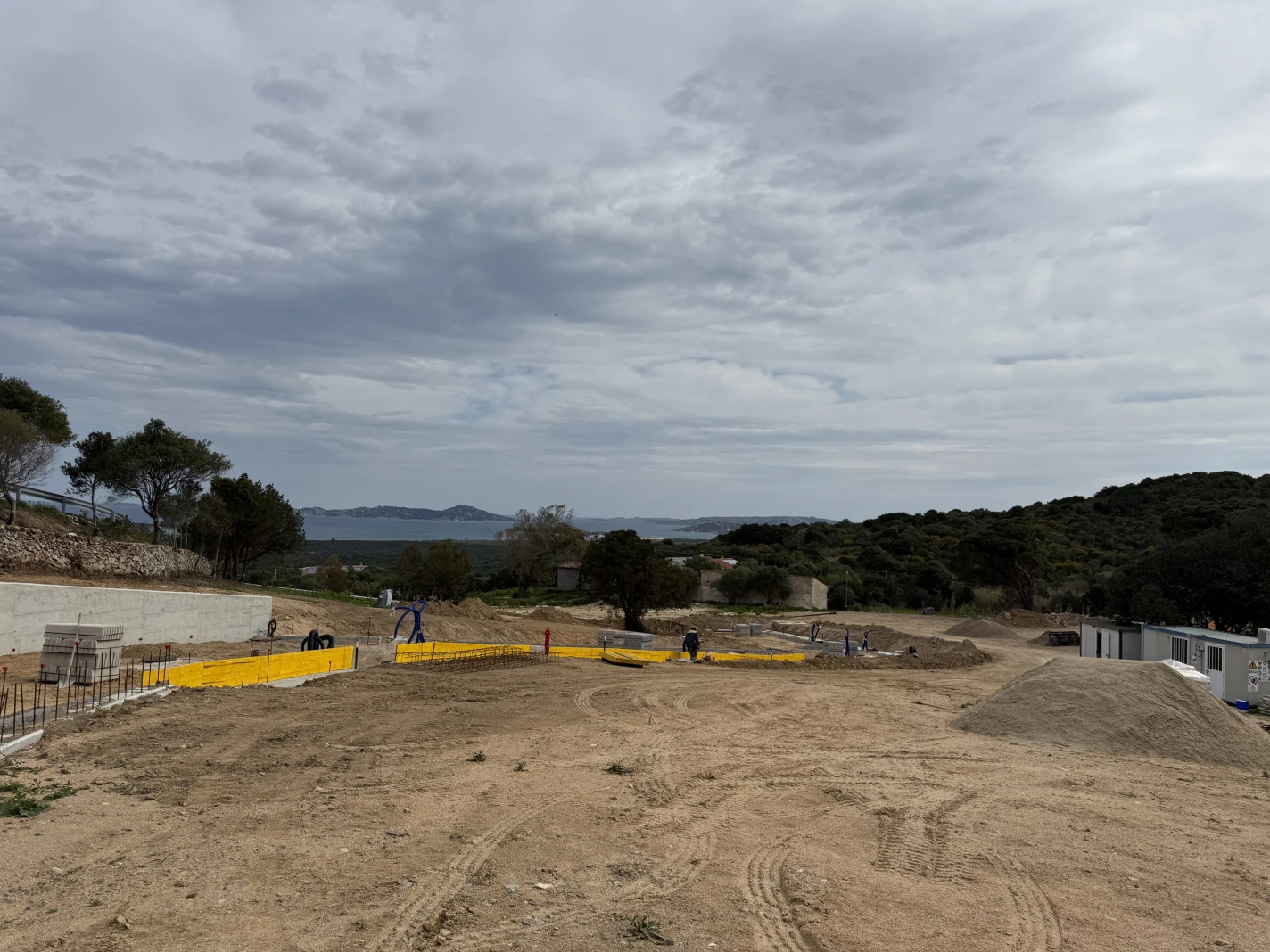

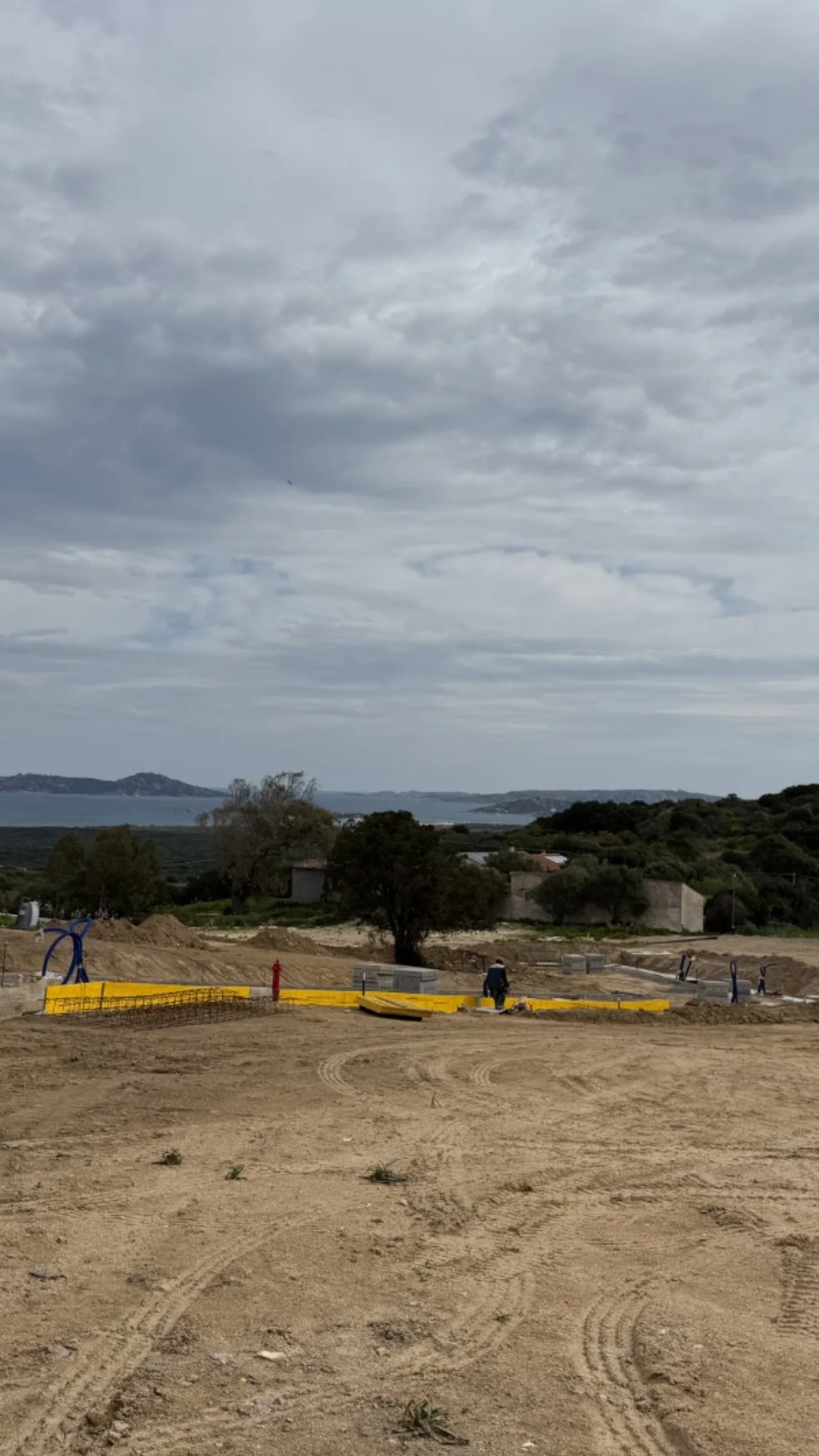

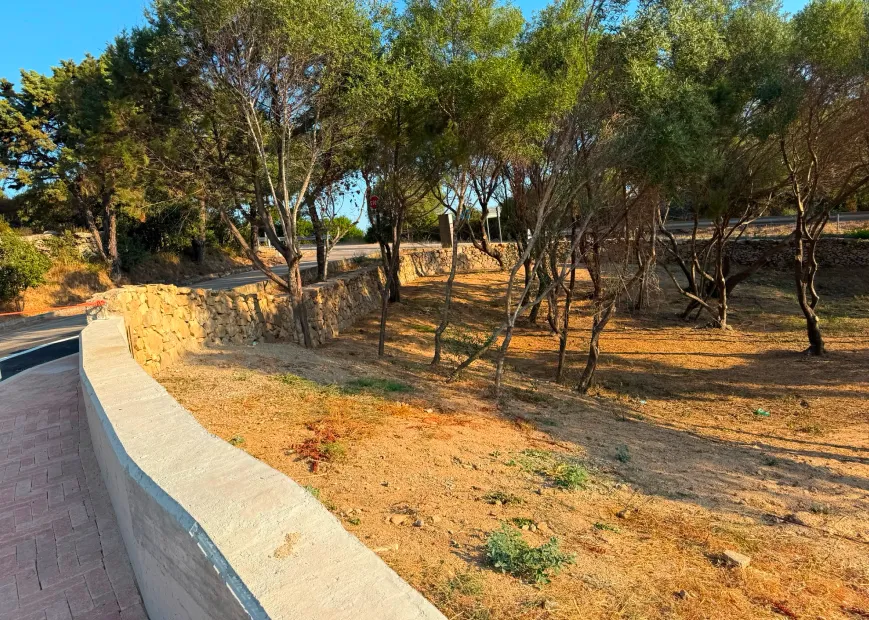

- Restoration and reconstruction of the perimeter stone wall.

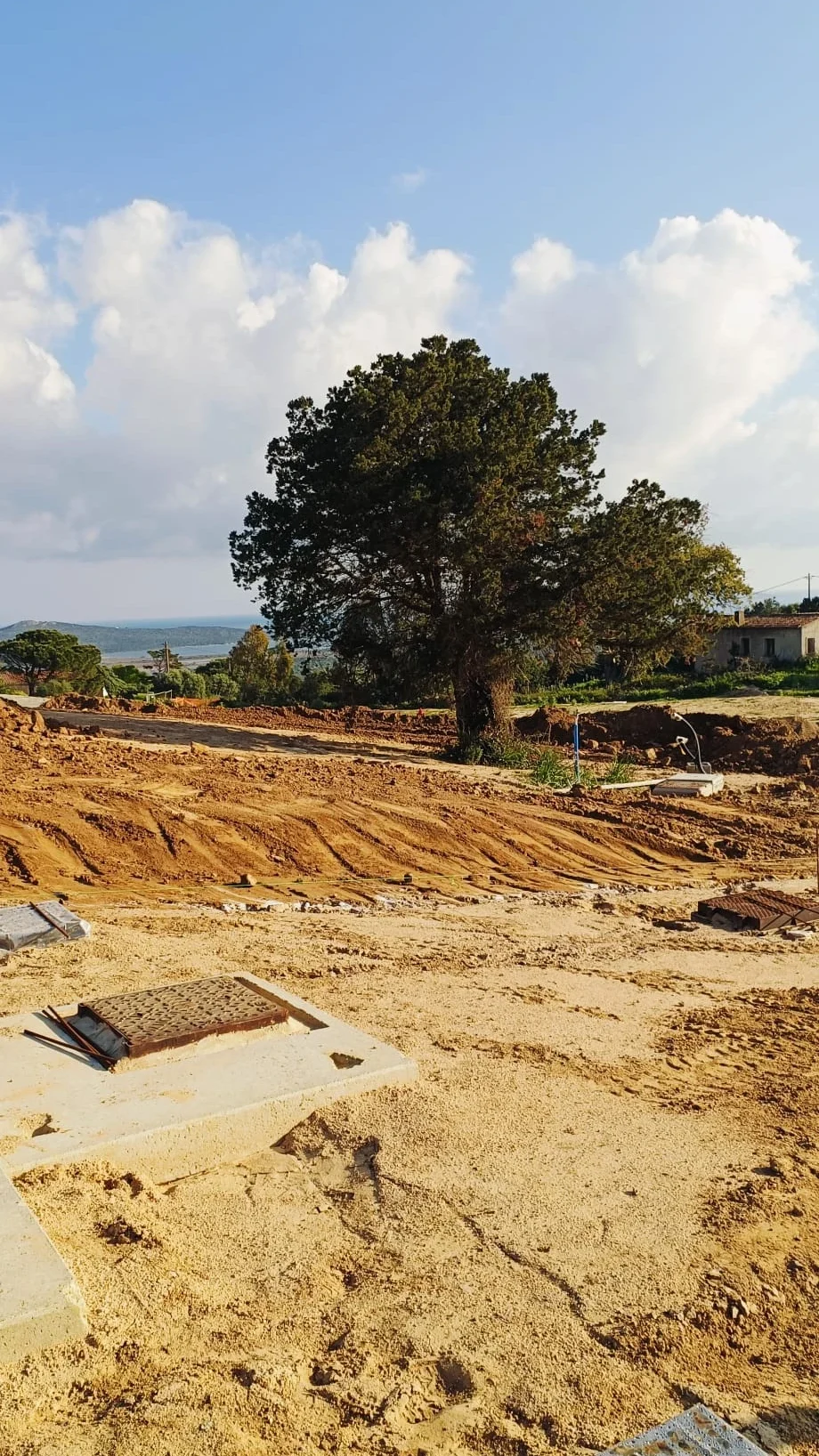

- Plots prepared for the commencement of house construction.
